Thursday, February 29, 2024

01 MAC 2024 HKL

SITE EG MALL

[09:57, 01/03/2024] Azman HKL: Welcome Mr. Frankie from Venus Pool to EGMall site coordination group.
[09:57, 01/03/2024] Kadapi J. PROMES: Aku cuti ni hari guys.



[16:29, 01/03/2024] Azman HKL: Reminder tomorrow safety meeting on site ya. Site PIC please attend

NSC GROUP

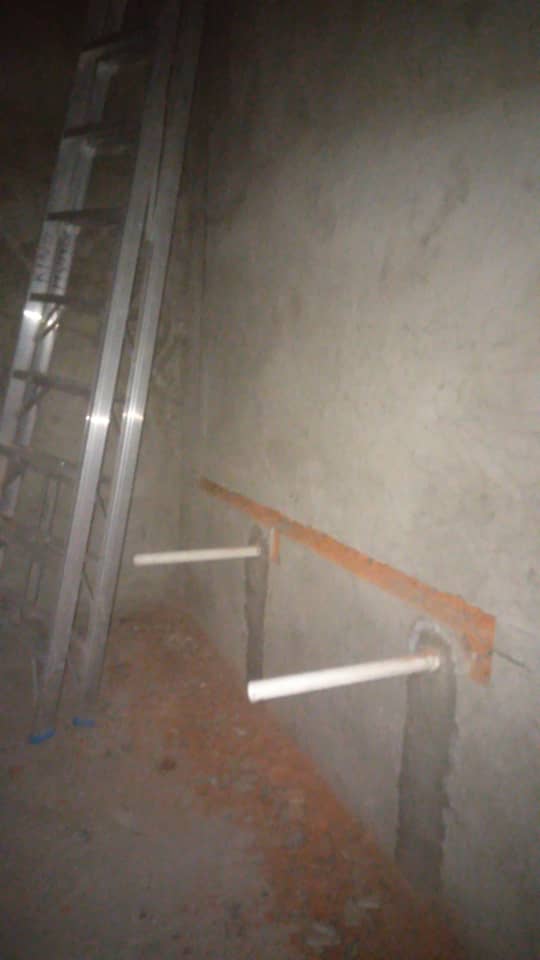

[08:52, 01/03/2024] Azman HKL: Morning. @HIDAYA KH office Num minta tutup itu semua proper tutup itu pipe yang keluar. 🙏🙏
[08:53, 01/03/2024] Azman HKL: Sewer pipe dan Man Hole akan maw start jalan. Kita liaise sama Kinnangland ya di site untuk inlet pipe masuk man hole.
[09:19, 01/03/2024] HIDAYA KH office Num: okay2
[09:49, 01/03/2024] Azman HKL: We share Tower A hotel 4 wall setting from Econmech.
[09:49, 01/03/2024] Azman HKL: This is for 8th - 9th floor.
[09:50, 01/03/2024] Azman HKL: @~Julian Kloneles @King Hong Office please study. @~ShawnChia @HIDAYA KH office Num please advise as per our discussion on site.
[09:54, 01/03/2024] Azman HKL: New Slab Casting Plan
4F - TB4 - 05/3/24
@~.Fazli @~WY @HIDAYA KH office Num please plan accordingly. 🙏



1 MAC 2024




















Wednesday, February 28, 2024

29 FEB 2024 HKL

 NSC GROUP


[08:09, 29/02/2024] Azman HKL: Site progress photo.
29/2/24.
16th floor.TA1. slab rebar in progress.

[08:53, 29/02/2024] Azman HKL: 7th floor. ZP7a. Slab cast.

[11:37, 29/02/2024] Azman HKL: ID meeting at site office meeting room.


[13:35, 29/02/2024] Azman HKL: 16th floor. TA1. Slab rebar and M&E in progress.

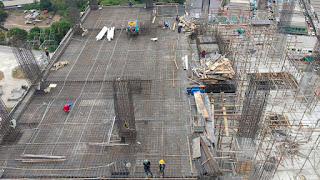

[13:35, 29/02/2024] Azman HKL: 4th floor. TB4. Slab formwork in progress.

26 FEB 2024 HKL

 NSC GROUP



[09:25, 26/02/2024] Azman HKL: Site progress photo.
26/4/24.

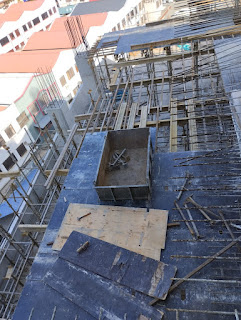

2nd floor. TB6. Slab formwork, rebar and M&E in progress.

[09:25, 26/02/2024] Azman HKL: 7th floor. Slab formwork, beam rebar, escalator pit in progress.

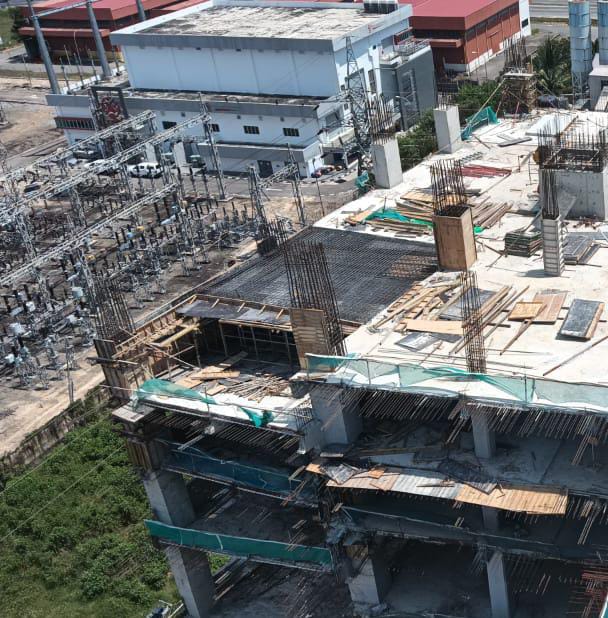

[09:25, 26/02/2024] Azman HKL: 16th floor. TA1, slab formwork in progress, TA2. Lift wall in progress.

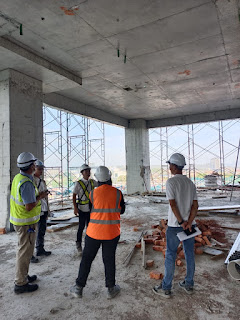

[11:38, 26/02/2024] Azman HKL: Joint inspection and discussion for hotel corridor at 8th floor.

[11:39, 26/02/2024] Azman HKL: 8th floor. Hotel Corridor. As per discussion, we will build a mock up in this area. Trunking, ducting, piping.

[11:39, 26/02/2024] Azman HKL: Service inlet mockup.ducting, trunking

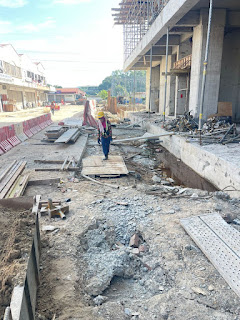

[11:39, 26/02/2024] Azman HKL: 7th floor. Coordination..

[11:39, 26/02/2024] Azman HKL: 4th floor. Sprinkler height discussion.

[14:22, 26/02/2024] Azman HKL: 6th floor, Z7. Slab rebar in progress..

[14:22, 26/02/2024] Azman HKL: 2nd floor, TB6. Slab rebar in progress

[14:25, 26/02/2024] Azman HKL: 7th floor. Zone P7A, slab formwork and beam rebar in progress


29 FEB 2024 HKL

SITE EG MALL

[10:07, 29/02/2024] +60 16-880 4632: Reminder 10.00am Technical meeting for hotel guest Room.
[10:08, 29/02/2024] +60 12-559 6863: give me 5 mins, will be there

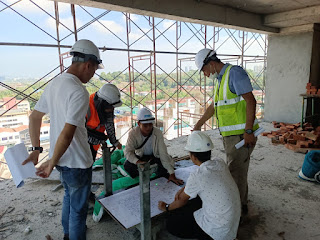

[11:16, 29/02/2024] Azman HKL: ID meeting

[14:06, 29/02/2024] Azman HKL: 16th floor. TA1. Request for inspection at 3pm. @Kadapi J. PROMES . NSC PIC please standby on site during inspection. TQ.
[14:09, 29/02/2024] Kadapi J. PROMES: 👌

 NSC GROUP

[08:09, 29/02/2024] Azman HKL: Site progress photo.
29/2/24.
16th floor.TA1. slab rebar in progress.

[08:53, 29/02/2024] Azman HKL: 7th floor. ZP7a. Slab cast.

[11:37, 29/02/2024] Azman HKL: ID meeting at site office meeting room.

[13:35, 29/02/2024] Azman HKL: 16th floor. TA1. Slab rebar and M&E in progress.

[13:35, 29/02/2024] Azman HKL: 4th floor. TB4. Slab formwork in progress.
[13:56, 29/02/2024] Azman HKL: Archi Drawing for office.

[14:31, 29/02/2024] Jimmy HKL: @HIDAYA KH office Num nie scaffolding kamu pakaikah?
[14:31, 29/02/2024] HIDAYA KH office Num: bukan
[14:32, 29/02/2024] Jimmy HKL: okok

[16:27, 29/02/2024] Azman HKL: 16th floor. TA1. M&E done slab inspection. @~nas4rie @Mr. Voo please proceed.












29 FEB 2024
















EGMALL NSC (23 SEPT 2024)

  EGMALL NSC (23 SEPT 2024) [23/9/2024 9:24 AM] EG MALL Mr Lo: @HIDAYA KH office Num ft ya Sini thanks [23/9/2024 9:24 AM] EG MALL Mr Lo: ...
