Sunday, May 5, 2024

6 MAY 2024 HKL

SITE EG MALL

[11:04, 06/05/2024] Azman HKL: 6th floor. TB4. Request for M&E inspection at 2.30pm. @Kadapi J. PROMES . Site NSC PIC, please stand by at site during inspection. @~Leppong @~WY @~zee @HIDAYA KH office Num





[14:55, 06/05/2024] Kadapi J. PROMES: @Azman HKL, @HIDAYA KH office Num Please do it in properway then only u can proceed witch casting. The base unconpact, the temporary cover unremove yet. Tq
[14:56, 06/05/2024] Azman HKL: Yes ok noted.
[15:01, 06/05/2024] HIDAYA KH office Num: noted boss

[15:04, 06/05/2024] Azman HKL: 6th floor. TB4. M&E inspection in progress.

[16:13, 06/05/2024] Azman HKL: M&E inspection done. @Mr. Voo please proceed.πŸ‘Œ

[20:31, 06/05/2024] +60 16-880 4632: Nobody has the ability to make things perfect all the time.but we are always given chances to make it better.
[20:39, 06/05/2024] Mr. Voo: @~Roxas Ng (Kai)  plz DONE it by tomorrow
[20:39, 06/05/2024] +60 16-880 4632: πŸ‘
[20:40, 06/05/2024] Mr. Voo: Thxs for mention..
[20:41, 06/05/2024] +60 16-832 2597: Ok sir
[20:41, 06/05/2024] Mr. Voo: Make sure u ok is btl btl .. take photo 2morrow during work and after
[20:42, 06/05/2024] Mr. Voo: I want the results
[20:42, 06/05/2024] Mr. Voo: Plz


 NSC GROUP

[08:15, 06/05/2024] Azman HKL: Site progress photo.
6/5/24.
21st floor. TA1. Slab formwork in progress.

[08:15, 06/05/2024] Azman HKL: 6th floor. TB4 . Slab rebar and M&E in progress. TB6. Slab rebar and M&E in progress. 6th floor. TB5. Slab formwork and M&E in progress.
[08:18, 06/05/2024] Azman HKL: We plan to cast the 21st floor. Tower A.   1 times. Please check any slab opening and plinth for the slab and inform HKL so we can coordinate on site before slab cast πŸ™.
[08:25, 06/05/2024] EG MALL ECONMECH Dart: today submit shop drawing for the plinth

[09:12, 06/05/2024] Azman HKL: Ground floor. HV room. @~WY tolong ya itu lubang tutup. πŸ‘†.

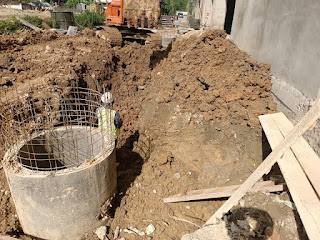

[09:33, 06/05/2024] Azman HKL: External MH 4. Excavation for sewer pipe in progress.

[09:33, 06/05/2024] Azman HKL: External Man Hole. Sewer pipe in progress.

[10:15, 06/05/2024] EG MALL Mr Lo: @HIDAYA KH office Num tolong sambung
[10:16, 06/05/2024] HIDAYA KH office Num: noted mr lo
[13:05, 06/05/2024] +60 16-837 8881: @Azman HKL minta tolong lagi ....
Bulan 3 sudah saya minta , busduct saya tenga bulan ni sampai
[13:06, 06/05/2024] +60 16-837 8881: Under coat dan screeding perlu .......
Barang saya takut air , harap faham .......πŸ™πŸ»
[13:17, 06/05/2024] Azman HKL: Iya. Sekarang kami atur subcon lain untuk kasi siap dia. πŸ™.
[13:20, 06/05/2024] +60 16-837 8881: Tq
[13:56, 06/05/2024] +60 12-559 6863: @Azman HKL @~ShawnChia ID consultant sudah sampai, mari bilik meeting sekarang

[14:04, 06/05/2024] Azman HKL: Iya. Sini bilik meeting sda.

[15:27, 06/05/2024] Azman HKL: Cast Iron pipe thru MH6. @HIDAYA KH office Num please rectify as per consultant comment. πŸ™

[15:28, 06/05/2024] HIDAYA KH office Num: rectification works in progress

[16:13, 06/05/2024] Azman HKL: M&E inspection done. @Mr. Voo please proceed.πŸ‘Œ

[16:32, 06/05/2024] Azman HKL: 21st floor. Slab rebar in progress

[16:34, 06/05/2024] Azman HKL: 3rd floor. Z8. Slab formwork
