[11:06, 18/01/2024] Azman HKL: Site progress photo.
18/1/24.

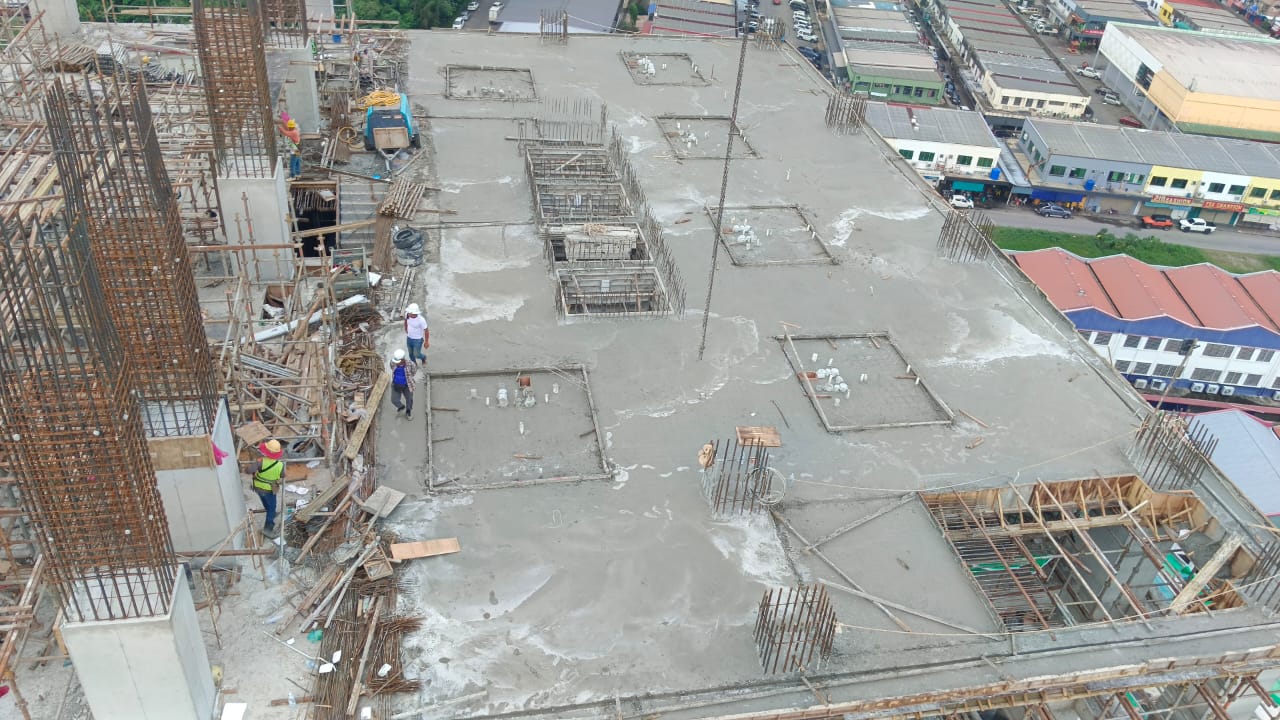

12th floor. TA2. Slab cast.
[11:06, 18/01/2024] Azman HKL: 13th floor. TA1. Slab formwork in progress.
[11:06, 18/01/2024] Azman HKL: Ground floor. TB6. Slab formwork in progress. Basement. Z9. Retaining wall formwork in progress.
[11:06, 18/01/2024] Azman HKL: 4th floor. Ramp 6. Slab rebar in progress. 5th floor. Z7. Slab rebar and M&E in progress. 6th floor. Z6. Slab cast.
