Friday, December 29, 2023

29 DEC 2023 HKL

SITE EG MALL
[14:31, 29/12/2023] Azman HKL: 4th floor. Z7. Request for inspection M&E services at 3pm.

[15:22, 29/12/2023] Kadapi J. PROMES: @Azman HKL @~nas4rie @~π‘…π’Άπ“Ž π’žπ’½π‘œπ“ƒπ‘” Its over 3 pm as request for inspection, unfortunatly rebar not yet done and the conduit installation still pending for your rebar works.πŸ€”
[15:25, 29/12/2023] Azman HKL: Noted, saya sangka sempat siap. Ramp portion belum siap ikat besi. Mereka sambung lepas rehat. Request reinspect jam 4pm. πŸ™πŸ™πŸ™

[16:12, 29/12/2023] Kadapi J. PROMES: Fire Alarm conduit belum sambung.



NSC GROUP

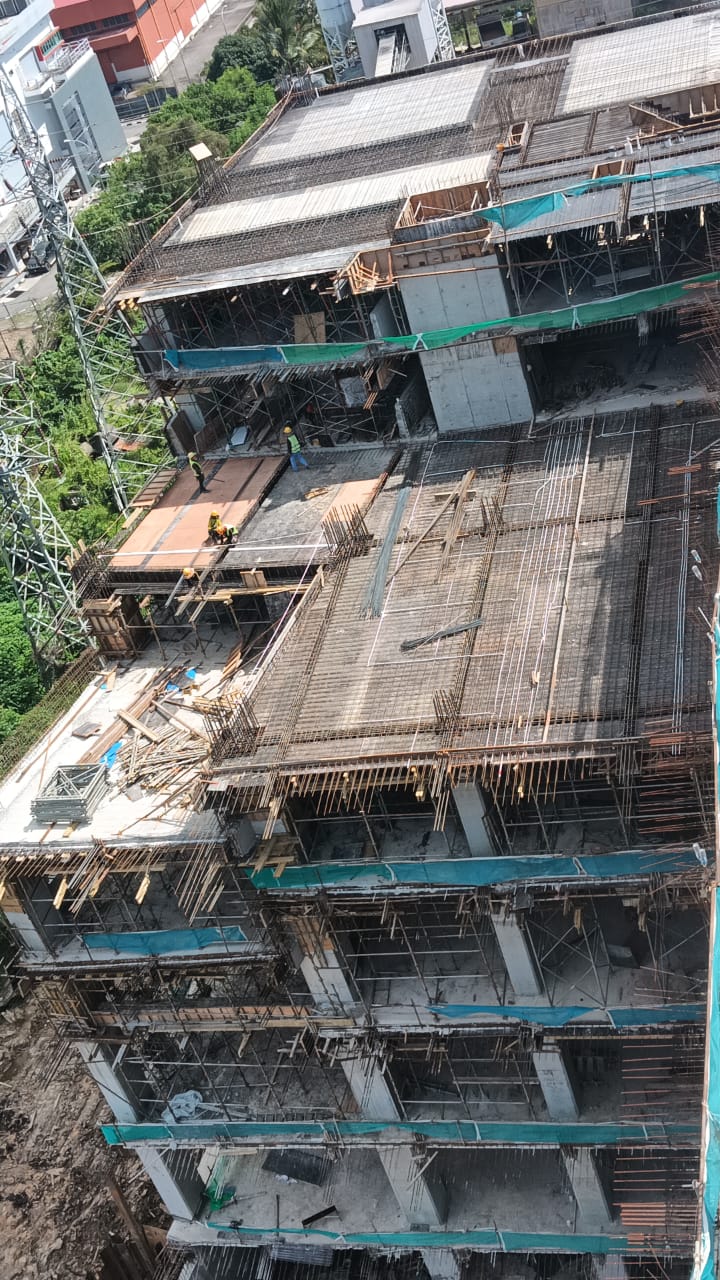

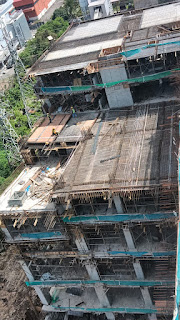

 [10:11, 29/12/2023] Azman HKL: Site progress photo.
29/12/2023.

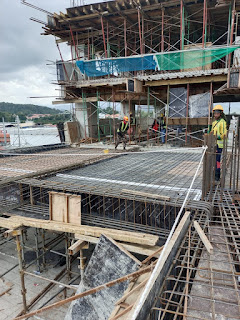

4th floor. Z7. Slab rebar  and formwork in progress. 6th floor. Z6. Slab rebar in progress.


[10:11, 29/12/2023] HIDAYA KH office Num: @Azman HKL request for site clearing

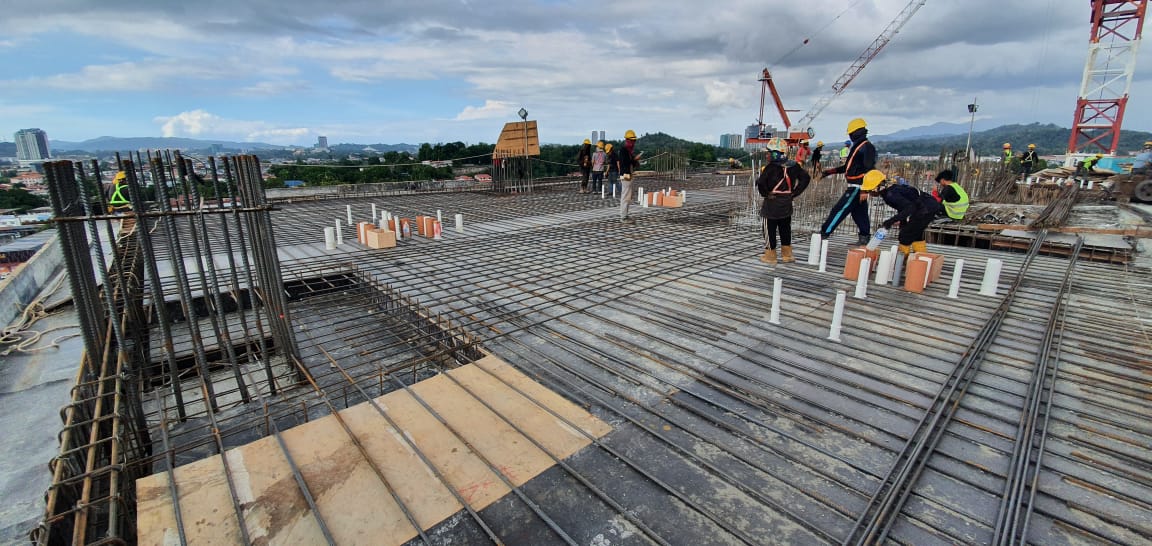

[10:15, 29/12/2023] Azman HKL: 10th floor. TA1. Column rebar and formwork in progress. TA2. Slab formwork and clearance in progress.

[10:15, 29/12/2023] Azman HKL: 6th floor. TB5. Slab rebar in progress.

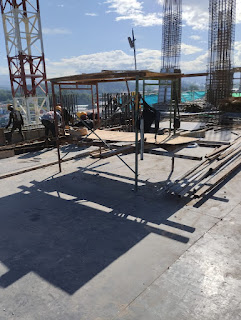

[10:26, 29/12/2023] Azman HKL: Plumbing pipe sleeve in progress.
[10:47, 29/12/2023] Azman HKL: New Casting Plan
6F - Z6 - 23/12/23 TBU
4F - Z7 - 29/12/23 (today)πŸ‘ˆ
6F - TB5 - 30/13/2023 πŸ‘ˆ
10F - TA/1 - 27/12/23✅
10F - TA/2 - 30/12/23πŸ‘ˆ

πŸ‘ˆ=Changes
Please take note this casting changes and inform any difficulty.
@~ShawnChia @~Leppong  @HIDAYA KH office Num @Leung KHπŸ€  @~Walker Yapi @Dart Econmech




[11:16, 29/12/2023] +60 17-866 0355: 10th TA2  bos  belum ada besi
[11:20, 29/12/2023] +60 17-866 0355: besok maw kongkrit
[11:22, 29/12/2023] +60 16-837 8881: @Azman HKL
Minta tolong bagi masa MnE kerja πŸ™πŸ»πŸ™πŸ»
[11:23, 29/12/2023] +60 16-837 8881: Esok casting , sekarang besi langsung belum ada .....
Kami tak dapat bubut macam ni
[13:55, 29/12/2023] Azman HKL: Iya noted. Kami sedang push subcon tukang besi untuk siap kan kerja supaya M&E boleh mula kerja. @Dart Econmech ada inform juga dan kami ada bincang sama Subcon juga di site tadi.
[14:09, 29/12/2023] Azman HKL: Kami faham, perubahan drastik kepada casting plan (oleh sebab tdk dijangka) memberi kesan kepada semua yang terlibat. Walaubagaimanapun kita masih berusaha bersama-sama beberapa kali ini untuk mencapai target dan oleh itu kami amat sangat menghargai kerjasama dan perhatian anda. πŸ™πŸ™πŸ™

[15:00, 29/12/2023] Azman HKL: 10th floor. TA2. Slab rebar in progress.

[15:01, 29/12/2023] Azman HKL: 4th floor. Z7. Slab rebar and M&E  in progress

[15:13, 29/12/2023] Azman HKL: 4th floor. Z7. M&E inspection in progress
