Saturday, December 30, 2023
31 DEC 2023 HKL
NSC GROUP
[11:35, 31/12/2023] Azman HKL: Site progress photo
31/12/2023.

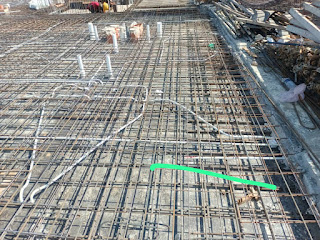

10th floor. TA2. Slab casted.
[11:35, 31/12/2023] Azman HKL: 11th floor. TA1. Slab formwork in progress.
[11:35, 31/12/2023] Azman HKL: 6th floor. TB5. Slab cast.
[11:35, 31/12/2023] Azman HKL: 6th floor. Z6. Slab rebar in progress.
[11:41, 31/12/2023] +60 12-559 6863: TA/1 11F target casting 04/01/24
Friday, December 29, 2023
30 DEC 2023 HKL
SITE EG MALL
[10:24, 30/12/2023] Azman HKL: 6th floor. TB5. Request for inspection M&E services at 2pm.
[10:25, 30/12/2023] Azman HKL: 10th floor. TA2. M&E services are in progress.
[10:32, 30/12/2023] Azman HKL: @Dart Econmech @~Walker Yapi please chase your subcon to complete their electrical conduit. ππ
[10:32, 30/12/2023] Dart Econmech: Ya sdg atur man. Nt team aku turun bt. Dorg d L10 kjp lg turun
NSC GROUP
[08:55, 30/12/2023] Azman HKL: Site progress photo.
30/12/2023.
10th floor. TA2. Slab rebar and M&E in progress.
[08:55, 30/12/2023] Azman HKL: 11th floor. TA1. Slab formwork in progress. Column rebar in progress.
[08:55, 30/12/2023] Azman HKL: 6th floor. TB5. Slab rebar and M&E in progress.
[08:55, 30/12/2023] Azman HKL: 4th floor. Z7. Slab casted. 6th floor. Z6. Slab rebar in progress.
[08:57, 30/12/2023] +60 12-559 6863: New Casting Plan
6F - Z6 - 23/12/23 TBU
4F - Z7 - 29/12/23✅
6F - TB5 - 30/13/2023 π
10F - TA/1 - 27/12/23✅
10F - TA/2 - 30/12/23π
[08:58, 30/12/2023] +60 12-559 6863: Dear all, kindly work together to achieve these 2 casting today to close our 2023 with good omens ya, thank you
[08:58, 30/12/2023] +60 12-559 6863: and start the 2024 with greater progress and achievements for allπππ
[10:15, 30/12/2023] Azman HKL: Morning. @~Walker Yapi @~Rimon Joseph fire and Acmv conduit. Tolong push kamu punya subcon. Ini belum jalan..
[10:39, 30/12/2023] +60 16-832 2597: @~Walker Yapi kindly update us next time for future erection of scaffolding.. was querying around to found out.. so can avoid future issues from occurring Tq
[10:45, 30/12/2023] Azman HKL: @~Walker Yapi @~Rimon Joseph tolong ya atur dan inform HKL atau SSS dulu..
[11:43, 30/12/2023] Lo. W. H (HKL-Site Engineer): @HIDAYA KH office Num any flow trap photo work done for the casting tonight
[11:47, 30/12/2023] HIDAYA KH office Num: none
[14:11, 30/12/2023] Azman HKL: 10th floor. TA2. Slab rebar and M&E in progress.
[14:11, 30/12/2023] Azman HKL: 11th floor. TA2. Slab formwork in progress.
[14:11, 30/12/2023] Azman HKL: 6th floor. Z6. Slab rebar in progress.
[14:29, 30/12/2023] Azman HKL: 6th floor. TB5. M&E inspection in progress.
[14:37, 30/12/2023] Azman HKL: Done inspection. @~nas4rie please proceed π
[14:47, 30/12/2023] Azman HKL: 10th floor. TA2. M&E services pre-inspection in progress.
[15:56, 30/12/2023] Azman HKL: 10th floor. TA2. Fire and Acmv services inspection in progress.
[16:00, 30/12/2023] Azman HKL: M&E inspection done. @~nas4rie please proceed.. ππͺππ». TQ all.
29 DEC 2023 HKL
SITE EG MALL
[14:31, 29/12/2023] Azman HKL: 4th floor. Z7. Request for inspection M&E services at 3pm.
[15:22, 29/12/2023] Kadapi J. PROMES: @Azman HKL @~nas4rie @~π
πΆπ ππ½πππ Its over 3 pm as request for inspection, unfortunatly rebar not yet done and the conduit installation still pending for your rebar works.π€
[15:25, 29/12/2023] Azman HKL: Noted, saya sangka sempat siap. Ramp portion belum siap ikat besi. Mereka sambung lepas rehat. Request reinspect jam 4pm. πππ
[16:12, 29/12/2023] Kadapi J. PROMES: Fire Alarm conduit belum sambung.
NSC GROUP
[10:11, 29/12/2023] Azman HKL: Site progress photo.
29/12/2023.
4th floor. Z7. Slab rebar and formwork in progress. 6th floor. Z6. Slab rebar in progress.
[10:11, 29/12/2023] HIDAYA KH office Num: @Azman HKL request for site clearing
[10:15, 29/12/2023] Azman HKL: 10th floor. TA1. Column rebar and formwork in progress. TA2. Slab formwork and clearance in progress.
[10:15, 29/12/2023] Azman HKL: 6th floor. TB5. Slab rebar in progress.
[10:26, 29/12/2023] Azman HKL: Plumbing pipe sleeve in progress.
[10:47, 29/12/2023] Azman HKL: New Casting Plan
6F - Z6 - 23/12/23 TBU
4F - Z7 - 29/12/23 (today)π
6F - TB5 - 30/13/2023 π
10F - TA/1 - 27/12/23✅
10F - TA/2 - 30/12/23π
π=Changes
Please take note this casting changes and inform any difficulty.
@~ShawnChia @~Leppong @HIDAYA KH office Num @Leung KHπ @~Walker Yapi @Dart Econmech
[11:16, 29/12/2023] +60 17-866 0355: 10th TA2 bos belum ada besi
[11:20, 29/12/2023] +60 17-866 0355: besok maw kongkrit
[11:22, 29/12/2023] +60 16-837 8881: @Azman HKL
Minta tolong bagi masa MnE kerja ππ»ππ»
[11:23, 29/12/2023] +60 16-837 8881: Esok casting , sekarang besi langsung belum ada .....
Kami tak dapat bubut macam ni
[13:55, 29/12/2023] Azman HKL: Iya noted. Kami sedang push subcon tukang besi untuk siap kan kerja supaya M&E boleh mula kerja. @Dart Econmech ada inform juga dan kami ada bincang sama Subcon juga di site tadi.
[14:09, 29/12/2023] Azman HKL: Kami faham, perubahan drastik kepada casting plan (oleh sebab tdk dijangka) memberi kesan kepada semua yang terlibat. Walaubagaimanapun kita masih berusaha bersama-sama beberapa kali ini untuk mencapai target dan oleh itu kami amat sangat menghargai kerjasama dan perhatian anda. πππ
[15:00, 29/12/2023] Azman HKL: 10th floor. TA2. Slab rebar in progress.
[15:01, 29/12/2023] Azman HKL: 4th floor. Z7. Slab rebar and M&E in progress
[15:13, 29/12/2023] Azman HKL: 4th floor. Z7. M&E inspection in progress
Subscribe to:
Posts (Atom)
EGMALL NSC (23 SEPT 2024)
EGMALL NSC (23 SEPT 2024) [23/9/2024 9:24 AM] EG MALL Mr Lo: @HIDAYA KH office Num ft ya Sini thanks [23/9/2024 9:24 AM] EG MALL Mr Lo: ...
-
SITE EG MALL [11:28, 14/03/2024] +60 16-880 4632: Jackson.. protruding column can hack to flush wall.. [11:31, 14/03/2024] +60 16-880 4632: ...
