Tuesday, June 27, 2023

28 JUNE 23 HKL

SITE GROUP

Azman HKL: Good morning πŸŒ„.
Site progress picture today.
28/06/2023.

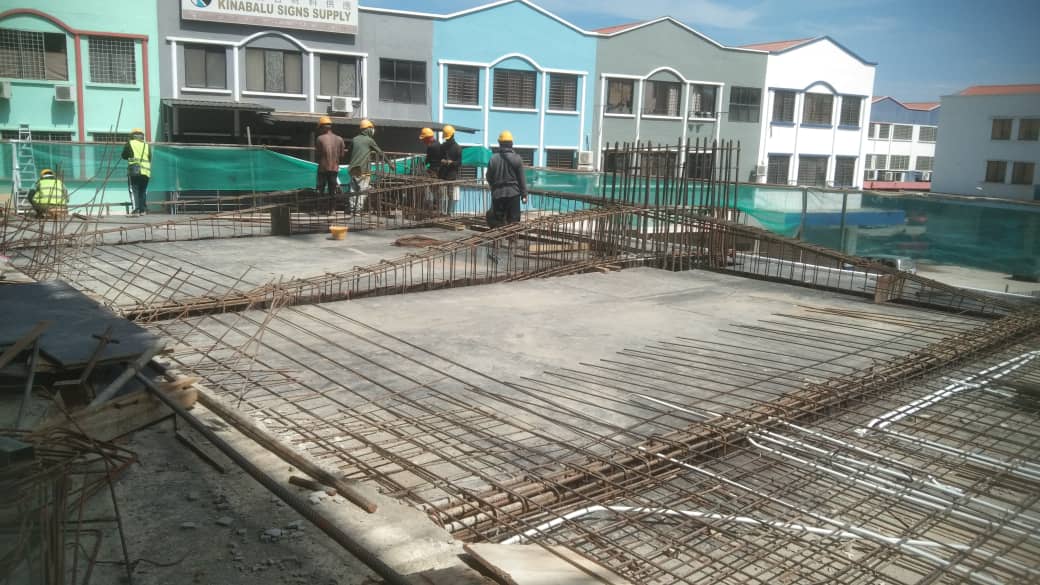

1. Basement, zone 8a. Slab cast.

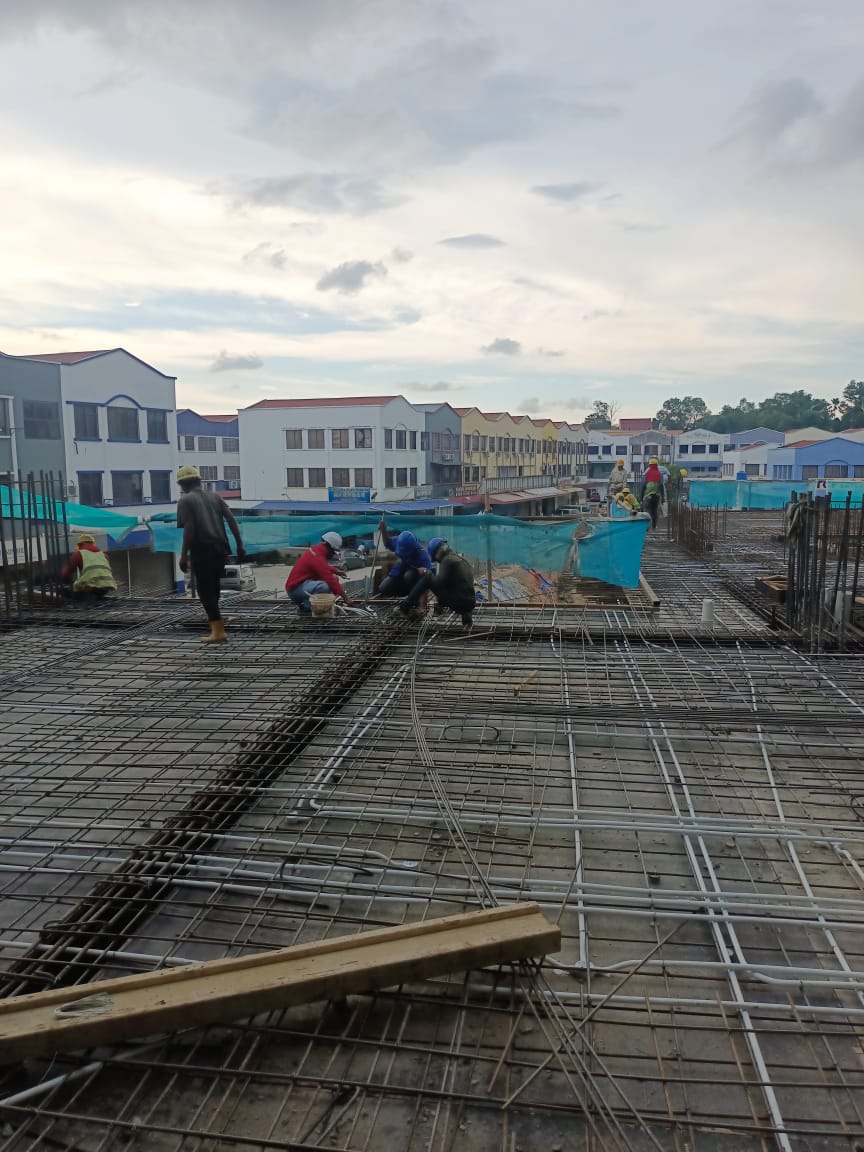

Azman HKL: 2. 1st floor. Zone TA1. Slab bottom rebar & M&E services in progress.

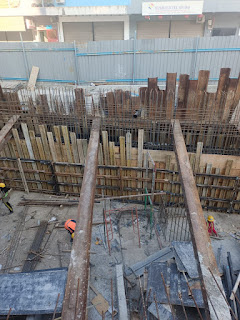

 Azman HKL: Basement. Zone 2a. Wall retaining formwork in progress. 1st Cast target by today.
 Azman HKL: 4tg floor zone 4. Slab formwork in progress.
Azman HKL: 4th floor. Zone 5a. Slab bottom rebar in progress.
Azman HKL: 4th floor. Zone 5b. Slab formwork in progress.
Azman HKL: 5th floor. Lift wall formwork and column formwork in progress.
 Azman HKL: 4th floor. TB1. Slab formwork in progress.
 Azman HKL: Basement. 2c. Slab cast.
Azman HKL: @Kadapi J. PROMES bossku. Request M&E inspection. 1st floor. TA1b. 3.00pm ni.

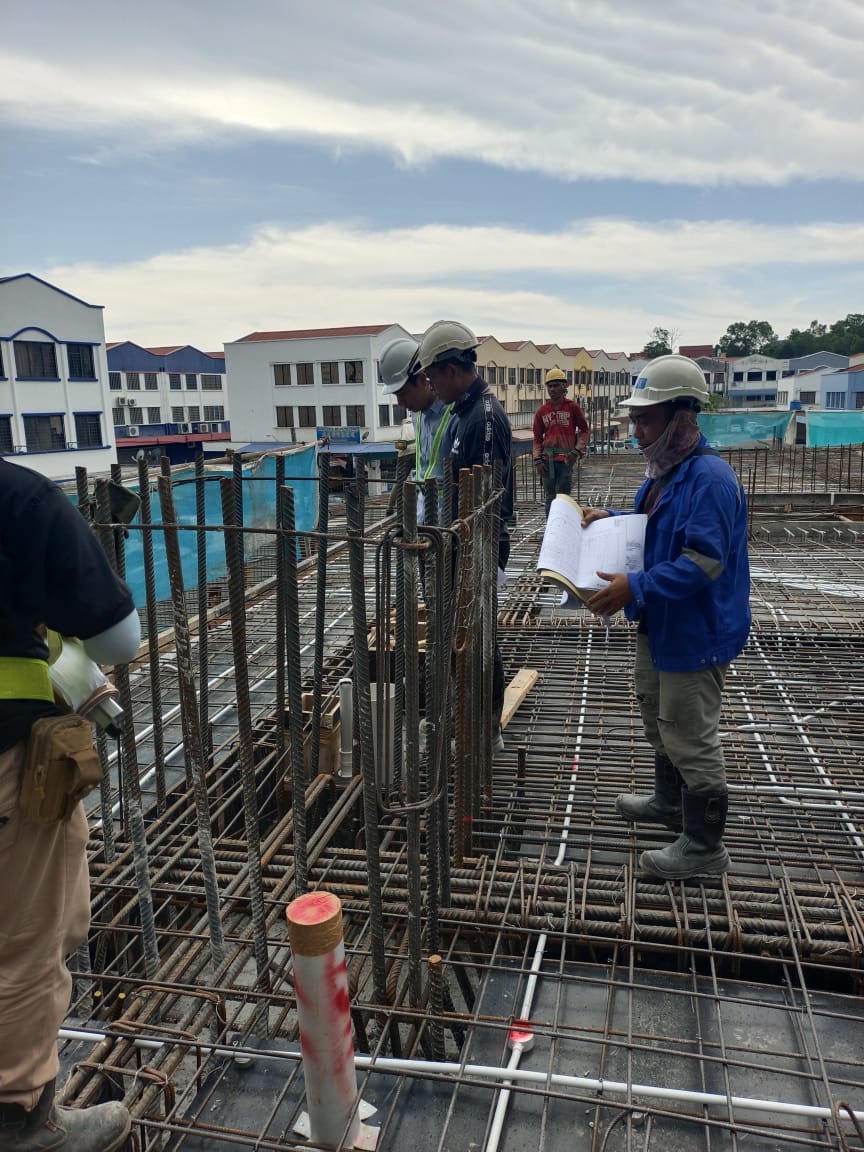

Azman HKL: 1st floor, zone TA1b, M&E inspection with consultant in progress.



NSC GROUP

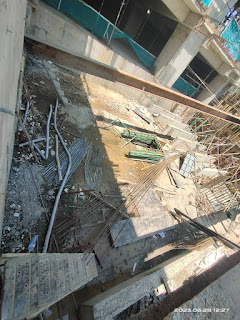

Azman HKL: @~Walker Yapi ini sedang clearing. Nanti kamu marking plinth satu kali cast ni hari. Jumpa sama Fatt sana. GnB saya sda inform itu.
Lo. W. H (HKL-Site Engineer): @Azman HKL ngamkah sana mahu ada tap water supply
Lo. W. H (HKL-Site Engineer): sekarang kita punya retaining wall limpas gridline G kan

Azman HKL: Hi.. next report please use this format for daily report. Thanks..πŸ™
Azman HKL: Iya. Kena sda. Ini grid line G.
Lo. W. H (HKL-Site Engineer): Ok

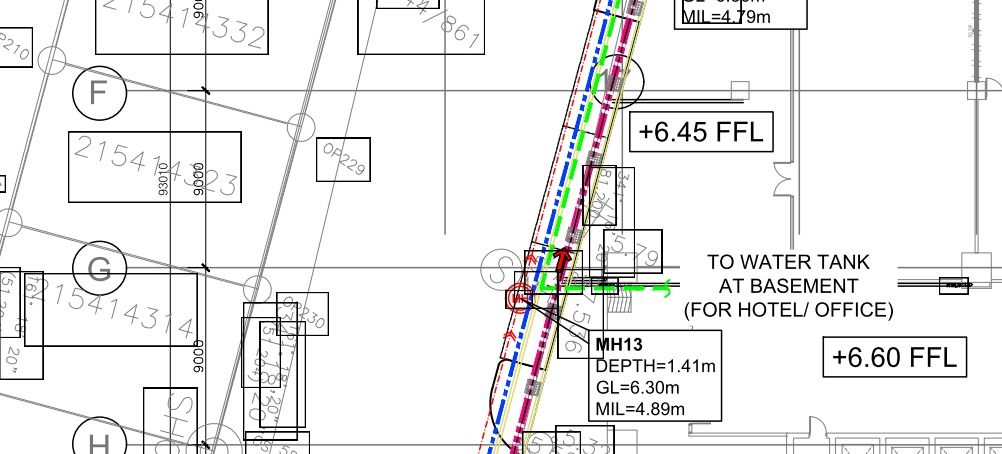

Azman HKL: Yellow- ELV, orange-plumbing, blue- water rec. Please double check. Incoming and outlet at retaining wall.πŸ‘†
+60 12-843 3877: Rebar sedan buat.belum dapat jalan conduit
+60 14-379 2990: @Azman HKL masi ada besi sma scaffolding.
Azman HKL: Sy inform sama GnB tolong kasi clear. Tapi kalau kecil2 tu kasi tolak2 tolong angkat sikit supaya buat marking. Kalau tunggu saja tiada yang buat kamu punya plinth tu..
Azman HKL: Nanti jumpa Fat, sy sda inform sama dia, nanti kamu bagitau dia tu layout..
 Azman HKL: 1st floor, zone TA1b, M&E inspection with consultant in progress.
Azman HKL: Repair work as per consultant comment in progress.
 Azman HKL: 1st floor, TA1b. M&E inspection done. Can proceed. @~Nasri @Mr. Voo
 Mr. Voo: πŸ‘πŸ»
 Dart Econmech: @Azman HKL isnin /selasa nextweek 2 nos container 40ft sampai ya
Azman HKL: Ok noted. Ikut itu plan la. Jumaat saya minta tolong kasi clear itu laluan.
Dart Econmech: Ok tq man
