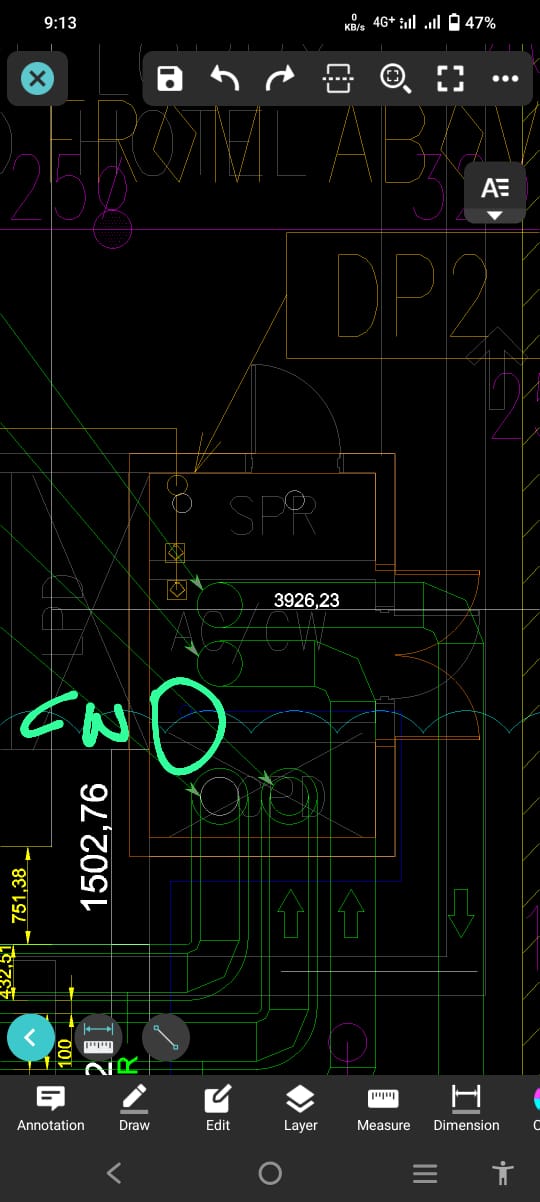

Azman HKL: Morning. @~DartWeirdo 🇲🇾 please be informed. Architect & Plumbing Drawing have discrepancies with your drawing on site. Please issue your RFI ASAP and get approval from the architect.
+60 16-801 0751: Ok noted 🙏🏿
NSC GROUP
Azman HKL: Good morning. Site progress picture. 17/05/2023.
Azman HKL: 2nd floor. Zone 4. Slab cast done.
Azman HKL: 2nd floor. Zone 5. Column rebar in progress.
Azman HKL: Ground floor. Slab rebar in progress.
Azman HKL: 2nd floor. TB1. Slab formwork in progress.
Azman HKL: Basement. Zone 5a. Scaffolding support for ground floor.
Azman HKL: Ground floor. TA1. Cast plan. 22/05/2023.
Azman HKL: 2nd floor. Zone TB1. Casting plan 23/05/2023. Please take note.
Azman HKL: Basement. Zone 3A/1. Cast plan 25/05/2023.
