F/10, G/11 DCC..
Column F/9, F/10, G/9 in progress.

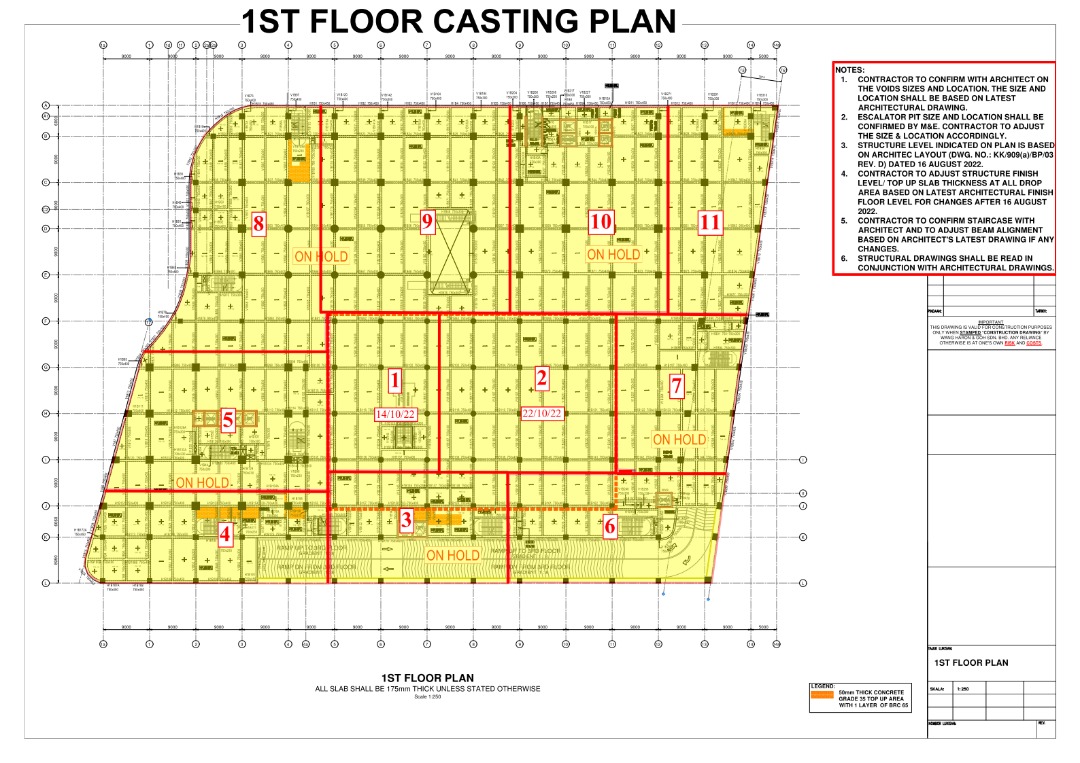

Latest. 1st floor casting plan. NSCs please take note.
we have tough challenge for casting the 1st floor Zone 1 slab on 14/10/22 as we can only cast the F7 round column tomorrow, please get other areas ready (formwork and rebars) while waiting for F7 column casting. Latest to cast on 15/10/22 if we can't make it on 14/10/22. Please focus on this. While we rush for Zone 1 don't forget the columns rebars and casting for Zone 2 which schedule on 22/10/22. We can't afford to slip anymore
Please take note, 1st floor casting plan.
Zone 1: 14/10/2022 (4days)
M&E should start install on 12/10/2022.
Zone 2: 22/10/2022 (12 days)
1st floor mall formwork inprogress. NSCs. Please check any services for 1st floor. I dont have drawing for 1st floor.
1st floor. Beam rebar in progress..

Ground floor Column F/9, G/9 column in progres.
Ground floor column.
GL: F/7. đŸ‘†installing round column.

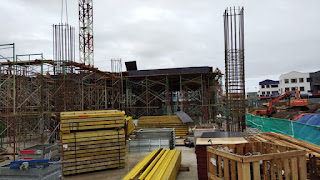

Site progress.
10/10/2022. 8.30am
GL: F-I/1-11
Zone 1A. Basement water tank. Done casting. 09/10/2022. 7.29am.
Tool box briefing..
