EG MALL NSC(3 OGOS 2024)

 EG MALL NSC(3 OGOS 2024)



External drainage. Kasi settle ini MDF pipe. @~s4yamahuk4ya88.gmail.com @~Leppong 👆


Site progress photo.
3/8/24.
8th floor, Tower B. Slab rebar, beam support, M&E in progress.
5th floor. Zone 8. Slab formwork in progress

7th floor. Slab formwork and rebar.

External drainage. Drainage base in progress.


19th floor. Tower A. Fabricating ducting for installation.
19th floor.


18th floor. Ducting fabrication in progress.

17th floor. Ducting riser. Brickwork in progress



16th floor. Wet riser pipe installation.
16th floor. Riser room.

15th floor. Wet riser room.
15th floor. Wet riser room. @EG Mall Shafee alang2 juga subcon kita plaster tu riser room. Nanti tolong cek la ya. Kenapa separuh jak di tatai.





14th floor. @~WY ini jangan ikat mati dulu. Kita tunggu plaster jalan dulu. Besar kamu punya ducting ni. @EG Mall Shafee tolong kejar bro plaster atau skim. 🙏

Supervisor NSC, tolong pusing2 tempat kerja. Kalau ada nampak ini sampah2 tempat kerja, minta kumpul buang dia. Tidak tahan jiwa saya kena tiyau hari2. 🙏@~Leppong @~s4yamahuk4ya88.gmail.com @~🤐 @~WY @~Rimon Joseph @HIDAYA KH office Num @~oneil @~zee


Macam ni bagus. Simpan satu tempat. Jangan lupa buang saja nanti.

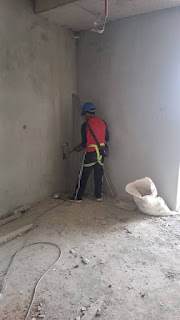

Lepas hack kasi bersih. Bagus.👍🏻👍🏻🫰. Senang hati tgk tempat kerja begini.

12th floor. LSK install conduit in brickwall. Lantai bersih. 👍🏻



10th floor. Wall hacking.

Electrical riser room. @EG Mall Shafee itu simen2 minta tolong kasi clear dia mana subcon Archi punya. Kalau NSC nanti saya minta mereka clear.

   Saya tanya dulu ming punya org…ming punya org selalu clearing diorang punya kerja…

9th floor. Plumbing install CW/HW pipe at riser room..
9th floor. CW riser room. @HIDAYA KH office Num @~WY atur cepat ni bilik. 8th floor siap naik screeding 9th floor.🙏

9th floor.
8th floor. Electrical riser room. @~s4yamahuk4ya88.gmail.com itu bekas kotak, bracket, plastik. Debris kasi clear dia. Ini bilik sudah bersih itu hari. Minta tolong clear sampah. 🙏🙏



New info from C&S. TP4 - 1st cast. They try to cast by today. So If all is done, I will call the consultant to inspect at 2pm.
hidayah@ ; king hong done
