EG MALL NSC (9 OGOS 2024)
[9/8/2024 AM] Azman HKL:Morning. @HIDAYA KH office Num @~oneil minta cek itu outlet pipe. Bagus buat proper macam itu Kinnangland punya. Velakang kamu senang maw buka balik. Tolong cek ya.
Site progress photo.
9/8/24.
8th floor. Tower B. 1st cast done. 2nd cast planning by today.
8th floor. TP9. Slab formwork and support in progress
21st floor. Tower A. Top plinth leveling in progress.
21st floor. @HIDAYA KH office Num nanti tolong cek ini level plinth. Bawah sekali itu water tank steel bar cek ini level.
20th floor. Sprinkler pipe installation in progress.
[9/8/2024 8:12 AM] HIDAYA KH office Num: okay2
[9/8/2024 ] Azman HKL:
[9/8/2024 8:26 AM]
HIDAYA KH office Num: okay2
19th floor. Ducting fabrication in progress.
18th floor. Ducting fabrication.
17th floor. Brickwork ducting riser.
17th floor. @~WY @~Rimon Joseph @~Sayurrpakiss itu tong gam, plastik2 jangan buang dalam chute ya. Chute itu untuk debris batu2 saja untuk mengelakkan sumbat. Kumpul dan bawa turun guna PH dan buang dalam tong garbage.
[9/8/2024 8:40 AM] +60 14-379 2990: Okay man, kami kumpul
set satu masa buang satu kali semua.
[9/8/2024 ] Azman HKL:Strong reminder. Slab opening sealing, please use correct material for sealing and approve by CnS consultant or else rejected and do rectification. Itu gambar contoh.ππ
16th floor. Housekeeping ya lepas kerja. Jangan ampai2 begitu. Dalam gambar ni kalau tiada kasi bersih nanti @Jimmy HKL akan keluar saman terus ya. @~s4yamahuk4ya88.gmail.com @~WY @HIDAYA KH office Num @~zee .
[9/8/2024 8:46 AM] Jimmy HKL: esok masih sama kita saman
15th floor. Geng HKL housekeeping 2org sedang. Lepas mereka kasi bersih jangan ada kotor lagi.

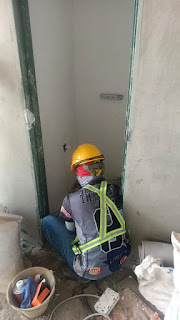

14th floor. @~s4yamahuk4ya88.gmail.com double cek ini pintu ke MSB. Boleh masuk lagi ka kamu punya equipment.
MSB plinth marking dia.
Morning
(Hotel - level 12 - 13 ) @Azman HKL mahu minta tolong kasi bersih sisa2 cement kena pipe sprinkler.. buat houskeeping selepas buat kerja.. tq..
14th floor. ELV conduit in progress.
8th floor. Tower B. Conduit installation in progress.
13th floor. Itu cover busduct simpan baik2. Nanti hilang susah lagi maw di cari. π
@Azman HKL
Hotel - 13th floor, bila mahu skim coat? Team ducting di level 10 sudah mahu pasang balik.. tolong kejar ni.. tidak mahu kerja dua kali.. tq
13th floor. Mixer installation in progress.
[9/8/2024 9:09 AM] Azman HKL: Nanti aku kejar subcon kami. π.
@EG Mall Shafee tolong atur nanti. ππ
[9/8/2024 9:12 AM] EG Mall Shafee: Skimcoat dr level 9 skg
tu….
[9/8/2024 ] Azman HKL:Konduit PVC link. Supervisor tolong pusing Tower A. Mana nampak pipe tidak pakai sudah kasi housekeeping kumpul simpan atau buang.
[9/8/2024 ] Azman HKL: @Jimmy HKL tolong advise dulu kami. Kayu, paip, X, ini boleh buang dala chute ka? Ada wheel barrel lagi. ππini dalam tong garbage bah kan. 13th floor.
[9/8/2024 9:21 AM] Jimmy HKL: X boleh nie masuk rubbish
chute.
Pvc box. 13th floor. @~s4yamahuk4ya88.gmail.com kalau masih pakai atur dia simpan baik2. Alau tidak di simpan jadi sampah ni.
PVC link. Lama susah sini. Kasi simpan baik2 kalau masih pakai. π. Clear dia ni hari. @~WY .
13th floor. Muat ka kamu punya fire alarm. π@~WY cek dia kalau masih perlu. Inform kalau ada masalah kasi selesai.
11th floor. Plumber install CW/HW pipe at riser room.
11th floor.
11th floor. Conduit installation
11th floor.
[9/8/2024 9:34 AM] Azman HKL: Housekeeping selepas kerja ya.
Jangan tunggu esok lusa. π. @+60 12-843 3877
Adjustment PVC box to follow ID drawing.
11th floor, Riser room. CW/HW installation.
ππ»ππ»ππ»10th floor. Plastic kumpul selepas kerja. @~s4yamahuk4ya88.gmail.com
NSC supervisor, silalah minta workers kamu guna ini barang untuk tutup konduit dan paip di wall. πapa nama ni? @~Roxas Ng (Kai)
[9/8/2024 9:52 AM]
+60 16-832 2597: Chicken wire mesh
8th floor. Tower B. Plumbing and electrician works in progress.
@Azman HKL check sama M&E team bila fly cover up the holes/gaps in riser room? 8F so far ok, but 9F can avoid early hassle best kita settle awal
[9/8/2024 10:56 AM]
Azman HKL: 9th floor tolong terus proceed ya. After the 8th floor akan ke 9th
floor. ππ
[9/8/2024 PM] HIDAYA KH office Num:done check levelling untuk plinth 21st floor. plinth 5,8,11 tinggi plinth 12 rendah
[9/8/2024 3:32 PM] Azman HKL: Sangat besar ka? Kalau kasi
letak sim saja kalau dapat.π
[9/8/2024 3:34 PM] HIDAYA KH office Num: min 10mm
[9/8/2024 3:36 PM] Azman HKL: Ok. Bsok pagi kami naik sana.
[9/8/2024 3:55 PM] Azman HKL: Ok. Bawah 10mm boleh bah kan.
Bsok satu kali kasi cek
[9/8/2024 3:56 PM] +60 12-559 6863: min or max?
[9/8/2024 3:59 PM] HIDAYA KH office Num: min boss
[9/8/2024 4:00 PM] HIDAYA KH office Num: bukan. yang kami
cek tadi beza dia min 10mm. ada yang lebih dari itu
