[09:42, 07/05/2024] Mr. Voo: In progress..

[14:02, 07/05/2024] Azman HKL: 6th floor. TB6. Request for inspection at 3pm..@Kadapi J. PROMES . All NSC PIC please stand by the site during inspection. TQ. πŸ™
[14:10, 07/05/2024] Mr. Voo: @~JSK afternoon.. when can u install sub frame for all window ya ? My plasterer want to start plaster alrdy at lv8,10,11,14 ..

[16:06, 07/05/2024] Azman HKL: Heavy rain at site.
[16:09, 07/05/2024] Kadapi J. PROMES: Wait till stop raining lorr only we can proceed for inspection🀭

[16:19, 07/05/2024] Azman HKL: 6th floor. TB6. M&E site inspection in progress.
[17:02, 07/05/2024] Azman HKL: Inspection done. @Mr. Voo @~nas4rie please proceed.
[17:02, 07/05/2024] Mr. Voo: πŸ‘πŸ»
[18:12, 07/05/2024] +60 13-550 3338: afternoon @Mr. Voo may i know is our shopdrwg alredy approved? with 150mm kerb or without?
[18:13, 07/05/2024] +60 13-550 3338: *good evening
[18:14, 07/05/2024] Mr. Voo: Sub frame for me to plaster i think both side and top only needed ..
[18:15, 07/05/2024] Mr. Voo: How ever for this issue need @~Johnny  to follow up
[18:16, 07/05/2024] +60 13-550 3338: best to let us know which height to follow so our subframe can be installed properly & square.
[18:19, 07/05/2024] +60 12-559 6863: Your sub frame height should follow architect’s details right?
[18:20, 07/05/2024] +60 13-550 3338: supposingly yes. but now client request for kerb. should we proceed 1st or wait?
[18:39, 07/05/2024] +60 12-559 6863: @~Johnny can advise?
[19:08, 07/05/2024] +60 16-880 4632: should proceed base on ID drawing...

 NSC GROUP

[08:31, 07/05/2024] Azman HKL: Site progress photo.
7/5/24

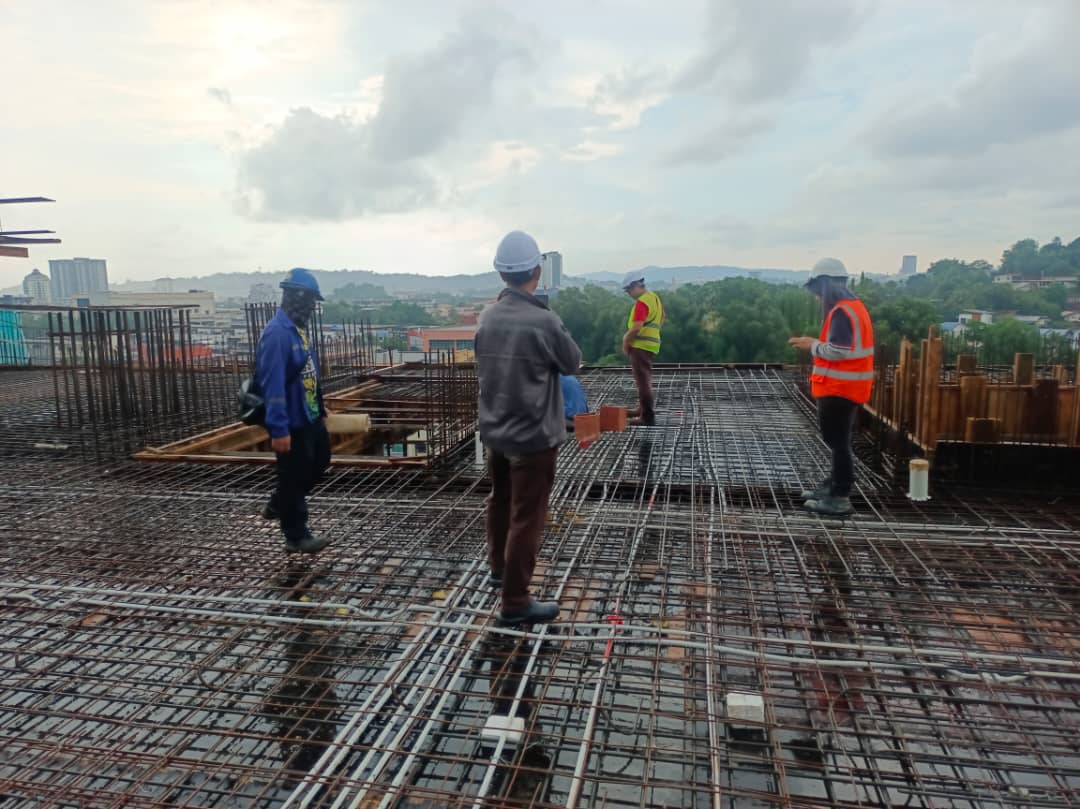

21st floor. TA. Slab rebar and formwork in progress

[08:31, 07/05/2024] Azman HKL: 7th floor. TB5. Slab formwork, rebar and M&E in progress.

[08:31, 07/05/2024] Azman HKL: 3rd floor. Z8. Slab formwork in progress

[08:31, 07/05/2024] Azman HKL: 6th floor. TB4. Slab cast. 7th floor. TB5. Slab formwork and rebar in progress. 6th floor. TB6. Slab formwork and rebar in progress
[09:41, 07/05/2024] Azman HKL: External works. MH4 and MH6. CI pipe outlet thru MH4 in progress.

[10:49, 07/05/2024] Azman HKL: 8th floor. Sample. @EG MALL ECONMECH Dart bila kita maw kasi siap tu sample. Maw kasi kompom dia. Org sprinkler kamu masih jalan tu ikut lama punya. 😩
[10:49, 07/05/2024] Azman HKL: Itu chiller pipe ada baru punya info bila boleh start pasang sample?
[10:51, 07/05/2024] EG MALL ECONMECH Dart: Ada sdh pipe smpai man
[10:51, 07/05/2024] EG MALL ECONMECH Dart: Ya ni hari sy pg instruct team man πŸ™πŸΌ

[10:57, 07/05/2024] Azman HKL: Smlm ada bincang sama ID Jackson. Sini corridor 2.4mm. Tolong ya. Sini macam ada 15mm rendah tu bracket.
[10:58, 07/05/2024] Azman HKL: Ok. Tolong ya. Kejar saja saya hari2. Saya cari jalan supaya semua tempat dapat jalan.

[11:02, 07/05/2024] Azman HKL: Electrical riser. @~Roxas Ng (Kai) @~N@m3£3zz@}+——-{ ini  subcon lain yang akan kasi siap kan. Kita atur dia. Akan post sini  progress riser supaya kita boleh followup yang urgent. πŸ™πŸ™.

[11:05, 07/05/2024] Azman HKL: Ini lift shaft, @~YoonYK saya sudah jumpa sama subcon lagi tadi. Dia orang janji saya ini hari lagi akan start. Saya cuba followup untuk kasi clear 12,13,14 punya formwork. Agak2 kalau dapat khamis ini clear saya atur untuk kita cek verticality. Saya akan inform sama kamu ya. πŸ™
[11:05, 07/05/2024] +60 19-802 0222: Ok boleh….

[14:15, 07/05/2024] Azman HKL: 21st floor. TA1. Slab rebar, formwork and M&E in progress.

[14:15, 07/05/2024] Azman HKL: 6th floor. TB6. Slab rebar and M&E in progress. 7th floor. TB5. Slab formwork and rebar in progress.

[15:49, 07/05/2024] Azman HKL: Ground floor. Duct opening. @⁨EG Mall Econmech Walkeryapp Yapi⁩ @⁨Eg Mall Econ Mate DartWeirdo πŸ‡²πŸ‡Ύ⁩ . Please make the duct opening good. Consultants have commented about this πŸ™.

[15:49, 07/05/2024] Azman HKL: Ground floor. Ducting opening. πŸ™. HKL charges RM500 to make it good.
[15:51, 07/05/2024] +60 14-379 2990: Okay, besok sy atur..

[16:06, 07/05/2024] Azman HKL: Heavy rain at site.

[16:19, 07/05/2024] Azman HKL: 6th floor. TB6. M&E site inspection in progress.
