[11:18, 25/05/2024] Azman HKL: 7th floor. TB5b. Request for inspection M&E services at slab. 2pm. @Kadapi J. PROMES . NSC with services please stand by the site during inspection. TQ. 🙏
[11:31, 25/05/2024] +60 16-880 4632: @Azman HKL our decision paper roll holder to be beside door.
[11:36, 25/05/2024] Edwin Chen 013: This apply for all toilet?
[11:49, 25/05/2024] Edwin Chen 013: It is very uncommon practice to place the bidet point in the left position as most of the people is using right hand.
[11:50, 25/05/2024] Kadapi J. PROMES: Agreed
[11:51, 25/05/2024] Kadapi J. PROMES: It's true
[11:51, 25/05/2024] +60 16-415 0700: Please refer drawing which have been present to client and approve if any alteration we need to seek client approval
[12:03, 25/05/2024] Edwin Chen 013: Hyatt Regency
[12:03, 25/05/2024] Edwin Chen 013: Shangri-la Tanjung Aru
[12:05, 25/05/2024] Edwin Chen 013: Shangri-la Tanjung Aru
[12:06, 25/05/2024] +60 16-880 4632: Agree..stick to your drawings design.🙏
[14:31, 25/05/2024] Azman HKL: 7th floor. Inspection in progress.
[14:48, 25/05/2024] Azman HKL: External MH19. Pipe thru MH inspection.
[15:16, 25/05/2024] Azman HKL: 7th floor. TB5b Inspection done. @Mr. Voo @~nas4rie please proceed.👌
NSC GROUP
[08:15, 25/05/2024] Azman HKL: Morning. @Edwin Chen 013 @HIDAYA KH office Num please push to complete this MH1 and MH2 ASAP so so we can backfill and make good the road. Our neighbour had a complaint. 🙏
[08:17, 25/05/2024] Azman HKL: Tolong ksi tau ya klau sodah pasang pipe..@~Roxas Ng (Kai) kmi mau plaster sodah ini show room 3 unit ya...TQ
[08:18, 25/05/2024] Azman HKL: @HIDAYA KH office Num tolong ya. Unit 20, 21, 22. Tolong push sini juga.
[08:27, 25/05/2024] Azman HKL: External man hole. MH12 and MH13. Cast plan by today. 👆
[08:54, 25/05/2024] +60 16-832 2597: Dear All,
Kindly take note that access to ST05 from Basement to 2F will be sealed off for screeding/tiling works. Please use PH up to 2F and take ST06 or ST03 for access to upper floors. Thank you for your attention. 🤝
[08:58, 25/05/2024] Azman HKL: @Edwin Chen 013 @HIDAYA KH office Num apa tang outstanding sini ya. Lama belum siap. Neighbour shop complained site sda ni. 🫣
[08:58, 25/05/2024] Edwin Chen 013: Will expedite
[09:09, 25/05/2024] Azman HKL: ST6. SPD riser. Dismantling concrete pump pipe in progress. @~WY please check and plan so you can start install SPD duct.
[09:12, 25/05/2024] Azman HKL: Rubbish chute boleh buang sampah sda ya..
[10:11, 25/05/2024] Azman HKL: 9th floor. Unit 1-4, Electrical wall conceal conduit.
[10:31, 25/05/2024] Azman HKL: 8th floor. Sample unit @~WY @EG MALL ECONMECH Dart cari cara kasi bagus dia lagi. Tanya orang archi. Kalau HKL buat akan charge balik. 🙏
[10:32, 25/05/2024] Azman HKL: 10th floor. Trunking adjusting in progress.
[10:33, 25/05/2024] +60 14-379 2990: Okay man
[10:33, 25/05/2024] +60 19-895 9900: @Azman HKL bossku, ni ID dwg dah confirmed kah?
[10:46, 25/05/2024] Azman HKL: Kalau saya ada terima ID yang confirm saya akan share. Ada dapat for reference only. Bukan confirmed..
[10:48, 25/05/2024] Azman HKL: 10th floor. Break glass conduit at lift lobby.

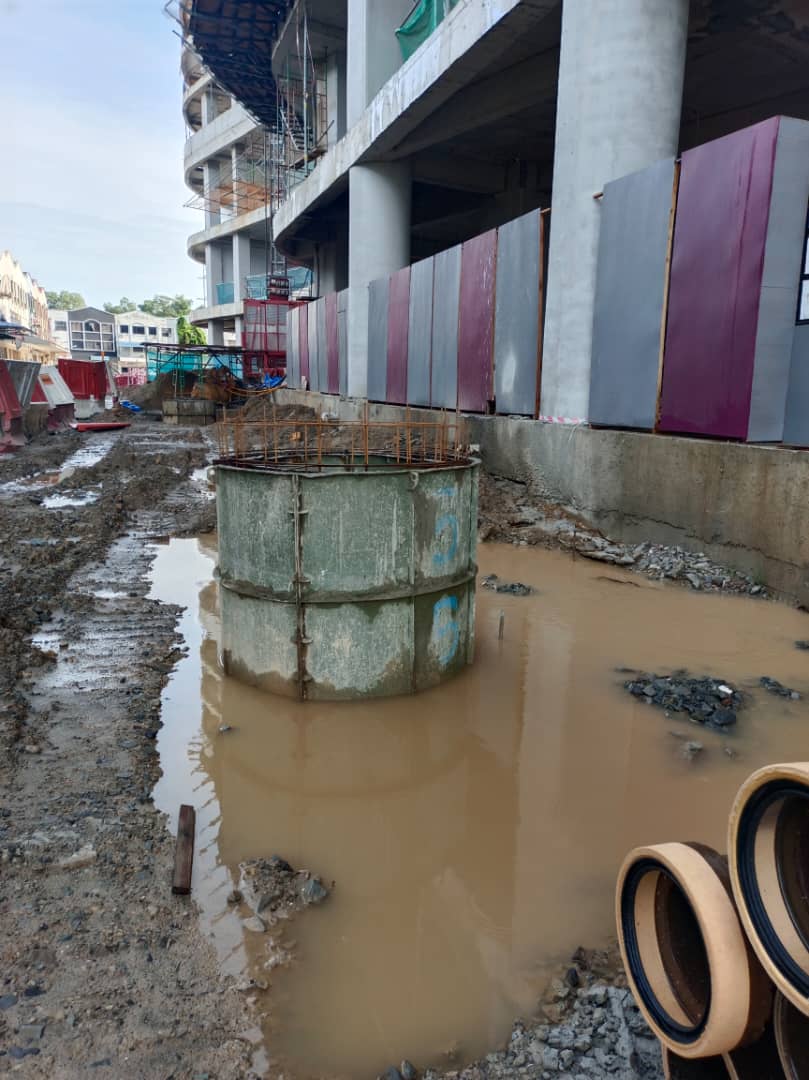

[11:12, 25/05/2024] Azman HKL: Site progress photo.
25/5/24.
21st floor. Plinth layout and formwork in progress.
[11:12, 25/05/2024] Azman HKL: 7th floor. TB5b. Slab rebar and M&E in progress.
[11:12, 25/05/2024] Azman HKL: 2nd floor. Z8. Column rebar in progress.
[11:12, 25/05/2024] Azman HKL: 7th floor. TB4. Slab formwork and beam rebar in progress.
[11:12, 25/05/2024] Azman HKL: 7th floor.. TB6. Beam rebar in progress.
