Saturday, May 18, 2024

19 MAY 2024 HKL

 SITE EG MALL

[09:23, 19/05/2024] Azman HKL: Reminder ya. 11pm. @~YoonYK had inform to excuse. Cant joint. But will direct to the subcon to check the lift motor slab opening.

[10:44, 19/05/2024] Kadapi J. PROMES: @Azman HKL I think this riser is ready for mock up installation. Level 8, 2nd riser from staircase 5. Involved NSC's please take action. Tq
[10:59, 19/05/2024] Azman HKL: Ok noted. @HIDAYA KH office Num @~WY unit 20,21 riser room.
[10:59, 19/05/2024] +60 14-379 2990: πŸ‘πŸ»

[12:12, 19/05/2024] Kadapi J. PROMES: Please add more polysterine yo make high than the r.c. slab. This is slab opening. Tq
[12:12, 19/05/2024] Kadapi J. PROMES: @Azman HKL πŸ‘†πŸ‘†πŸ‘†
[12:13, 19/05/2024] Azman HKL: Ok. Noted. Will arrange with @~nas4rie


NSC GROUP

[08:47, 19/05/2024] Azman HKL: 21st floor. @~nas4rie @Mr. Voo request subcon clear itu kayu. 11am M&E inspection. πŸ™πŸ™πŸ‘†situ tempat ada maw cek lagi.

[08:56, 19/05/2024] Azman HKL: Site progress photo.
19/5/24.

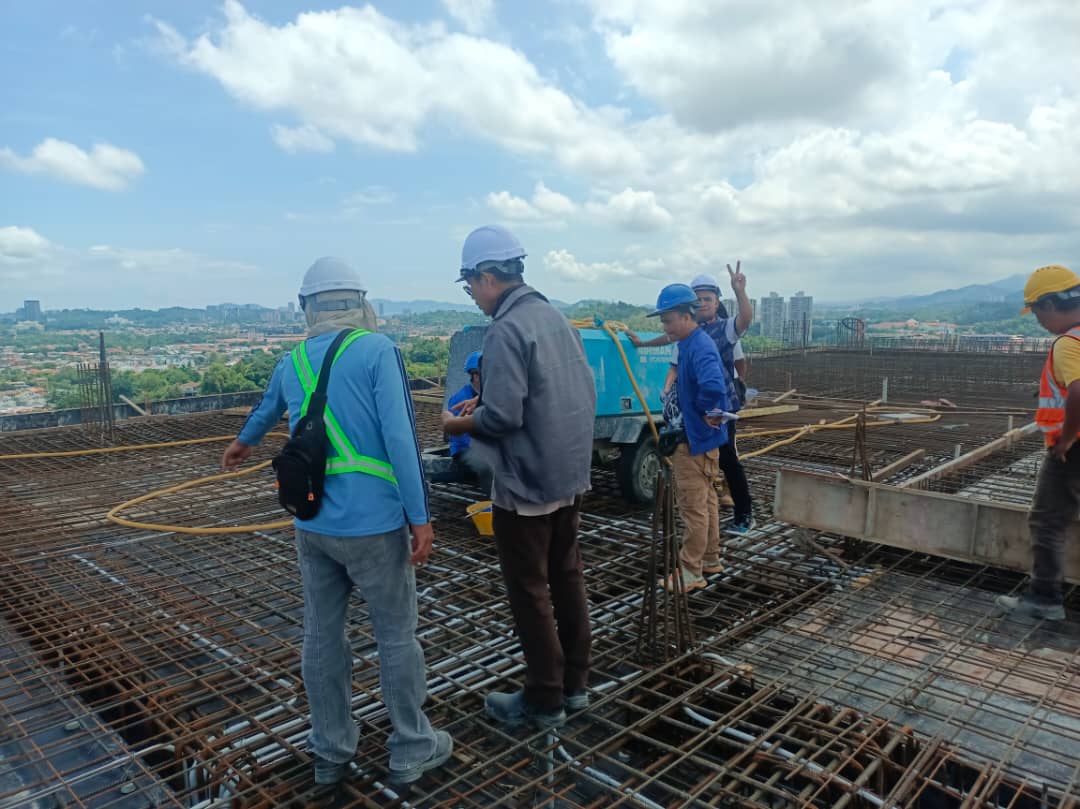

21st floor. TA. Slab rebar and M&E.

[08:56, 19/05/2024] Azman HKL: 7th floor. TB5b. Slab rebar in progress.

[08:56, 19/05/2024] Azman HKL: 6th floor. TB4. Beam formwork and rebar in progress.
[09:32, 19/05/2024] +60 18-960 2589: di atas sudah @Azman HKL
[09:37, 19/05/2024] Azman HKL: Awal juga..
[09:37, 19/05/2024] Azman HKL: Itu opening sda buat?
[09:37, 19/05/2024] Azman HKL: Cuba gambar tempat yang masih ada kayu..
[09:38, 19/05/2024] +60 18-960 2589: tengah buat
[09:38, 19/05/2024] Azman HKL: πŸ‘Œ
[09:40, 19/05/2024] Azman HKL: Opening slab ducting.

[09:42, 19/05/2024] Azman HKL: @~WY πŸ‘†
[09:49, 19/05/2024] Azman HKL: Okay noted.
[10:35, 19/05/2024] Azman HKL: Consultant otw maw naik..

[10:37, 19/05/2024] Azman HKL: External MH1 & MH2 excavated for pipe connection.

[10:58, 19/05/2024] Azman HKL: 21st floor. TA. Plumbing services inspection in progress.
[11:01, 19/05/2024] Azman HKL: @~s4yamahuk4ya88.gmail.com @~WY mana kamu atau wakil? Consultant skrg di 21st floor.


[11:09, 19/05/2024] Azman HKL: @~nas4rie yang tdk cukup tinggi. Nanti atur subcon  kasi tinggi dia.


[11:12, 19/05/2024] Azman HKL: Econmech wakil?
[11:14, 19/05/2024] +60 14-379 2990: Otw naik man.

[11:31, 19/05/2024] Azman HKL: ELV inspection in progress


[11:39, 19/05/2024] Azman HKL: Electrical services inspection


[12:03, 19/05/2024] Azman HKL: ACMV and FP services inspection in progress.

[12:09, 19/05/2024] Azman HKL: @~nas4rie itu lift motor opening belum siap ya. Tdk cukup tinggi. Consultant belum kasi pas ini.
