[15:22, 11/05/2024] +60 12-843 3877: Inspection for wiring installation from level 7-15 in progress
NSC GROUP
[09:08, 11/05/2024] Azman HKL: Ground floor. MH12. @EG Mall Kin Hong Site Coord Chong SY as per discussion, please check again and confirm the pipe thru MH12 above if still needed. TQ. @Edwin Chen 013 for info.
[09:16, 11/05/2024] Azman HKL: Maksud. Itu MH12 kita masih perlu la kan. Untuk stanby pipe.@Edwin Chen 013
[09:19, 11/05/2024] Edwin Chen 013: This pipe is intended for future connections as needed. It has been installed to accommodate potential expansion or additional requirements.
[09:21, 11/05/2024] +60 12-559 6863: is there any pipe sleeves punching through RC wall fixed?
[09:21, 11/05/2024] +60 12-559 6863: as we couldn't find any
[09:21, 11/05/2024] Azman HKL: They have.
[09:22, 11/05/2024] +60 12-559 6863: then construct the MH12 and connect this pipe to it
[09:30, 11/05/2024] Azman HKL: Site progress photo..

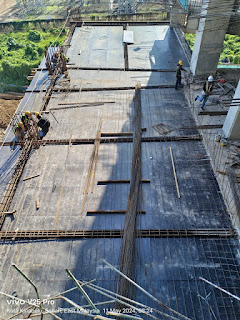

11/5/24.
21st floor. TA. Slab formwork dan rebar in progress.
[09:30, 11/05/2024] Azman HKL: 2nd floor. Z8. Slab formwork and beam rebar in progress.
[09:30, 11/05/2024] Azman HKL: 6th floor. TB4. Column rebar in progress. TB5. ST RC wall rebar, lift wall rebar in progress. 7th floor. TB5. Slab formwork and rebar in progress.
[09:41, 11/05/2024] Azman HKL: MH18,19,20 MH top extension in progress. @~Leppong @~ShawnChia bila Hitachi masuk pg belakang baru kita minta tolong korek untuk pipe PN10. Mereka siapkan ini MH dulu.
[10:15, 11/05/2024] Azman HKL: 10th floor. Ducting installation in progress.

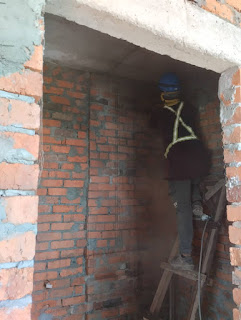

[10:29, 11/05/2024] Azman HKL: 10th floor. SW pipe conceal in brickwall in progress.
[10:31, 11/05/2024] Azman HKL: 10th floor. Electrical conduit conceal in brickwall in progress.
[10:36, 11/05/2024] Azman HKL: 11th floor. Sprinkler installation
[11:12, 11/05/2024] Azman HKL: 15th floor. @EG MALL ECONMECH Dart tolong check itu ventilation fan opening di lift motor room. Maw pakai lagi atau tidak. Kalau tidak maw tutup balik.
[11:22, 11/05/2024] EG MALL ECONMECH Dart: Pakai ni man. Aku prepare duct seja dr luar tu. Utk connect fan dorg
[14:19, 11/05/2024] Azman HKL: 21st floor. Slab rebar and formwork in progress.
