Monday, April 15, 2024

16 APRIL 2024 HKL

NSC GROUP

[08:25, 16/04/2024] Azman HKL: Site progress photo.
16/4/24.

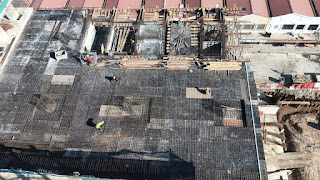

5th floor. TB6. Slab formwork and rebar in progress.

[08:25, 16/04/2024] Azman HKL: 20th floor. TA1. Slab formwork in progress. TA2. Column, lift wall rebar in progress.

[08:25, 16/04/2024] Azman HKL: 7th floor, TB3.

[08:25, 16/04/2024] Azman HKL: 6th floor. Z6/Z7. Column rebar in progress

[08:53, 16/04/2024] Azman HKL: Dear all NSC. Please focus more to phase 2. Office and Hotel (Tower A) - completion date 13 June 2024. 1 month plus remained. Push all at the 8th floor.  Keep reminding me of any outstanding such as riser, brick, formwork clearing at the  Sample unit. πŸ™.
@~LO KEAM @EG MALL ECONMECH Dart @~Ka Pang Liaw @~sklaw3 @Edwin Chen 013 πŸ™πŸ™πŸ™
[08:57, 16/04/2024] Azman HKL: Site PIC, please keep updating new progress and info at site. Please keep sharing pictures so we can monitor them togetherπŸ™πŸ™.
[08:58, 16/04/2024] +60 19-895 9900: Ok bossku, tiada ubahan sdh bilik hotel?

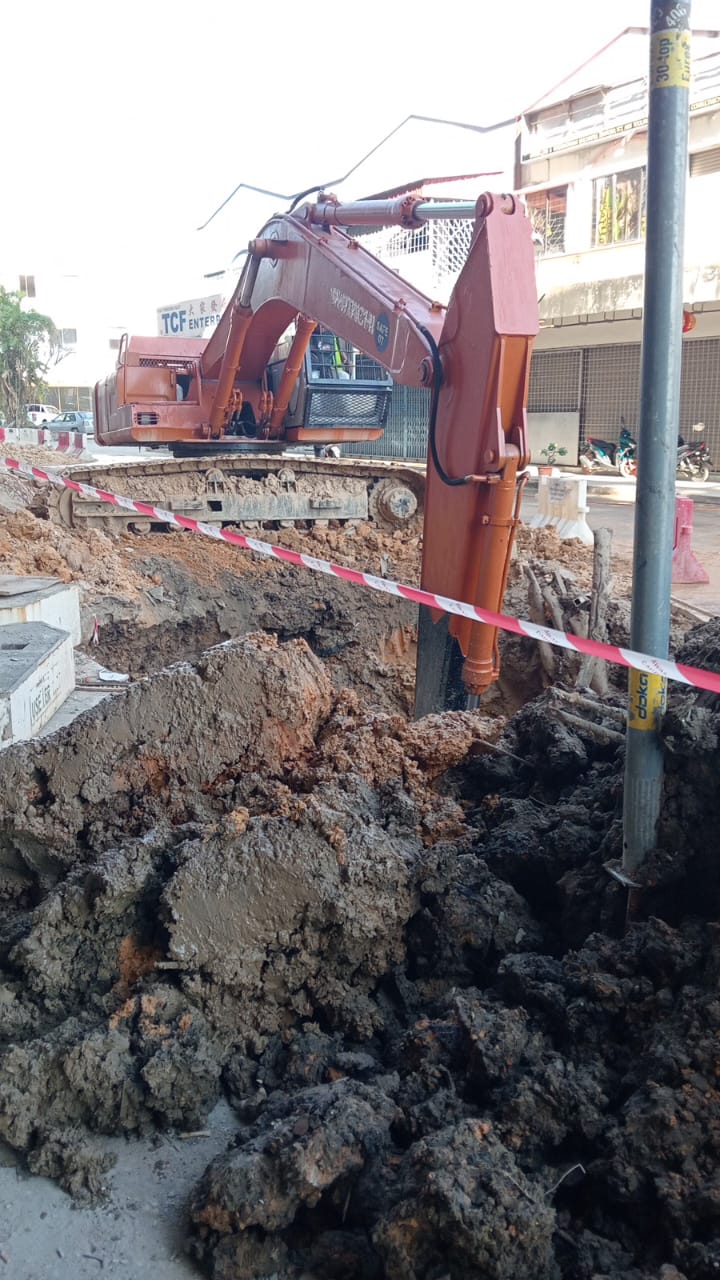

[08:58, 16/04/2024] Azman HKL: Excavation of Manhole 20 in progress.
[08:58, 16/04/2024] +60 19-821 8251: We still waiting and pending lift shaft to handover for us to start our installation work ya. Kindly remind.
[08:59, 16/04/2024] Azman HKL: Saya tidak berani cakap. Tapi itu skrg yang paling latest.
[09:00, 16/04/2024] Azman HKL: Yes. Noted Yoon. In progress. Still remaining of some water and lose concrete. Will keep chasing subcons.

[09:05, 16/04/2024] Azman HKL: Ini sikit lagi saya maw buang itu konkrit/kayu. Itu air saya maw pam keluar dia. Target ini minggu. πŸ™πŸ™

[09:06, 16/04/2024] +60 19-821 8251: Ok thank you πŸ™
[09:10, 16/04/2024] Azman HKL: @EG MALL ECONMECH Dart @Leung KHπŸ€ tolong kejar itu slab coring ya. Maw siap ini minggu juga. Kalau boleh sebelum meeting ni Khamis. Ikut itu drawing submission kamu dan ejas on site condition juga. Brickwall marking macam sda siap di 8th floor. Kamu minta Site PIC cek di site. πŸ™πŸ™

[09:11, 16/04/2024] Azman HKL: Brick setup in progress.

[09:12, 16/04/2024] Azman HKL: Sedang setup.
[09:13, 16/04/2024] Azman HKL: Ini lepas kasi lubang tolong tutup terus. Jangan biar lama2.
[09:14, 16/04/2024] Azman HKL: Sakit mata kalau archi tgk ni. 😩
[09:53, 16/04/2024] Edwin Chen 013: Completing coring work for an entire 8th floor within a two-day timeframe is a formidable task.
[09:53, 16/04/2024] +60 12-559 6863: so how long do u required?
[09:56, 16/04/2024] Edwin Chen 013: Next week
[09:56, 16/04/2024] +60 12-559 6863: next Monday?
[09:57, 16/04/2024] Edwin Chen 013: Why Monday?
[09:57, 16/04/2024] Edwin Chen 013: Next friday
[09:58, 16/04/2024] +60 12-559 6863: u need 10 days to complete coring? how many holes?
[10:02, 16/04/2024] Edwin Chen 013: Please proceed with your brickworks 1st.
[10:08, 16/04/2024] Azman HKL: Yes. We are chasing subcons so al NSC can proceed. πŸ‘ŒπŸ™πŸ™

[10:13, 16/04/2024] Azman HKL: @~WY @HIDAYA KH office Num tolong tgk ini 8th floor. Cari si Joseph. Minta dia bagintau apa lobang yang kacau itu brick tidak boleh jalan. Skrg ya. Kalau boleh telepon dia dulu.
[10:24, 16/04/2024] Edwin Chen 013: We can complete the coring job fast ; however, the final confirmation for the toilet and other related items is still pending as of today. You may proceed with the brickwork as discussed earlier.Thanks
[10:26, 16/04/2024] +60 12-559 6863: ok
[12:38, 16/04/2024] Azman HKL: Sorry late inform. Today Coordination meeting at 3.30pm after, HKL subcon meeting. πŸ™
[13:06, 16/04/2024] Azman HKL: Please submit a progress update for this coming thursday progress meeting. @~Leppong @Recky Econmech @King Hong Office @~sklaw3 πŸ™
[14:32, 16/04/2024] Azman HKL: 20th floor. Slab formwork, lift and column rebar in progress.

[14:33, 16/04/2024] Azman HKL: 5th floor. TB6. Slab formwork, rebar and M&E in progress.

[14:44, 16/04/2024] Azman HKL: @Azman HKL

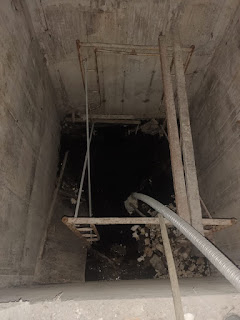

[14:45, 16/04/2024] Azman HKL: @~YoonYK lift shaft.. πŸ‘†

[14:47, 16/04/2024] HIDAYA KH office Num: @Azman HKL @~Roxas Ng (Kai) rectification works for water tank plinth at 3rd floor is done.
[14:51, 16/04/2024] Azman HKL: Ok. TQ. Atur ya sama HKL macam mana maw kira itu man power. πŸ™
[15:50, 16/04/2024] +60 19-821 8251: Will double check on site, thanks. Will informed you also
[16:49, 16/04/2024] Azman HKL: πŸ‘Œ

[17:28, 16/04/2024] Azman HKL: ST05a 15F-16F rebar done only bfor side beam step

[17:28, 16/04/2024] Azman HKL: ST06a 13aF-15F rebar done for 2nd cast remaining step formwork
