[09:54, 07/04/2024] Azman HKL: 19th floor. TA2. Currently work in progress but the casting plan at 12pm. We request for M&E inspection at 11.30am. @Kadapi J. EG Mall Promess Gadapi . πto all NSC PIC please stand by at site during inspection. @Leung KHπ @~zee @~Leppong @~WY ππ
[09:55, 07/04/2024] Azman HKL: @Kadapi J. PROMES
[11:45, 07/04/2024] Kadapi J. PROMES: This area no bar yet?
[11:48, 07/04/2024] Kadapi J. PROMES: @Azman HKL @~nas4rie @~π
πΆπ ππ½πππ
[11:49, 07/04/2024] Kadapi J. PROMES: Most of the area still laying 2nd layer bar reinforcement
[12:09, 07/04/2024] +60 12-559 6863: Working non stop now to get ready
[12:11, 07/04/2024] Kadapi J. PROMES: I will update within 1/2 hourπ
[13:21, 07/04/2024] Azman HKL: 19th floor. TA2. Some slab rebar and M&E in progress
[13:23, 07/04/2024] Kadapi J. PROMES: U can start cast in this area uf u want
[13:24, 07/04/2024] Kadapi J. PROMES: Our mne progressively at this area
[13:27, 07/04/2024] Kadapi J. PROMES: Just pending for rebar works to install our mne conduits
[13:31, 07/04/2024] +60 12-833 6147: Pls take note.
[14:00, 07/04/2024] Kadapi J. PROMES: MnE conduit, opening for DB, ELV & TEL csn not install yet due to formwork and rebar not yet done at this electrical room
[14:01, 07/04/2024] Kadapi J. PROMES: ELECTRICAL ROOM/RISER
[14:08, 07/04/2024] Kadapi J. PROMES: MnE r done accept at this area and pending for formworks and rebar work
[15:16, 07/04/2024] Azman HKL: @Azman HKL itu M&E riser mau siap sudah tu besi
[15:20, 07/04/2024] Kadapi J. PROMES: ππ aku turun sdh. D site opis ni tunggu hujan reda baru pulangπ
[15:55, 07/04/2024] Kadapi J. PROMES: Hujan lebat lorrr
[15:58, 07/04/2024] Azman HKL: Iya bosku. Tunggu reda hujan.
[17:40, 07/04/2024] Azman HKL: 19th floor. All M&E inspection done. @Mr. Voo please proceed. π
NSC GROUP
[08:06, 07/04/2024] Azman HKL: Morning.
Site progress photo.
7/4/24.

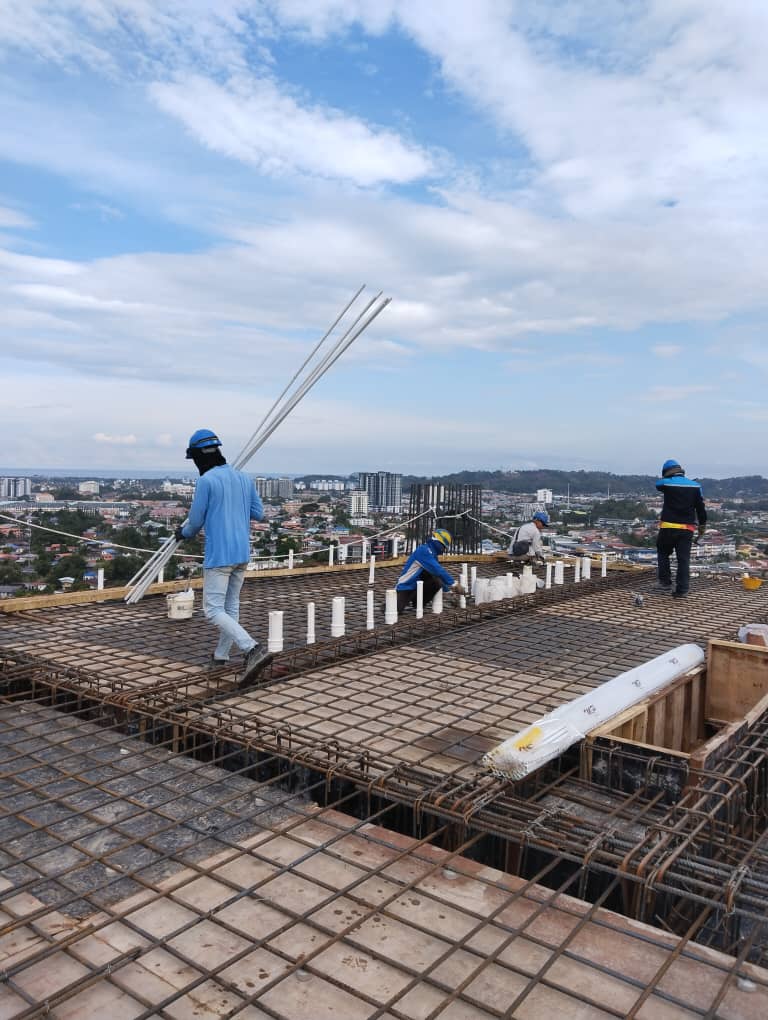

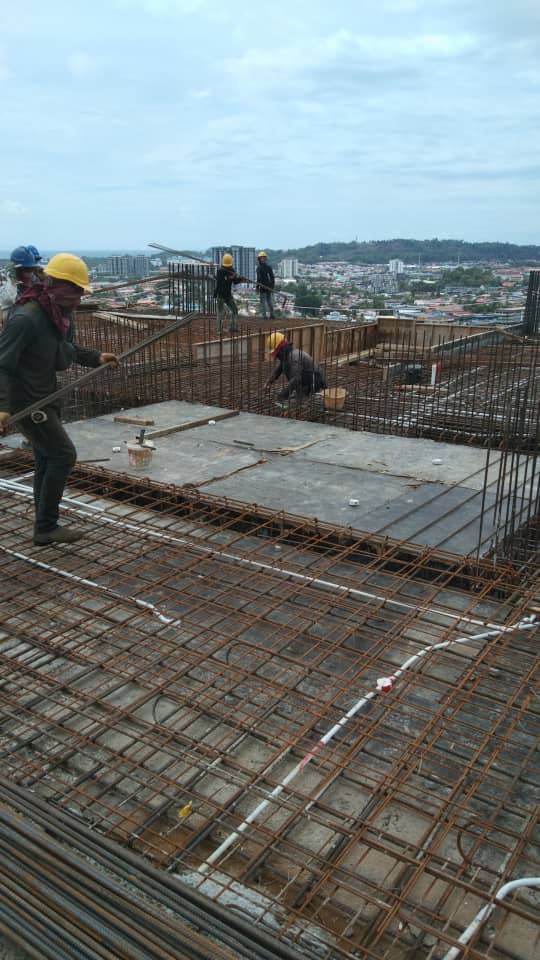

19th floor. TA2. Slab rebar and formwork in progress.
[08:23, 07/04/2024] +60 12-559 6863: Dear all, kindly start your works early at TA/2 19F in order to start casting at 12noon ya, thank u for your cooperation π
[08:29, 07/04/2024] Azman HKL: 4th floor. ST02, RC wall formwork in progress.
[08:43, 07/04/2024] Azman HKL: @~Leppong @~ShawnChia @~Rimon Joseph @~zee tolong ya. Lantai TA2. Kena kejar laju ni hari. Konkrit ada masa untuk kita jam 12pm. ππ. Kami push subcon C&S juga supaya boleh bagi kamu jalan M&E ya. ππ. Ada apa masalah inform sini kjta kasi selesai..

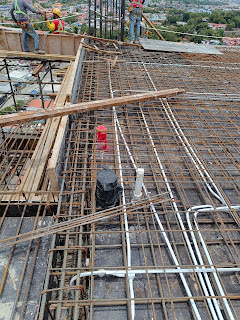

[08:48, 07/04/2024] Azman HKL: 19th floor. TA2. Conduit installation in progress.
[08:50, 07/04/2024] Azman HKL: @~zee ELV @~Rimon Joseph FP & ACMV, ambil gambar workers kamu di atas ya. Share di sini. ππ
[08:52, 07/04/2024] Azman HKL: 19th floor. TA2.
[08:54, 07/04/2024] +60 18-960 2589: baru start ini hari, kemarin hujan,
[09:00, 07/04/2024] Azman HKL: Iya. Minta tolong ni hari ya. π.
[09:06, 07/04/2024] +60 17-866 0355: @Azman HKL 19 TA2 tidak dapat kalau 12 pm maw casting sebab M&E baru star ni pagi tidak dapat stenga hari
[09:10, 07/04/2024] Azman HKL: Iya faham. Cuba dulu mana yang boleh pasang kasi siap dia. Cuba dulu habis baik. π..
[09:12, 07/04/2024] Azman HKL: @~ShawnChia tolong juga ya. Kita cuba. Sebab next week banyak cuti raya kita akan kurang progress. Minta kita sama2 kejar dia ni hari. ππ Saya akan minta push subcon juga kasi siap itu slab formwork sama rebar.. π
[09:21, 07/04/2024] +60 16-837 8881: Kita sama sama usaha
[09:22, 07/04/2024] Azman HKL: Tq very much. πͺ
[09:24, 07/04/2024] +60 18-960 2589: ia kawan,
[09:25, 07/04/2024] +60 18-960 2589: Ok tuan,
[09:56, 07/04/2024] Azman HKL: @~Rimon Joseph @EG MALL ECONMECH Dart minta gambar. π
[11:11, 07/04/2024] +60 19-809 6068: Installation opening for Sprinkler, Hosereel and Wet Riser in progress 19th floor
[11:16, 07/04/2024] +60 17-866 0355: @Azman HKL bilik electrical belum ada lantai pipe tidak dapat sambung
[11:19, 07/04/2024] +60 17-866 0355: @Azman HKL tinggal 1 jam kita punya masa π
[11:20, 07/04/2024] +60 19-809 6068: Install pipe sleeve for Hosereel in progress 19th floor.
[11:24, 07/04/2024] +60 19-809 6068: Installation conduit for fire alarm in progress 19th floor.
[11:56, 07/04/2024] Azman HKL: Iya. Saya kejar subcon kasi buat dia. TQ inform.
[12:16, 07/04/2024] Azman HKL: Sedang pasang @~Leppong π
[12:23, 07/04/2024] +60 17-866 0355: @Azman HKL bilik electrical masih belum ada lantai
[12:27, 07/04/2024] Azman HKL: @~π
πΆπ ππ½πππ ini bos. Urgent minta tolong. Banyak konduit sama ada slab opening. Minta tolong subcon kita supaya inspection pass. ππ
[13:02, 07/04/2024] +60 12-559 6863: @Azman HKL kita start dulu dari G/L 4 situ semasa tunggu siap yg ruser sana, tolong inform Kadapi ya
[13:14, 07/04/2024] Azman HKL: π
[13:21, 07/04/2024] Azman HKL: 19th floor. TA2. Some slab rebar and M&E in progress
[15:16, 07/04/2024] Azman HKL: @Azman HKL itu M&E riser mau siap sudah tu besi
[15:17, 07/04/2024] Azman HKL: @~Leppong ππ
[17:40, 07/04/2024] Azman HKL: 19th floor. All M&E inspection done. @Mr. Voo please proceed. π
[17:49, 07/04/2024] +60 12-559 6863: Thanks all for the hard work and understandingπ really appreciate it
