SITE EG MALL
[11:13, 06/04/2024] Azman HKL: 7th floor. TB3. Request for inspection at 3pm. @Kadapi J. PROMES site PIC NSC please standby on site during inspection. @~Leppong @~WY @HIDAYA KH office Num @~zee
[11:14, 06/04/2024] Kadapi J. PROMES: π
[14:44, 06/04/2024] Kadapi J. PROMES: Hujan lebat owhh
[14:46, 06/04/2024] Azman HKL: Tunggu skjp bos. π
[15:46, 06/04/2024] Azman HKL: 7th floor. TB3. M&E slab inspection in progress.
[16:07, 06/04/2024] Azman HKL: Done inspection. 7th floor. @Mr. Voo @~nas4rie please proceed.
[16:08, 06/04/2024] Mr. Voo: ππ»
[16:31, 06/04/2024] Kadapi J. PROMES: AZMAN, BASED ON ARCHI DRAWING. DIA CUMA PLANTER BOX UTK BUNGA-BUNGAAN. JADI 1 ATAU 2 SAJA CONDUIT KELUAR DARI LANTAI PUN SDH CUKUP. NANTI DIA PUNYA LINK CONTUNUETY BOLE DLM PLANTER BOX SAJA. TAPI CHEK ARCHI DETAIL DULU MCM APA TYPE PLANTER BOXNYA SANA.
[16:31, 06/04/2024] Kadapi J. PROMES: TAK PERLU HACK LANTAI AHH
NSC GROUP
[08:16, 06/04/2024] Azman HKL: Site progress photo.
6/4/24
19th floor. TA2. Slab formwork in progress
[08:49, 06/04/2024] +60 12-559 6863: @EG MALL ECONMECH Dart please clear this container and pull out today, tomorrow concrete pump need to park here for TA2 19F casting
[08:50, 06/04/2024] Mr. Voo: I told him alrdy
[09:20, 06/04/2024] Azman HKL: Contena clearing and transfer FCU to temporary storage at ground floor and first floor.
[09:33, 06/04/2024] Azman HKL: 7th floor. Conduit installation in progress.

[10:03, 06/04/2024] Azman HKL: 8th floor. Plumbing hacking in progress.
[10:09, 06/04/2024] Azman HKL: 7th floor. DCC wiring at slab soffit.

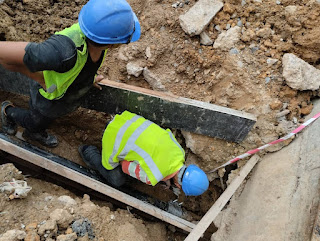

[14:24, 06/04/2024] Azman HKL: CI outlet pipe connects to Man hole in progress.
[14:40, 06/04/2024] Azman HKL: @~Leppong @~WY @HIDAYA KH office Num @~zee jangan main hujan ya.. bagi dulu saya man power and photo kerja ini hari.. π

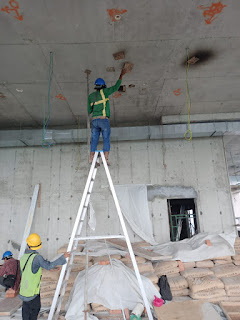

[14:42, 06/04/2024] Azman HKL: 7th floor. Coring and rectification work at slab soffit, plumbing.
[14:45, 06/04/2024] +60 12-559 6863: Standby lepas hujan ya
[15:38, 06/04/2024] Azman HKL: Masih belum jalan besi. Saya agak2 jam 5-6 besi bottom. Baru siap pasang. @~nas4rie tolong ya.
[15:41, 06/04/2024] Azman HKL: 7th floor. TB3. Slab inspection for M&E services in progress.
[15:41, 06/04/2024] +60 18-960 2589: Ok otw
[16:08, 06/04/2024] Azman HKL: Done inspection. 7th floor. @Mr. Voo @~nas4rie please proceed.
[16:17, 06/04/2024] +60 10-941 8970: Ok thank you manπ«‘
