[08:37, 05/04/2024] Azman HKL: Site progress photo.
5/4/24.

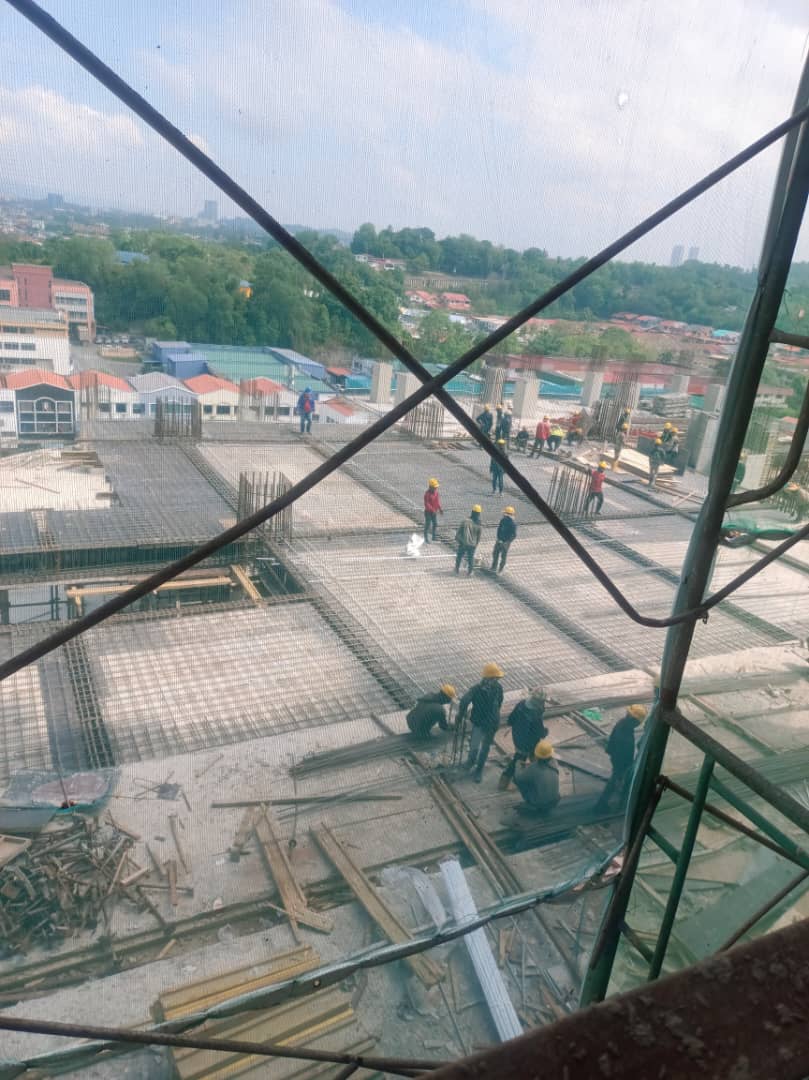

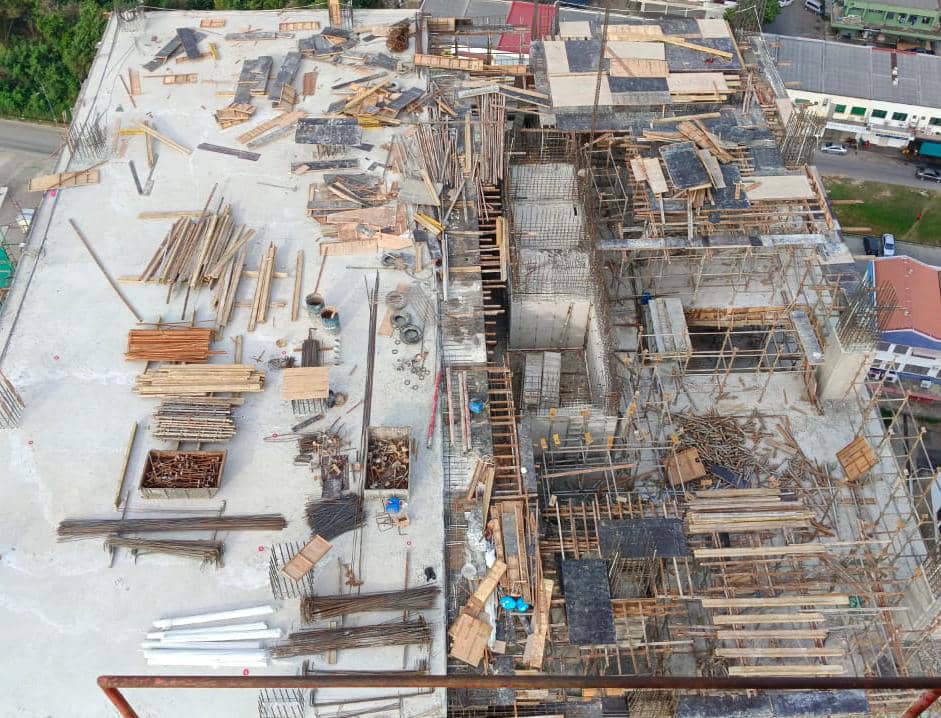

7th floor. TB3. Slab formwork and rebar in progress.π
[08:37, 05/04/2024] Azman HKL: 5th floor. TB6. Slab formwork and support in progress.
[08:37, 05/04/2024] Azman HKL: 19th floor. TA2. Slab formwork in progress.
[08:40, 05/04/2024] Azman HKL: Basement. Cable ladder installation by DCC in progress.
[08:42, 05/04/2024] Azman HKL: Basement. Water tank room. Fan installation by ECM in progress.
[08:56, 05/04/2024] Azman HKL: Ground floor. Lift shaft clearing.
[09:14, 05/04/2024] +60 16-832 2597: ⚠️⚠️!! TAKE NOTE !!⚠️⚠️
ST05 is allow to use for up and down access to different floor levels as of TODAY ONLY. PLS DO NOT USE THE EXIT AT 7F to access 7F, as Tower A is dismantling at that area.. KINDLY EVERY SITE PERSONNEL TAKE PRECAUTION NOTICE
cc @Jimmy HKL
[09:26, 05/04/2024] Azman HKL: @Azman HKL @~Roxas Ng (Kai) ini sempat diorang level 5 st09
[09:27, 05/04/2024] Azman HKL: @~WY cek housekeeping. Jangan biar satu malam begitu. Lepas ha kerja bersih. Subcon lain ada kerja juga sana ya. Tolong atur clearing. ππ
[09:28, 05/04/2024] Azman HKL: Bata yang masih baik jangan buang.. boleh guna lagi kasi simpan. π
[09:28, 05/04/2024] +60 16-239 9318: Kenapa keras kepala untuk buat housekeeping
[09:31, 05/04/2024] +60 12-559 6863: Where is this Tan?
[09:33, 05/04/2024] +60 16-832 2597: GF (L/1-2) sir
[09:33, 05/04/2024] Azman HKL: @EG MALL ECONMECH Dart @~WY cek ini. Itu louvres macam mana. ππ.
[09:34, 05/04/2024] +60 16-239 9318: Senang ja,,kami info sudah mau tutup, jadi kalau sudah siap jgn bilang tiada info ya...
[09:34, 05/04/2024] Azman HKL: @EG MALL ECONMECH Dart π.. comment ya.
[09:35, 05/04/2024] EG MALL ECONMECH Dart: Nanti sy atur ππΌ
[09:35, 05/04/2024] EG MALL ECONMECH Dart: Ini louvers utk ssf
[09:35, 05/04/2024] EG MALL ECONMECH Dart: Suda submit proposal kasi promes
[09:36, 05/04/2024] +60 12-559 6863: This area have aluminium louvers, do nothing there
[09:36, 05/04/2024] +60 12-559 6863: Please read drawing
[09:50, 05/04/2024] +60 16-239 9318: @~Roxas Ng (Kai) sudah saya bilang...jgn hantam Bata ja... Bagus inform... Ada louvers ni.... Jadi you need to inform them not to proceed...
[09:50, 05/04/2024] +60 16-239 9318: @~Roxas Ng (Kai) agreed
[09:52, 05/04/2024] Azman HKL: 12th floor. Wiring and trunking in progress.
[09:54, 05/04/2024] Azman HKL: 13th floor. Sprinkler pipe in progress. ELV wiring at slab soffit installed.
[10:02, 05/04/2024] +60 16-832 2597: But from the elevation I read is flush with only one opening for its ducting sir.. anyhow I will review it again
[10:06, 05/04/2024] +60 12-559 6863: Do nothing there Ok, alreadt told u previously
[10:28, 05/04/2024] Azman HKL: 7th floor. TB3. Electrical conduit in progress
[10:36, 05/04/2024] Azman HKL: 3rd floor. Water tank room. Plinth by KH workers. 3nos.
[10:36, 05/04/2024] Mr. Voo: Hmmm .. mcm diaorng lagi cun dr kita .. malu lah @~Roxas Ng (Kai)
[10:47, 05/04/2024] Azman HKL: 8th floor. Unit 22. Riser room.
[10:47, 05/04/2024] Azman HKL: 8th floor. Unit 20&21 riser room.

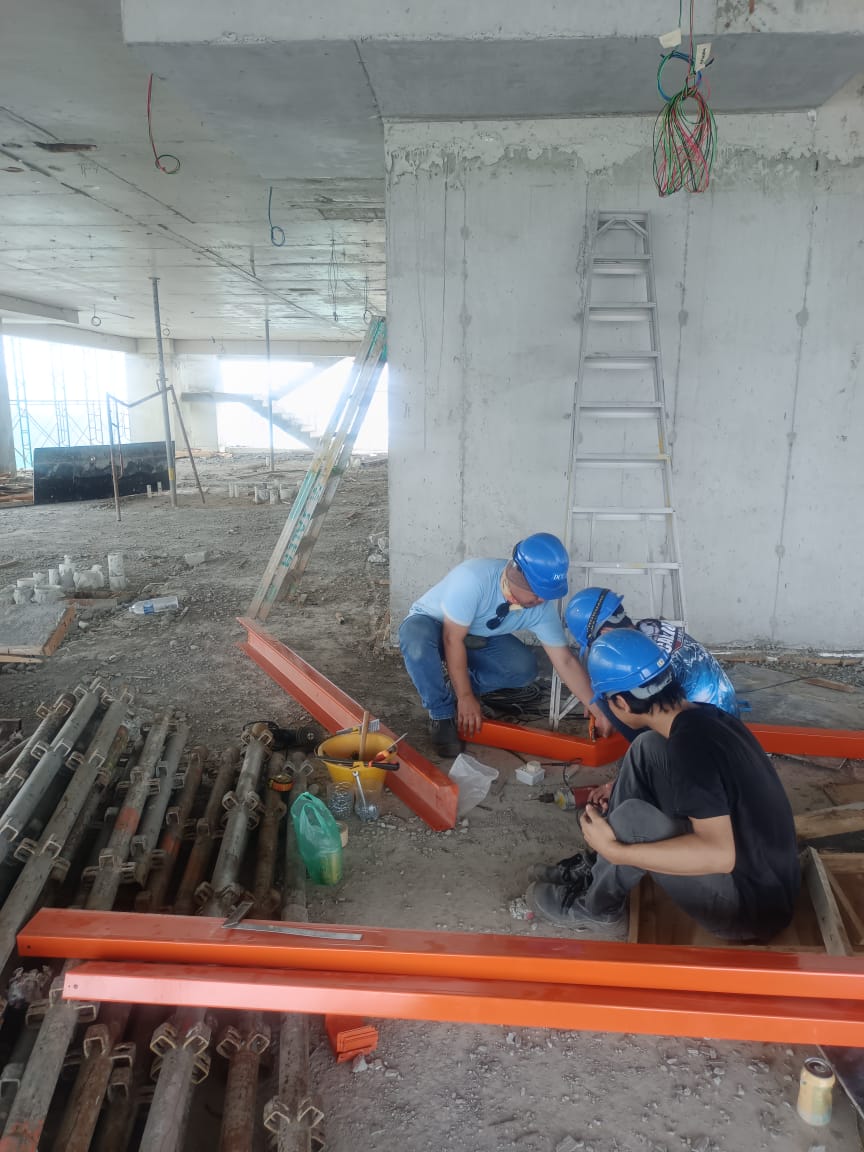

[10:47, 05/04/2024] Azman HKL: 8th floor, electrical room, at lift lobby
[10:47, 05/04/2024] Azman HKL: 15th floor. Lift motor room. @~.... @~Roxas Ng (Kai) please coordinate to complete this M&E riser room 1st ASAP. So M&E can plan, coordinate and start installation to avoid further installation delay. π
[10:49, 05/04/2024] +60 16-239 9318: Noted
[14:34, 05/04/2024] Azman HKL: 7th floor. TB3. Slab formwork, rebar and electrical conduit in progress.
[14:34, 05/04/2024] Azman HKL: 19th floor. TA2. Slab formwork in progress.
[15:46, 05/04/2024] Jimmy HKL: @~WY DILARANG menggunakan material kayu kuning DOKA sebagai lantai asas keluarkan material kamu.
[15:51, 05/04/2024] Azman HKL: @EG MALL ECONMECH Dart @~WY ππ€¬π€―π€¬π€―
[15:52, 05/04/2024] +60 14-379 2990: Okay ..ππ»
[15:53, 05/04/2024] Azman HKL: Dlm tool box briefing ada ckp balik2. Kasi taw kamu punya org .πππ
[16:02, 05/04/2024] +60 14-379 2990: Okay man.
