Friday, March 22, 2024

22 MAC 2024 HKL

SITE EG MALL
[10:54, 22/03/2024] EG MALL ECONMECH Dart: Ok mr johny 🀝

[11:25, 22/03/2024] Edwin Chen 013: @~Johnny , With due respect. Coring procedures may prolong the project timeline, offering little advantage over the alternative method of hacking and plastering. Particularly, when faced with the necessity for larger horizontal openings, the challenges associated with coring become more pronounced. Just my humble suggestion
[13:37, 22/03/2024] Kadapi J. PROMES: Dear NSC's, official leter to hold progress. Tq
[13:51, 22/03/2024] Kadapi J. PROMES: Dear NSC's @Azman HKL. Please plan early for inspection on all the installed M&E servicess at basement to 2nd floor. Tq
[13:52, 22/03/2024] Kadapi J. PROMES: Nanti susah mau claim owhh klu tiada bukti inspection by IOWπŸ˜…
[14:06, 22/03/2024] +60 16-880 4632: Workmanship to improve...

[14:15, 22/03/2024] +60 16-880 4632: Wall Coring is comment in construction lndustry....right tools plus good supervision will minimise the hacking work..
[14:53, 22/03/2024] Azman HKL: Iya bos. Floor by floor. NSC prepares inspection form dulu. Nanti kami inform bos. Maw mula awal kalau boleh bsok ready sda untuk inspection.
[14:54, 22/03/2024] Kadapi J. PROMES: πŸ‘


 NSC GROUP

[07:47, 22/03/2024] Azman HKL: Site progress photo.
22/3/24.

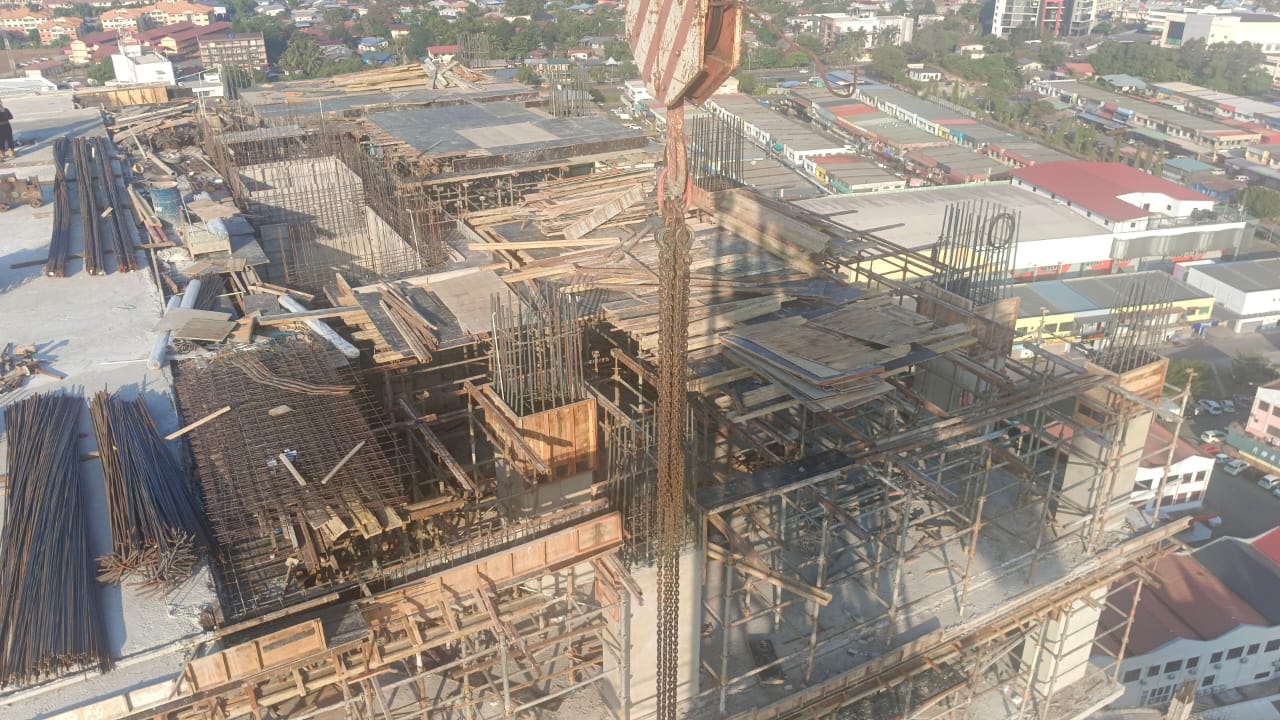

18th floor. TA2. Slab formwork in progress.

[07:47, 22/03/2024] Azman HKL: 18th floor. TA1. Slab cast. Column rebar in progress.
[07:49, 22/03/2024] HIDAYA KH office Num: morning. minta subcon formwork tidak letak material area toilet ya. pagi ni kami naik pegi install pipe suda πŸ™πŸΌπŸ™πŸΌ
[07:57, 22/03/2024] Azman HKL: Sudah letak tu. πŸ˜… Nanti la saya atur dulu.
[08:05, 22/03/2024] HIDAYA KH office Num: okay boleh. thank you πŸ™πŸΌπŸ™πŸΌ

[08:48, 22/03/2024] Azman HKL: @~Roxas Ng (Kai) @Azman HKL tolong kasi tau diorang kenah pipe. Unit 11
[08:49, 22/03/2024] Azman HKL: @HIDAYA KH office Num nanti tolong check ini. Cuba runding sama Joseph..
[08:51, 22/03/2024] HIDAYA KH office Num: okay

[09:45, 22/03/2024] Azman HKL: 4th floor. TB6. Slab rebar and formwork in progress..

[09:48, 22/03/2024] Azman HKL: 5th floor. Column formwork in progress

[10:29, 22/03/2024] Azman HKL: @Azman HKL bro, sini settle sudah? Kalau sudah tlg kasih settle juga tu opening punya tempat; tapi Jgn kacau saya punya pintu ah πŸ™πŸ»
[10:31, 22/03/2024] Azman HKL: @~WY tolong atur itu opening jangan terbuka terlalu lama. Tutup dia sementara kalau perlu lama lagi masa. Itu ada lubang, nanti maw tutup sebelum kena complaint.

[15:57, 22/03/2024] Azman HKL: 18th floor. TA2. Slab formwork,  plumbing pipe sleeve in progress.
