Wednesday, March 13, 2024

14 MAC 2024 HKL

SITE EG MALL







[11:28, 14/03/2024] +60 16-880 4632: Jackson..
protruding column can hack to flush wall..






[11:31, 14/03/2024] +60 16-880 4632: L2 surau room
Poor plastering work..
[11:46, 14/03/2024] +60 13-885 8906: Staircase stiffener. Can hack to flush with the wall. Just pls don't cut any links rebar. Bend in only if encountered. πŸ™
[11:52, 14/03/2024] +60 12-559 6863: if hack this stiffener sure the rebar and links be exposed
[11:53, 14/03/2024] +60 16-832 2597: Making good of work is in progress sir
[15:16, 14/03/2024] +60 17-866 0355: New Slab Casting Plan

3F - TB6 - 13/3/24 today
17F - TA2 - 15/3/24
18F - TA1 - 18/3/24

@~s4yamahuk4ya88.gmail.com @~WY @HIDAYA KH office Num please plan accordingly. πŸ™
[15:17, 14/03/2024] +60 17-866 0355: bukan ni ka

[15:34, 14/03/2024] Azman HKL: 17th floor. TA2. Request for inspection at 4pm. @Kadapi J. PROMES . Sit PIC please stand on site during inspection.
[16:28, 14/03/2024] Azman HKL: 17th floor. TA1. 1st inspection for plumbing, fire and ACMV done. 2nd inspection will do after electrical services are done. @~Leppong inform nanti untuk 2nd inspection. TQ.πŸ™


 NSC GROUP

[08:25, 14/03/2024] Azman HKL: Site progress photo.
14/3/2024.

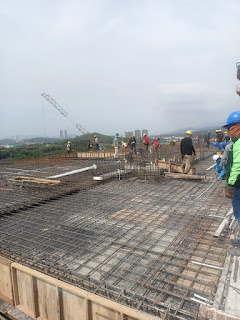

17th floor. TA1. Column rebar in progress. TA2..slab rebar in progress.

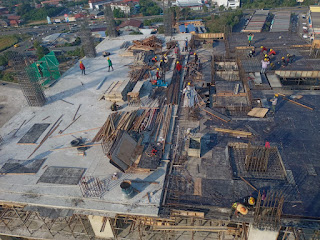

[08:27, 14/03/2024] Azman HKL: 5th floor. TB4. Slab formwork in progress


[08:27, 14/03/2024] Azman HKL: 3rd floor. TB6. Slab cast.

[08:45, 14/03/2024] Azman HKL: Tolong dulu disini. Kami push subcon kejar ini rebar supaya M&E dapat masuk awal. πŸ™πŸ™@~WY @~Leppong @HIDAYA KH office Num .

[09:00, 14/03/2024] Jimmy HKL: @HIDAYA KH office Num pastikan mobile scaffolding dipasang mengikut rekabentuk yg selamat dan perlu di periksa oleh scaffolder beserta tag "safe to use" sebelum digunapakai.

[09:29, 14/03/2024] Azman HKL: Basement @~YoonYK . Ini boleh tolong check. Basement escalator to ground floor. Air ducting ada di atas. πŸ‘†

[09:30, 14/03/2024] Azman HKL: @~YoonYK Tolong check dan kita discuss kalau ada masalah. @~Dart 7090 πŸ‡²πŸ‡Ύ @~WY take note. πŸ™
[09:31, 14/03/2024] +60 19-821 8251: We need at least vertical height of 2400mm, from photo it seems way too low. Will confirm back at site.
[09:32, 14/03/2024] +60 19-865 7090: My bottom of duct is 2500
[09:32, 14/03/2024] +60 19-865 7090: Basement supermarket we make it 2500 the lowest πŸ™πŸΏπŸ‘πŸΏπŸ˜‰
[09:33, 14/03/2024] +60 19-821 8251: This one from slab right, yet include after the escalator installed.
[09:33, 14/03/2024] +60 19-865 7090: Yup
[09:33, 14/03/2024] +60 19-821 8251: Ok, let me check back on site later. Thanks ya. πŸ‘Œ
[09:34, 14/03/2024] Azman HKL: Ok. πŸ™
[09:34, 14/03/2024] +60 19-865 7090: Thanks πŸ‘πŸΏ
[09:35, 14/03/2024] +60 10-219 8082: vertial headroom minimum requirement when standing at any point of escalator must have 2300mm
[09:36, 14/03/2024] +60 10-219 8082: minimum 2300mm headroom..
[09:38, 14/03/2024] Azman HKL: Noted Mr Liaw.
[09:51, 14/03/2024] +60 10-219 8082: Minimum clearance at any point requirement 2300 by law
[09:51, 14/03/2024] +60 10-219 8082: FYI
[09:52, 14/03/2024] +60 10-219 8082: this also show the gap to the railing (by others), need to comply as well..FYI

[09:58, 14/03/2024] Azman HKL: Later we check with the cross section drawing the requirement.
[10:12, 14/03/2024] Azman HKL: EgMall LSK Sudin Wiring ELV1

[10:27, 14/03/2024] Azman HKL: Pipe thru brick wall @~WY ini ada komen dari consultant kan itu sleeve. Agak2 bila kamu start rectify? Kasi saya masa. Seminggu atau sebulan?.kita target diaπŸ‘†πŸ™
[10:43, 14/03/2024] Azman HKL: πŸ˜…
[10:43, 14/03/2024] Azman HKL: Tq bos
[10:48, 14/03/2024] +60 18-960 2589: 🫑
[10:53, 14/03/2024] +60 14-379 2990: Next week kami start man.
[10:55, 14/03/2024] Azman HKL: Ok. Ngam. πŸ‘πŸ»πŸ‘πŸ»


[11:03, 14/03/2024] +60 12-559 6863: the pipes for these 4 areas, can ask the plumber to ensure that there is at least at 150mm spacing between coring point
[11:04, 14/03/2024] +60 12-559 6863: @Edwin Chen 013 comment from our PE
[11:05, 14/03/2024] Edwin Chen 013: 150mm between any 2 point?

[14:05, 14/03/2024] Azman HKL: Basement. Ducting measurement on site. 3500mm from column

[14:33, 14/03/2024] Azman HKL: 15th floor. Hitel. @~YoonYK tomorrow plan kifting your equipment to 15th floor. Book with signalman.

[14:33, 14/03/2024] Azman HKL: Store it here.

[14:37, 14/03/2024] +60 19-821 8251: Finally since last week had been chasing on this matter. Please make sure there is a path way for us to mobilise into the following floor. Thanks
[14:37, 14/03/2024] Azman HKL: 17th floor. Electrical riser. @~nas4rie tolong atur buat ini dulu. Banyak konduit sini maw pasang..
[14:40, 14/03/2024] Azman HKL: We know. We push each other bah. πŸ‘ŒπŸ‘πŸ»πŸ‘πŸ»

[14:42, 14/03/2024] Azman HKL: 17th floor. TA2. Banyak lagi maw buat. @~Leppong @~WY kamu punya boleh bubut ka?
[14:45, 14/03/2024] +60 17-866 0355: banyak lagi maw buat

[14:51, 14/03/2024] +60 17-866 0355: man ni 17th floor bukan besok ka baru casting







No comments:

Post a Comment

EGMALL NSC (23 SEPT 2024)

  EGMALL NSC (23 SEPT 2024) [23/9/2024 9:24 AM] EG MALL Mr Lo: @HIDAYA KH office Num ft ya Sini thanks [23/9/2024 9:24 AM] EG MALL Mr Lo: ...
