13 JAN 2024 HKL

SITE EG MALL

[11:45, 13/01/2024] Azman HKL: 3rd floor. TB4. Request for inspection M&E services at 3pm. @Kadapi J. PROMES . NSC PIC please stand by the location during inspection.

NSC GROUP
 [10:07, 13/01/2024] Azman HKL: Good morning.

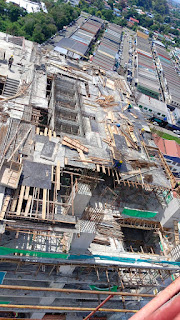

13th Floor, TA1. Slab cast.

[10:07, 13/01/2024] Azman HKL: 12th floor, TA2. Slab formwork in progress

[10:07, 13/01/2024] Azman HKL: 4th floor. Ramp. Formwork in progress. 5th floor. Z7. Slab formwork in progress. 6th floor. Z6. Slab rebar in progress

[10:08, 13/01/2024] Azman HKL: 3rd floor. TB4. Slab rebar in progress.
[10:23, 13/01/2024] HIDAYA KH office Num: request to clear riser area only πŸ™πŸΌπŸ™πŸΌπŸ™πŸΌ


[13:41, 13/01/2024] Azman HKL: 12th floor. TA2. Slab formwork in progress.
[14:10, 13/01/2024] HIDAYA KH office Num: minta kasi clear bha ni supaya pipe sleeves boleh jalan. ndakan kami mau tunggu sampai malam baru clear. isnin confirm ada besi suda ni.
[14:11, 13/01/2024] HIDAYA KH office Num: πŸ™πŸΌπŸ™πŸΌ
[14:11, 13/01/2024] HIDAYA KH office Num: @Azman HKL
[14:12, 13/01/2024] Azman HKL: @~nas4rie tolong dulu bubut..πŸ™πŸ™

[14:14, 13/01/2024] Azman HKL: 12th floor, TA2.Slab formwork still in progress.

[14:14, 13/01/2024] Azman HKL: 12th floor. TA1. Column rebar in progress.

[14:27, 13/01/2024] Azman HKL: New Casting Plan
12F - TA/2 - 15/1/24 πŸ‘ˆ (monday)

Please share your thoughts if any.
πŸ‘ˆ = New date changes
@⁨EG Mall DCC Sshawnstchia⁩ @⁨EG Mall Econmech Walkeryapp Yapi⁩ @⁨EG Mall Kin Hong Site Coord Chong SY
[14:37, 13/01/2024] HIDAYA KH office Num: kalau tidak clear hari ni, saya tidak janji pipe dapat siap hari isnin. sebab ada besi suda.

[14:47, 13/01/2024] Azman HKL: 3rd floor. TB4. M&E inspection in progress.
