Monday, December 25, 2023

26 DEC 2023 HKL

NSC GROUP

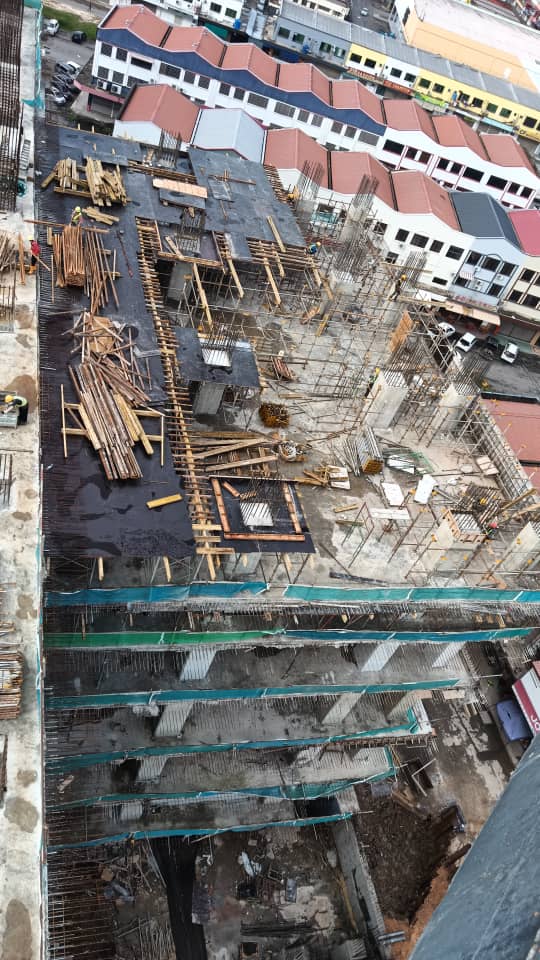

[09:14, 26/12/2023] Azman HKL: 10th floor. TA1. Slab rebar and M&E in progress.

[09:14, 26/12/2023] Azman HKL: 6th floor. TB5. Slab formwork and scaffolding in progress.



[09:14, 26/12/2023] Azman HKL: 6th floor. Z6. Slab formwork in progress. 4th floor. Z7. Slab formwork in progress

[09:14, 26/12/2023] Azman HKL: Basement. Z9. Lift wall rebar in progress.

[10:09, 26/12/2023] Azman HKL: 10th floor. TA1. @~ShawnChia orang kamu boleh siap ini hari atau perlu lagi masa?
[10:12, 26/12/2023] Azman HKL: @Dart Econmech kamu punya electrical ada masuk ini hari pasang 10th floor? Ada bah kan. πŸ™
[10:31, 26/12/2023] Dart Econmech: Ada man πŸ™πŸ»πŸ‘πŸ»
[10:33, 26/12/2023] +60 16-837 8881: Besi baru ada kemarin malam , saya cuba kalau dapat , tapi estimate tak sempat
[10:40, 26/12/2023] Azman HKL: New Casting Plan
6F - Z6 - 23/12/23 TBU
4F - Z7 - 21/12/23 TBU
7F - Z4 - 23/12/23 ✅
10F - TA/1 - 27/12/23πŸ‘ˆ
10F - TA/2 - 31/12/23

πŸ‘ˆ=Changes
Please make plan for working on Holiday. We will update any changes during the holiday.

[10:41, 26/12/2023] Azman HKL: @~ShawnChia @Dart Econmech @Leung KHπŸ€ take note ya.
[10:49, 26/12/2023] Edwin Chen 013: @Azman HKL Could you accelerate the preparation of the formwork and marking for TA2 Level 10? It would be advantageous to have it completed before the onset of the New Year holiday. Thanks
[10:56, 26/12/2023] Azman HKL: @~ShawnChia you plan to park your 2nos 40' container + 1nos 20' container here. Starting tomorrow for 3-4 days. This area is a public area so just make sure to not block and barricade the area.
[10:58, 26/12/2023] +60 16-837 8881: πŸ‘ŒπŸ»
[11:07, 26/12/2023] +60 12-559 6863: @Azman HKL please coordinate with Laisam, GNB will start the drainage work there
[11:10, 26/12/2023] Azman HKL: We are pushing Subcon. Bos @~π‘…π’Άπ“Ž π’žπ’½π‘œπ“ƒπ‘” eveyday pushing them. I plan the slab formwork is ready on 28-29 with marking for pipe sleeve and box. Slab rebar bottom on 29 for electrical conduit. Inspection and cast on 31st. Just keep reminding and pushing each other.
[11:11, 26/12/2023] Azman HKL: Okay. Coordinate with Laisam.

[13:46, 26/12/2023] Azman HKL: 10th floor. TA1. Slab, staircase and M&E in progress. 9th floor. Lift wall, formwork and scaffolding in progress
