[08:27, 16/12/2023] Azman HKL: Good morning.
16/12/2023.
Site progress photo. Basement. 5C. Slab cast.

[08:59, 16/12/2023] Azman HKL: 5th floor. TB5. Slab rebar and M&E in progress..

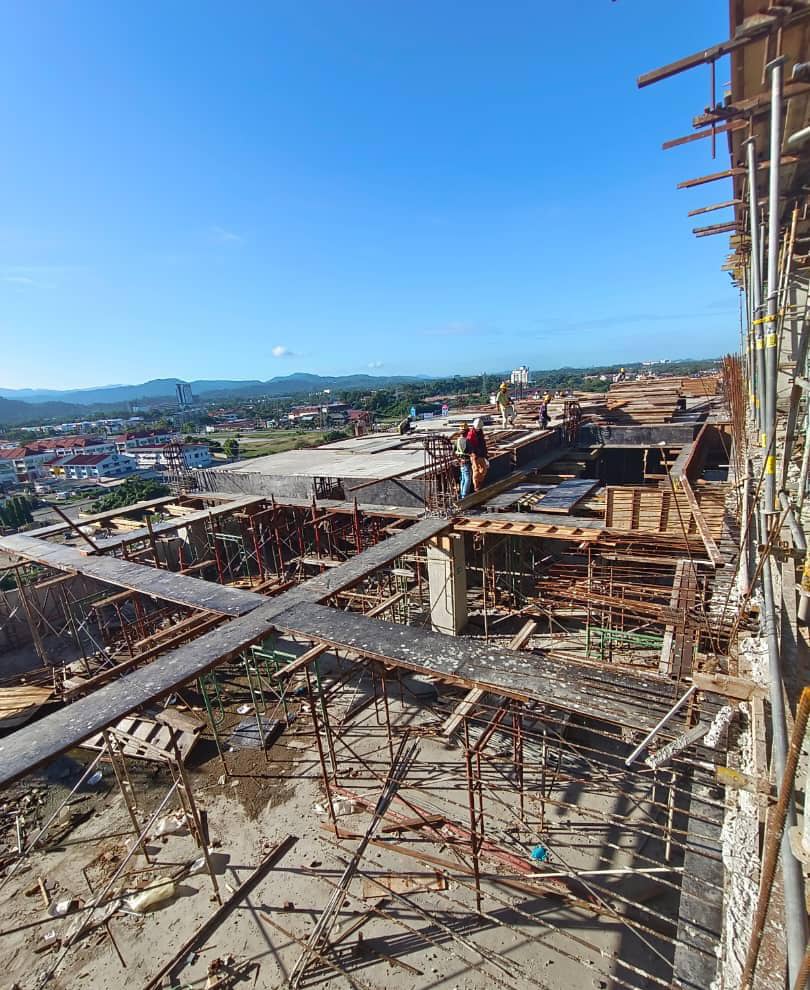

[08:59, 16/12/2023] Azman HKL: 7th floor. Z4. Slab formwork in progress.

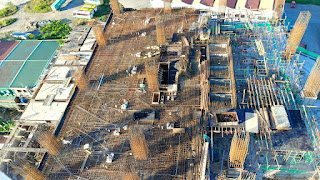

[09:01, 16/12/2023] Azman HKL: 9th floor. TA1. Slab rebar and M&E in progress. TA2. Lift wall rebar and formwork in progress.

[09:04, 16/12/2023] Azman HKL: New Casting Plan
BF - 9B RC wall - 14/12/23
BF - 9C -15/12/23
BF - 5C/a - 15/12/23
9F - TA/1 - 16/12/23👈👈
6F - TB5 - 16/12/23
6F - Z6 - 23/12/23👈
9F - TA/2 -21/12/23
6F - TB3 - 21/12/23
4F - Z7 - 21/12/23
6F - Z4 - 26/12/23
Ramp4 - 21/12/23

👈=Changes

Please coordinate material, man power and drawing onsite. Date may be changed due to site condition.
[09:06, 16/12/2023] Azman HKL: Basement. Z9. Lift rebar and formwork in progress

[10:42, 16/12/2023] Azman HKL: 3rd floor. Water tank room. Plastering in progress.

[10:42, 16/12/2023] Azman HKL: 3rd floor. Water pump room. Plastering work in progress
[10:44, 16/12/2023] Edwin Chen 013: What about the plinth finishing?
[10:46, 16/12/2023] +60 12-559 6863: Plinth no finishing just level
[10:54, 16/12/2023] Edwin Chen 013: Yes. Leveling is what I mean. So when to expect to finish

[10:56, 16/12/2023] Azman HKL: @~Leppong @~Rimon Joseph 3rd floor. ST6. Sambung tu conduit sebelum plastering jalan. 👆
[11:12, 16/12/2023] +60 12-559 6863: @Azman HKL sudah level kan semua itu plinth
[11:15, 16/12/2023] Azman HKL: Belum lagi buat bos.

[11:17, 16/12/2023] Azman HKL: @~Rimon Joseph tolong pg confirm check itu marking pump plinth.

[11:26, 16/12/2023] +60 19-809 6068: Okay man, ngam. 👌🏻
[13:32, 16/12/2023] Azman HKL: Subcon Joseph will start leveling the top plinth tomorrow. @~Roxas Ng (Kai) please help arrange slab waterproofing and screeding after ASAP.
[13:33, 16/12/2023] +60 16-832 2597: Ok
