[13:49, 11/12/2023] Azman HKL: 8h floor. TA1. Request for inspection. M&E services conceal in the slab. 4pm. @Kadapi J. PROMES
[16:23, 11/12/2023] Kadapi J. PROMES: Saya masih tak sihat. Sila ambil photo zoom in RISER ROOM. 1 for corner lot and 1 for intermediate lot hotel.
[16:24, 11/12/2023] Kadapi J. PROMES: I just want to see typical of the installation as per discussed last time.
[16:35, 11/12/2023] Azman HKL: Riser room.
[16:42, 11/12/2023] Kadapi J. PROMES: Pvc conduit jauhkan dari droper pipe.
[16:44, 11/12/2023] Azman HKL: 2 inci jarak dekat pipe.
[16:45, 11/12/2023] Kadapi J. PROMES: Very high risk for the conduit during casting. Klu boleh alihkan casting pipe. Kalau tak DCC kena jaga masa casting.
[16:47, 11/12/2023] Kadapi J. PROMES: Hangkang conduit kita ni geng.
[16:47, 11/12/2023] Azman HKL: @~nas4rie tolong nanti pastikan. @~Leppong kamu punya org ada stanby bah kan.
[16:48, 11/12/2023] Kadapi J. PROMES: Dia punya vibration masa casting kuat tu. Mesti taru chok atau tempat duduk casting d tempat yg kurang conduit.
[16:50, 11/12/2023] +60 17-866 0355: Ok bos
[17:12, 11/12/2023] Azman HKL: @Kadapi J. PROMES boleh proceed bossku?
[17:14, 11/12/2023] Kadapi J. PROMES: Klu ko boleh guarantee x rosak conduit kita masa casting.
[17:15, 11/12/2023] Kadapi J. PROMES: Ini sdh repair?
[17:21, 11/12/2023] Azman HKL: @~Leppong tolong atur dia ikut consultant komen. TQ.
[17:22, 11/12/2023] +60 17-866 0355: Ok mam
[17:23, 11/12/2023] Azman HKL: Ini sda minta atur sama @~nas4rie . Mereka tambah chock sama S untuk jaga itu conduit di bawah. Ada stanby juga DCC.
[17:37, 11/12/2023] Kadapi J. PROMES: Klu boleh, next time itu pipe jangan duduk d tempat crowded servicess. Sebab masa casting dia tendang sangat kuat. Kita punya just pvc, mudah kemek dan patahπ
NSC GROUP
[08:24, 11/12/2023] Azman HKL: Morning, @~LO KEAM @~ShawnChia . As informed by your supplier, equipment container will arrive at the site this 13Dec. We required a MOS submitted to the SHO to check and comment ASAP. ππ.
[08:37, 11/12/2023] Azman HKL: NSC Safety tool box at ground floor.

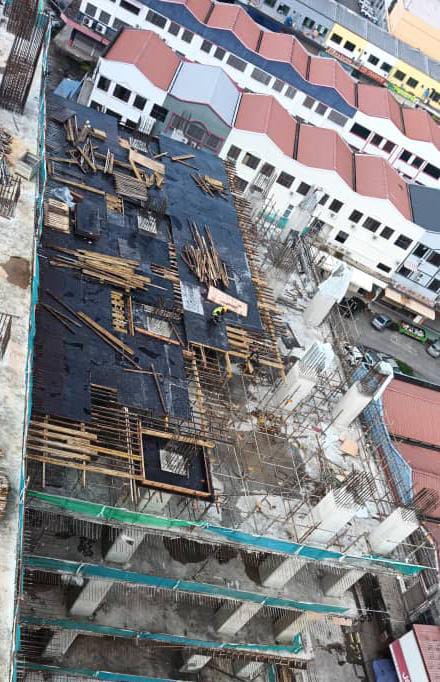

[08:51, 11/12/2023] Azman HKL: 8th floor. TA1. Slab rebar and M&E in progress.
[09:10, 11/12/2023] Azman HKL: To all, during this rainy π§️season please focus and planning more on work in the morning because it always rains in the afternoon.
[09:15, 11/12/2023] Azman HKL: Basement. Z9. Retaining wall in progress.
[09:15, 11/12/2023] Azman HKL: 6th floor. TB5. Slab formwork and support scaffolding in progress.
[09:33, 11/12/2023] +60 19-895 9900: Mrng bos, this week only loose items will arrive site and store at ground floor dedicated location as per site discussion earlier, the MOS wil submit this few days for the equipments lifting items, hope the above clarified tqππ»ππ»ππ»
[09:52, 11/12/2023] Azman HKL: Ok noted.
[14:12, 11/12/2023] Azman HKL: Please push more to complete slab work as early as possible. The weather above is getting dark. πππ.
[15:28, 11/12/2023] Azman HKL: NSC tolong repair balik itu rebar yang bengkok and potong. Kasi ikat dia bagus. Jangan kena komplen.
[16:10, 11/12/2023] Lo. W. H (HKL-Site Engineer): Dear valued NSC, please provide tower A ....all floor M & E void sizing and position after transfer floor 15th floor,... thanks
[16:11, 11/12/2023] Lo. W. H (HKL-Site Engineer): your feedback is compulsory ....thanks
[16:11, 11/12/2023] Lo. W. H (HKL-Site Engineer): thanks @Dart Econmech especially your scope
[16:59, 11/12/2023] Edwin Chen 013: @Azman HKL, have they re position the metal frame as it was out of alignment during our observation just now at site.
[17:05, 11/12/2023] Azman HKL: They are doing it right now. @~nas4rie tolong ya. Kalau tidak hack lantai lagi nanti.πππ
