Friday, November 10, 2023

11 NOV 23 HKL

SITE GROUP

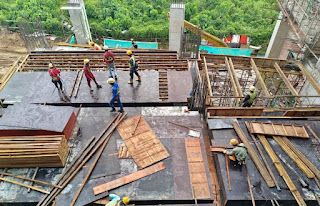

EG MALL Azman: 7th floor. TA2. M&E services inspection before casting in progress.

NSC GROUP

 EG MALL Azman: @HIDAYA KH office Num  please take note ya. This area had changed to refer to the latest drawing. There is an additional plinth that will be cast.
EG MALL Azman: Site progress photo.
11/11/23.
6th floor. TA2. Slab cast.
EG MALL Azman: 6th floor. TA2. Slab cast.

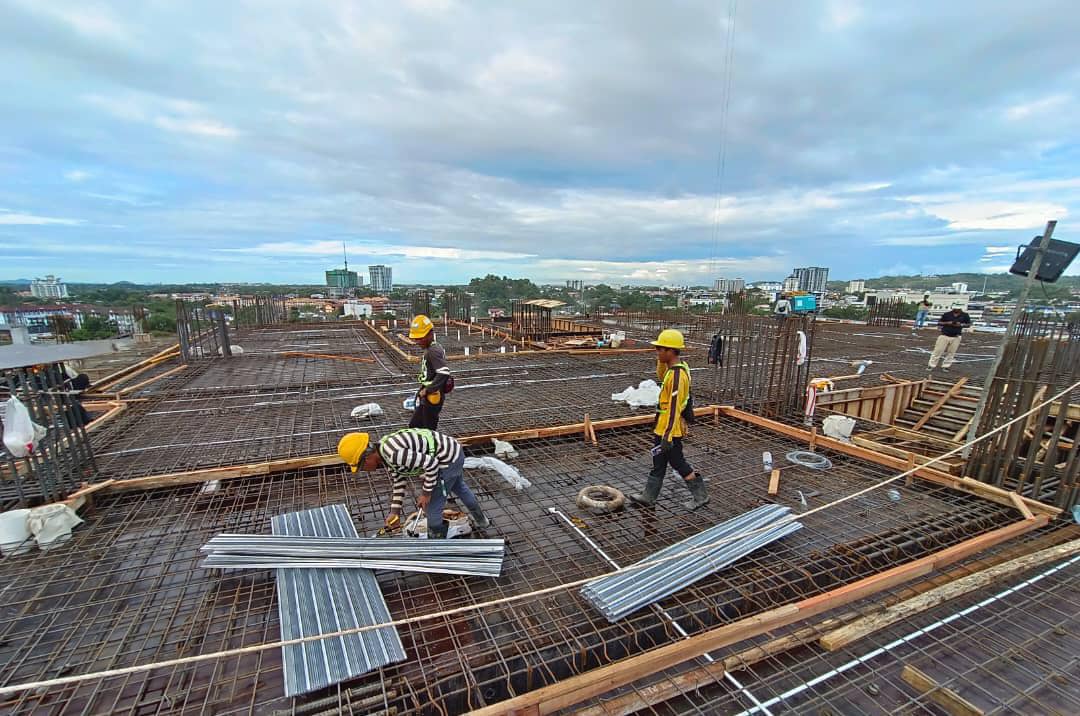

EG MALL Azman: 7th floor. TA1. Slab rebar and M&E in progress
 EG MALL Azman: 5th floor. Z6. Slab formwork in progress.
EG MALL Azman: 2nd floor. Z7. Slab formwork in progress
EG MALL Azman: 3rd floor. TB5. Slab rebar in progress

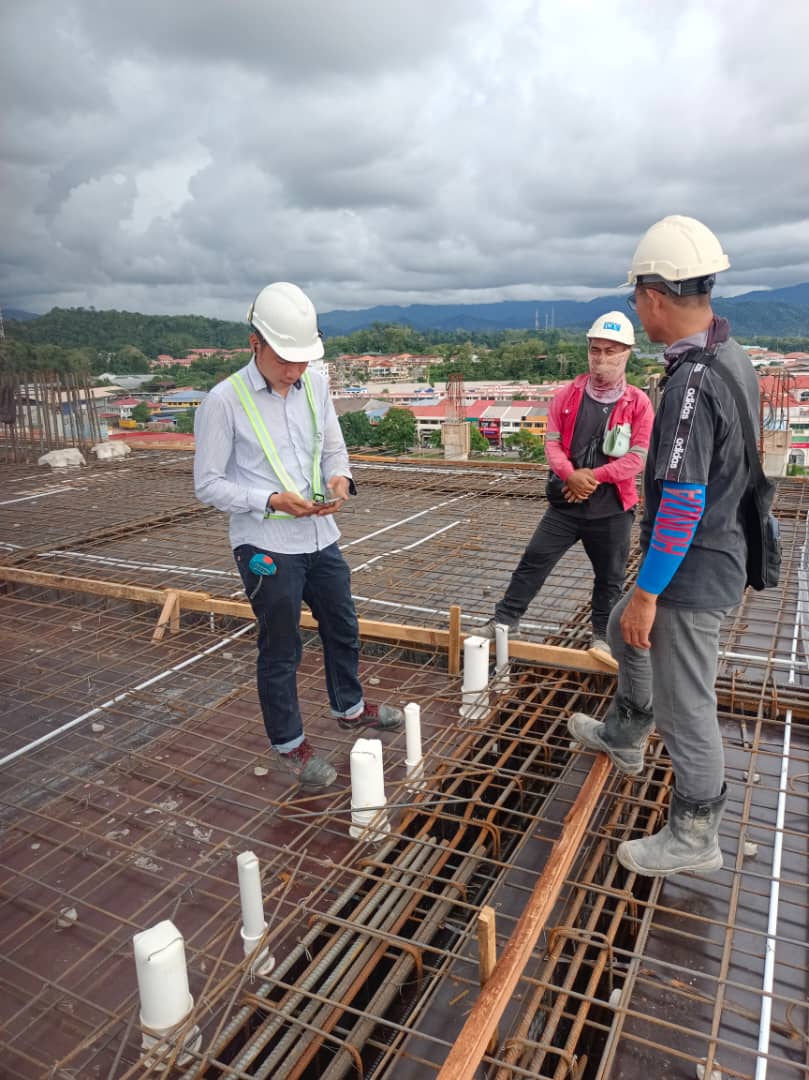

EG MALL Azman: 7th floor. TA1. M&E service inspection in progress. @~Walker Yapi @HIDAYA KH office Num @~.Fazli
 EG MALL Azman: 7th floor. TA1. Done inspection. Please proceed. @Mr. Voo @~nas4rie
