Wednesday, November 29, 2023

30 NOV 2023 HKL

 NSC GROUP

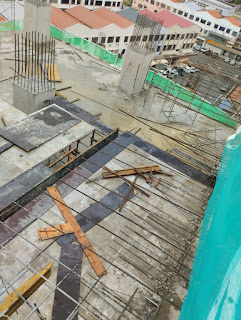

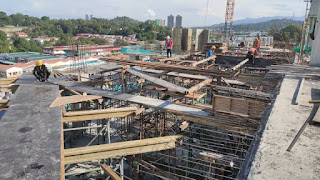

[09:45, 30/11/2023] Azman HKL: 6th floor partial slab detail.

[09:53, 30/11/2023] Azman HKL: Site progress photo.
30/11/2023.

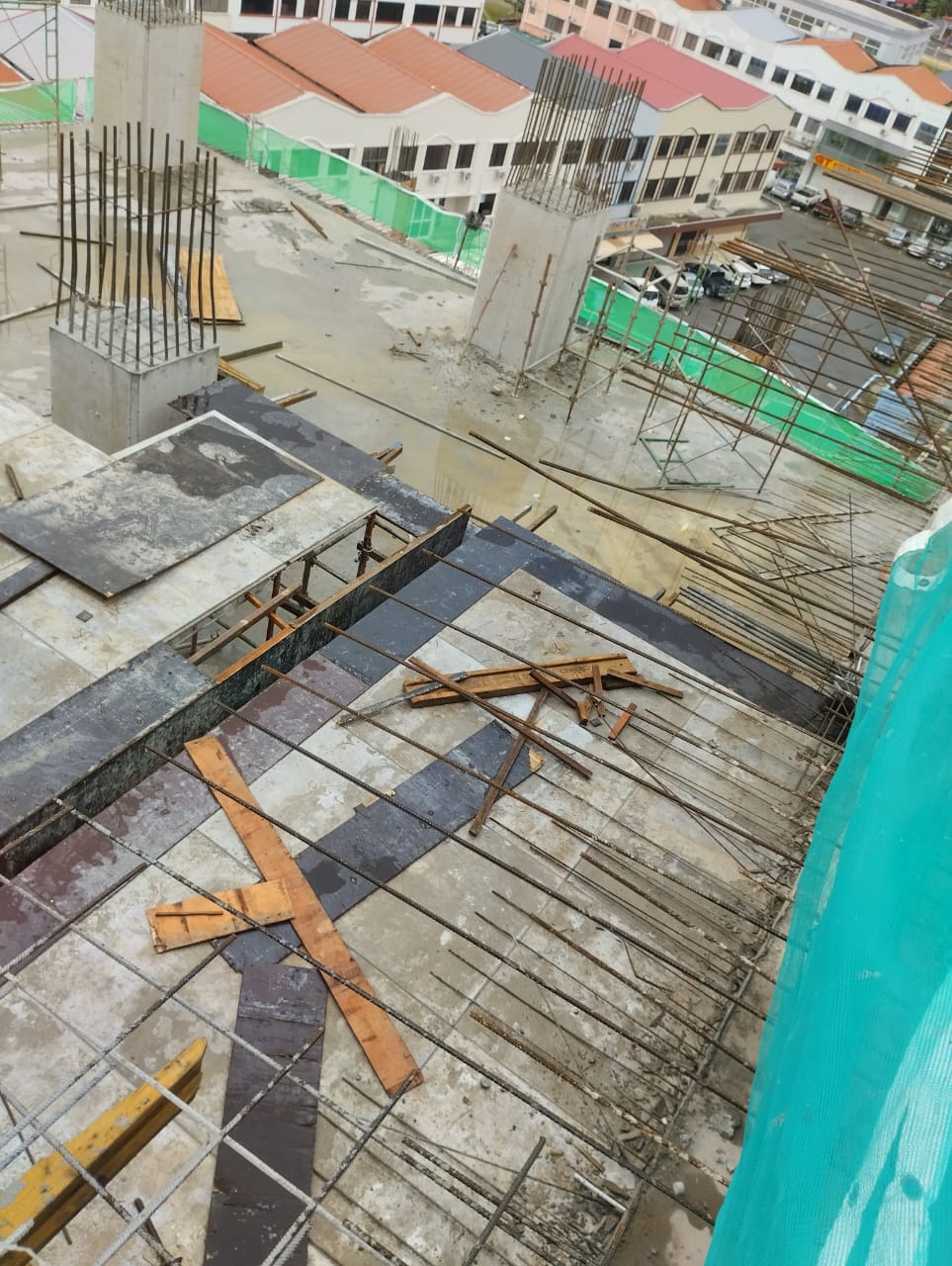

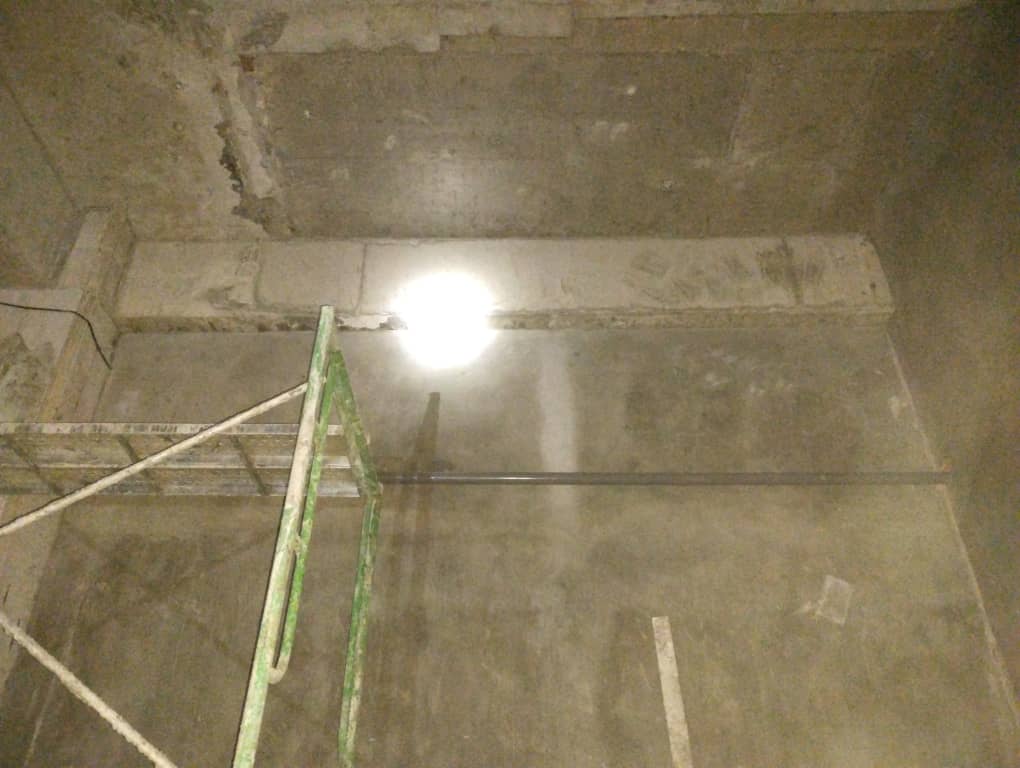

4th floor. TB5. Slab cast

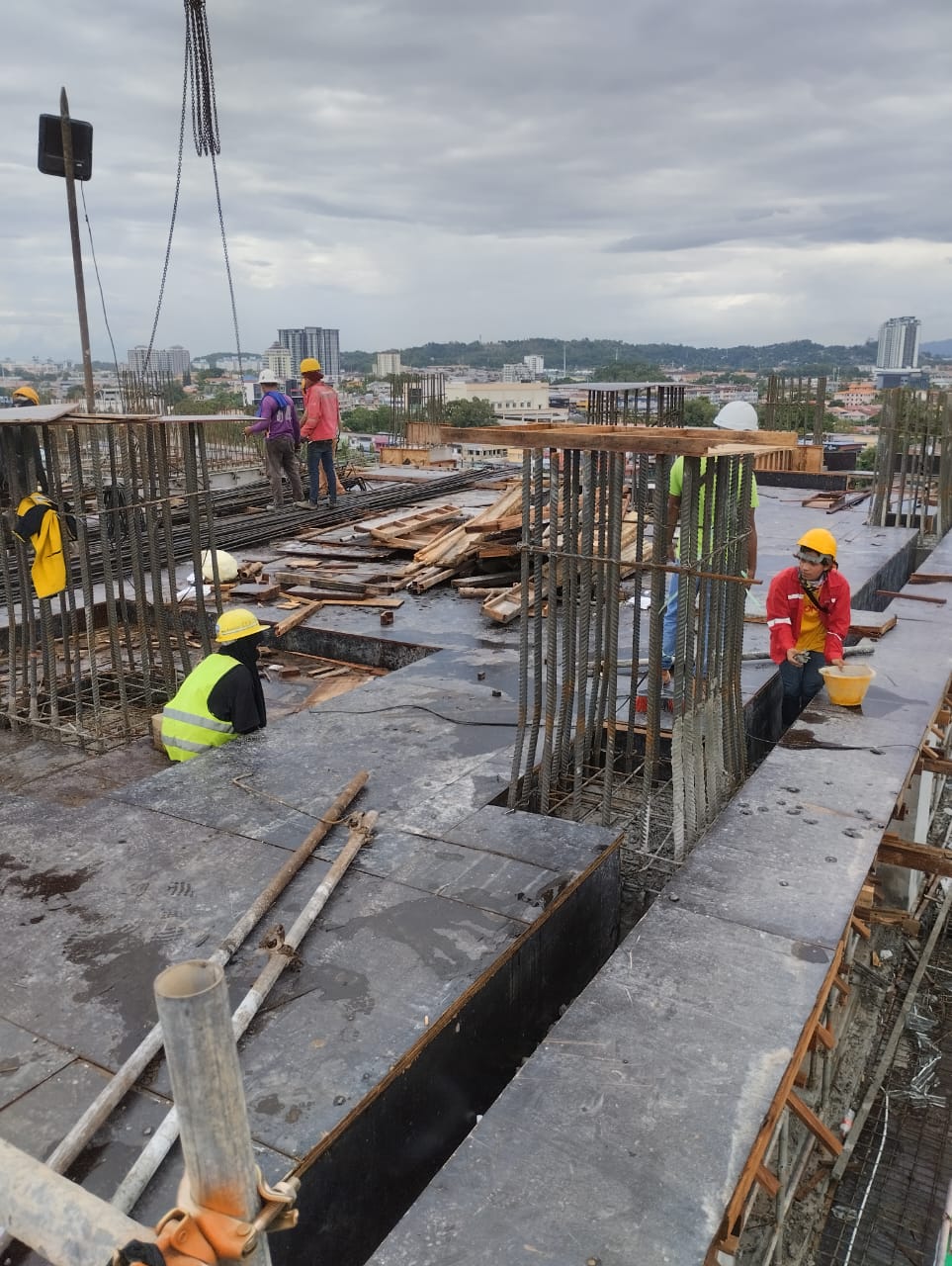

[09:53, 30/11/2023] Azman HKL: 8th floor. TA1. Slab formwork in progress.

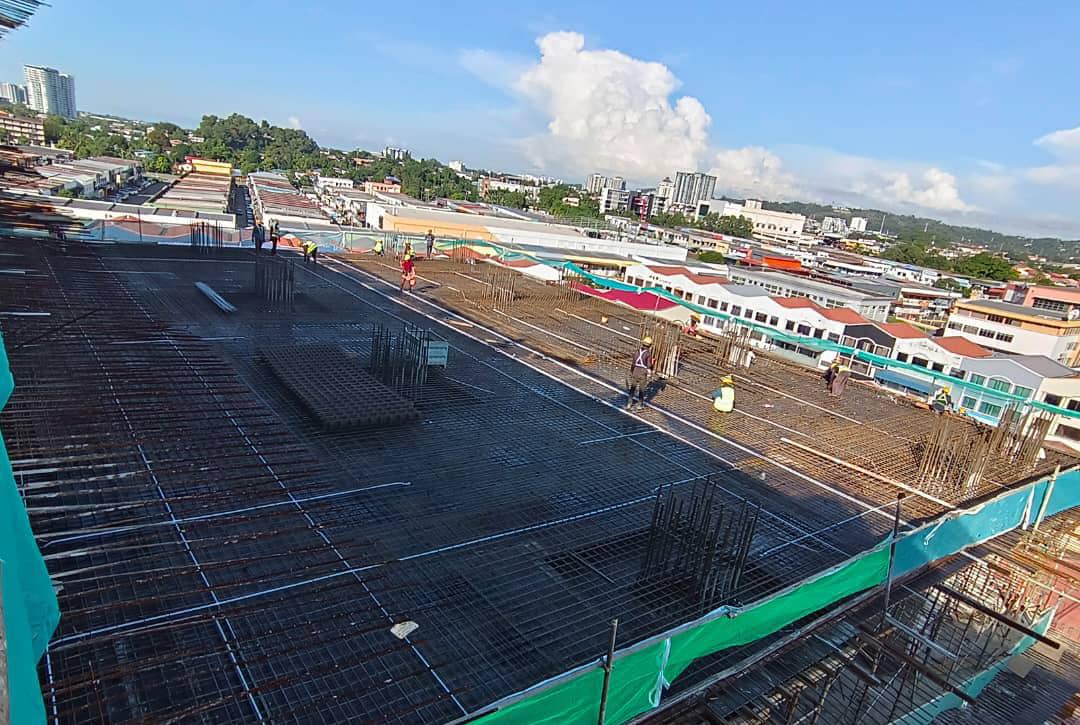

[09:53, 30/11/2023] Azman HKL: 3rd floor. Z7. Slab formwork in progress.

[09:56, 30/11/2023] Azman HKL: 7th floor. TA2. Slab formwork in progress.

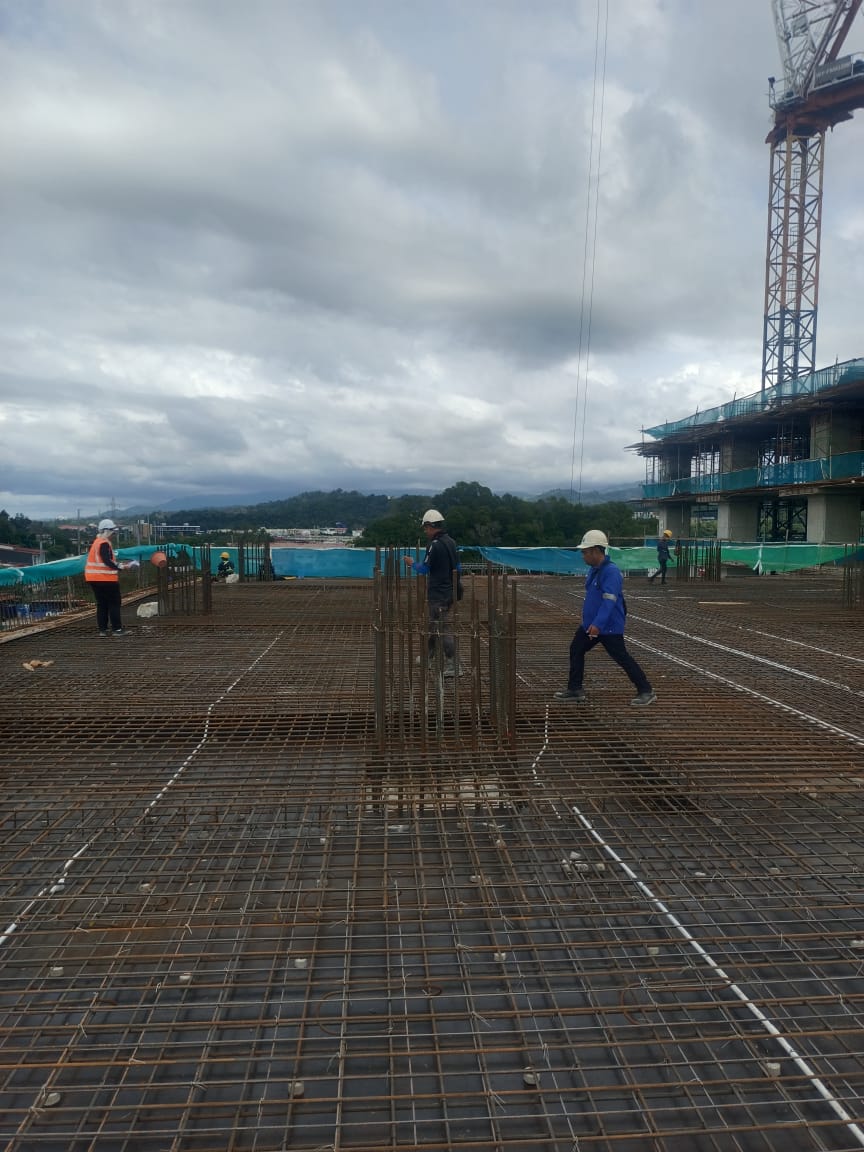

[09:57, 30/11/2023] Azman HKL: 5th floor. Z6. Column formwork inprogress.

[10:34, 30/11/2023] Azman HKL: Basement. Z9a. Retaining wall rebar in progress.
[10:36, 30/11/2023] Raymond Chong. Y. F (HKL P. Manager): King Hong ada pipe sleeve kat situ ka?
[10:48, 30/11/2023] HIDAYA KH office Num: ada. will install pipe sleeves in beam later

[11:06, 30/11/2023] Azman HKL: 1st floor. ST6. Wet riser pipe and LPD. Please get the installation approval from the consultant. @~Walker Yapi 🙏

[15:39, 30/11/2023] Azman HKL: Kena pipe st5  2nd floor
[15:40, 30/11/2023] Azman HKL: @HIDAYA KH office Num nanti tolong check ya..

30 NOV 2023

29 NOV 23 HKL

SITE GROUP

Azman HKL: 4th floor. TB5. Request for inspection of M&E services at 2pm today. @Kadapi J. PROMES . NSC PIC please stanby on site during inspection with RFI form and latest drawing.🙏🙏🙏

NSC GROUP

 Azman HKL: Site progress photo.
29/11/2023.
7th floor. TA2a. Slab cast.
Azman HKL: 4th floor. TB5. Slab rebar and M&E in progress.
Azman HKL: 3rd floor. Z7. Slab formwork in progress.
Azman HKL: 8th floor. TA1. Slab formwork in progress.
 Azman HKL: NSC please check this new layout for Hotel/Office.
King Hong- 1. WC position to riser. 2. Floor trap/gully trap height thickness conceal (due to slab thickness is 150mm)
Econmech - 1. Slab opening is any other than SPD, LPD and Sprinkler. 2. DCC - any slab opening other than an electrical riser room.

Please inform me or HKL if any by this week so we can provide slab openings. We target to cast the 8th floor by next week.
@Edwin Chen 013 @Dart Econmech @~LO KEAM
 Azman HKL: Target cast by next week.
 Azman HKL: Please confirm if this riser room needs opening.
Edwin Chen 013: Yes.
Azman HKL: Ok. Later this week forward us the details. Thanks.
 Dart Econmech: Yes. Drain pipe and exhaust duct
 Dart Econmech: @Azman HKL ada dwg cns transfer beam? L8 pnya beam
Lo. W. H (HKL-Site Engineer): 😒
Lo. W. H (HKL-Site Engineer): tower A L8 bukan transfer plate
Lo. W. H (HKL-Site Engineer): transfer floor d L15
 Dart Econmech: 🙏🏻😆 minta cns dwg mr lo
Lo. W. H (HKL-Site Engineer): lama saya tunggu kamu minta
 +60 12-843 3877: Installation trunking@leve2
 Azman HKL: 👆 CnS drawing. Tolong cek ya.
+60 12-843 3877: Wiring@level 4

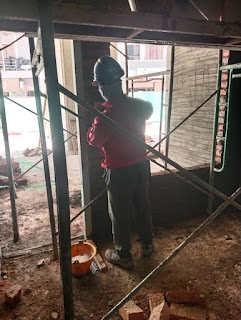

Azman HKL: @~.Fazli gambar 1. Hacking wall. Untuk report dlm meeting. @~Walker Yapi minta gambar kerja2 1. ducting 2. Wet riser, 3. Wiring 4. Sprinkler @HIDAYA KH office Num gambar, 1. Toilet wall hack, 2. CW/SW Piping 3. Water tank. Saya maw masuk dlm next week meeting ya. 👆
Azman HKL: Tolong ye..🙏🙏
+60 12-843 3877: 👌🏻

HIDAYA KH office Num: No.1

HIDAYA KH office Num: No. 2

 HIDAYA KH office Num: No. 3
Azman HKL: 👍🏻

Azman HKL: 4th floor. TB5. M&E services at slab inspection in progress.
Azman HKL: @HIDAYA KH office Num @Dart Econmech we discuss your pipe sleeve at this riser tomorrow. Get your drawing ready on site ya.
 Azman HKL: M&E slab inspection done. @Mr. Voo @+60 10-941 8970 please proceed.. 👌
 Azman HKL: Hi Julian from DCC. This is NSC EG Mall wasap group. Any drawing you require please inform this group. Latest Archi and CnS. M&E latest construction drawing we are still pending from Promes.
 +60 16-820 8374: Noted
Azman HKL: Latest Architect Drawing for reference.

EGMALL NSC (23 SEPT 2024)

  EGMALL NSC (23 SEPT 2024) [23/9/2024 9:24 AM] EG MALL Mr Lo: @HIDAYA KH office Num ft ya Sini thanks [23/9/2024 9:24 AM] EG MALL Mr Lo: ...
