Friday, September 29, 2023

30 SEP 23 HKL

SITE GROUP

Wiring in progress.Level 3&4

NSC GROUP
EG MALL Azman: Site progress photo.
30/09/2023.

Basement. Z4b. Slab casted.
 EG MALL Azman: 6th floor. TA1. Slab formwork and support scaffolding in progress.

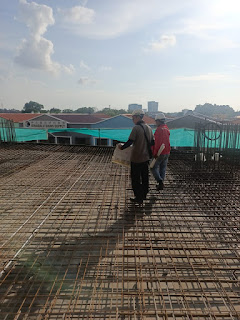

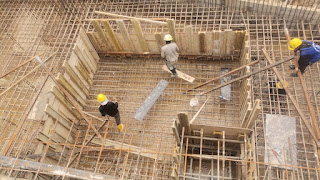

EG MALL Azman: 2nd floor. TA2. Slab rebar.
 EG MALL Azman: 1st floor. TB3. Slab formwork and scaffolding support in progress.
EG MALL Azman: Ground floor. TB4. Column formwork.

EG MALL Azman: Ground floor. TB5. Slab formwork and scaffolding support in progress.

 EG MALL Azman: Basement. Z5b. Retaining wall formwork and slab formwork in progress.
+60 17-866 0355: 3f
+60 17-866 0355: 3 th tarik wayar
+60 17-866 0355: 4th tarik wayar
+60 17-866 0355: man kami mau pasang Trang king boleh tolong cat ka sebab sini parking tiada siling
EG MALL Azman: Iya. OK. Nanti saya atur sama @~Roxas Ng (Kai) .
 Raymond Chong. Y. F (HKL P. Manager): NSC GO GO GO
+60 16-832 2597: Location mana?
+60 16-832 2597: Yg di tempat hari tu kita jalan tu?
HIDAYA KH office Num: 1st floor
HIDAYA KH office Num: Ground floor

EG MALL Azman: 3rd floor. Area nanti @~Leppong tunjuk sana tempat mereka pasang trunking.

EG MALL Azman: @~Rimon Joseph pastikan plastering surface rata n acceptable. Kalau rasa perlu panggil konsultan, tolong inform supaya kita boleh atur sana yeh.🙏🙏
 EG MALL Azman: 4th floor, sprinkler installation. 👆
+60 19-809 6068: 💪🏻 okay..
+60 12-843 3877: Wiring in progress.Level 3&4

30 SEP 23

Thursday, September 28, 2023

29 SEP 23 HKL

SITE GROUP

EG MALL Azman: 2nd floor. TA2. Request for inspection at 2.30pm. @Kadapi J. PROMES .
 EG MALL Azman: 5th floor. TA1. Lift wall opening. Mitsubishi on site to inspect the lift wall opening.

NSC GROUP

 EG MALL Azman: @⁨EG Mall Kin Hong Site Coord Chong SY⁩ @⁨EG Mall Plumber Leung WK - King Hong⁩ morning. Tolong atur tutup ini pipe. Maw timbun ini tanah skrg.
[08:29, 29/09/2023] EG MALL Azman: @HIDAYA KH office Num
 HIDAYA KH office Num: Okay2 boleh

 EG MALL Azman: Site progress photo.
29/09/2023.
2nd floor. TA2. Slab rebar and M&E in progress.
EG MALL Azman: 1st floor. TB3. Slab formwork and scaffolding support inprogress.
 EG MALL Azman: Ground floor. TB4. Column formwork in progress.
EG MALL Azman: Ground floor. TB5. Slab formwork and support scaffolding in progress.
 EG MALL Azman: Basement. Z5b. Retaining wall formwork closure and slab formwork  in progress
+60 12-843 3877: 2nd floor_conduit in progress
 +60 12-843 3877: 3rd floor-Wiring in prog
EG MALL Azman: 4th floor. z6. lift formwork and parapet wall..
Dart Econmech: @EG MALL Azman pls improve yr mosquito control on site. My site at elemen was given notice 1 week close due to mosquito and water stagnant. 🙏🏿
 EG MALL Azman: Thanks for advise. @Jimmy HKL .. 👆. 🙏🙏🙏
Dart Econmech: Welcome. 🙏🏿
 Jimmy HKL: noted will improve. tq

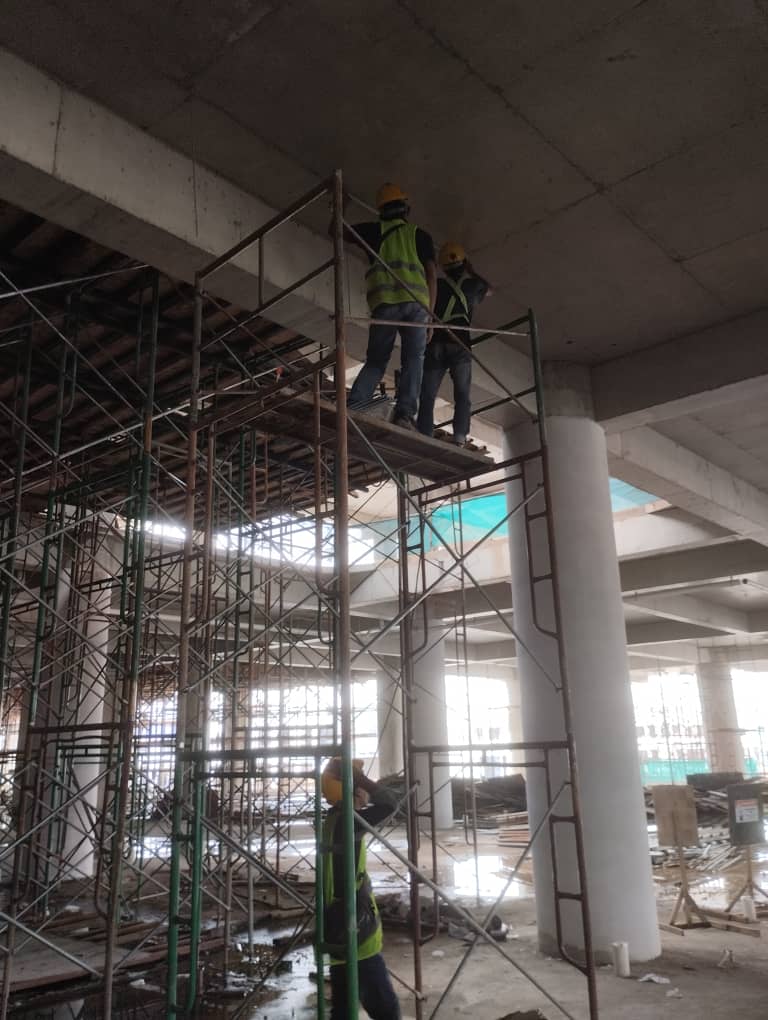

 EG MALL Azman: Mobile scaffolding training. Erecting training.
EG MALL Azman: 2nd floor. Zone TA2. M&E services inspection done. @Mr. Voo @~Nasri please proceed. 👌

29 SEP 23

EGMALL NSC (23 SEPT 2024)

  EGMALL NSC (23 SEPT 2024) [23/9/2024 9:24 AM] EG MALL Mr Lo: @HIDAYA KH office Num ft ya Sini thanks [23/9/2024 9:24 AM] EG MALL Mr Lo: ...
