Wednesday, August 16, 2023

17 AUG 23 HKL

NSC GROUP

Azman HKL: 17/08/23.
Site progress picture.
6th floor. 5a/5b. Slab formwork and beam rebar in progress.
Azman HKL: 3rd floor. TA1. Slab rebar & M&E in progress.
 Azman HKL: 6th floor. Zone 4. Slab formwork in progress.
Azman HKL: Ground floor. TA3. Slab formwork in progress.
 Azman HKL: Ground floor. TA3. Slab formwork. Basement, 8a. Column & staircase rebar in progress.
Azman HKL: 3rd floor. Zone 6. Column, parapet & liftwall in progress.
Azman HKL: Basement. Earthwork in progress.
Azman HKL: 5th floor. TB1. Column rebar in progress.
Azman HKL: Basement trunking in progress.
Raymond Chong. Y. F (HKL P. Manager): TA/1 3rd floor slab casting target on 20/08/23 Sunday
Azman HKL: 2nd floor, toilet room. SW pipe install at wall brick in progress
Azman HKL: Client meeting start..
 Dart Econmech: Proposed Econmech store 🙏🏿
 Dart Econmech: Pls advise @Azman HKL 🙏🏿

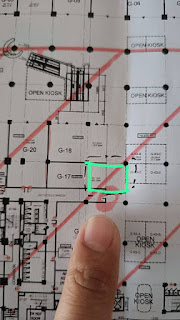

Azman HKL: Please take some picture that area. Itu sebelah kamu punya paip kan. Saya tiada masalah kamu pasang temporary opis di situ. @Raymond Chong. Y. F (HKL P. Manager) @Mr. Voo if any comment proposed Econmech temporary site office.
Azman HKL: Ini tempat bah kan.
 Dart Econmech: Yaa
Dart Econmech: Btul man 🙏🏿
Raymond Chong. Y. F (HKL P. Manager): Floor and G/L?
Dart Econmech: Grd floor, GL: 6-7 / G-H
 Raymond Chong. Y. F (HKL P. Manager): Kena check dulu
Dart Econmech: Ok noted





























No comments:

Post a Comment

EGMALL COORDINATION (26/6/2025)

   EGMALL COORDINATION (26/6/2025) [26/6/2025 4:41 PM] Azman HKL: Consultant commented. DCC ada orang maw rectify ini ASAP. 👏 [26/6/2025 4:...
