NSC GROUP
Azman HKL: @~LO KEAM morning. Hari ni kamu punya genset acoustic subcon datang pasang kan?
+60 19-895 9900: Ya
Raymond Chong. Y. F (HKL P. Manager): Azman, tolong monitor dan cordinate
Azman HKL: Okay. 👌
Azman HKL: Site progress picture.
9/8/23.

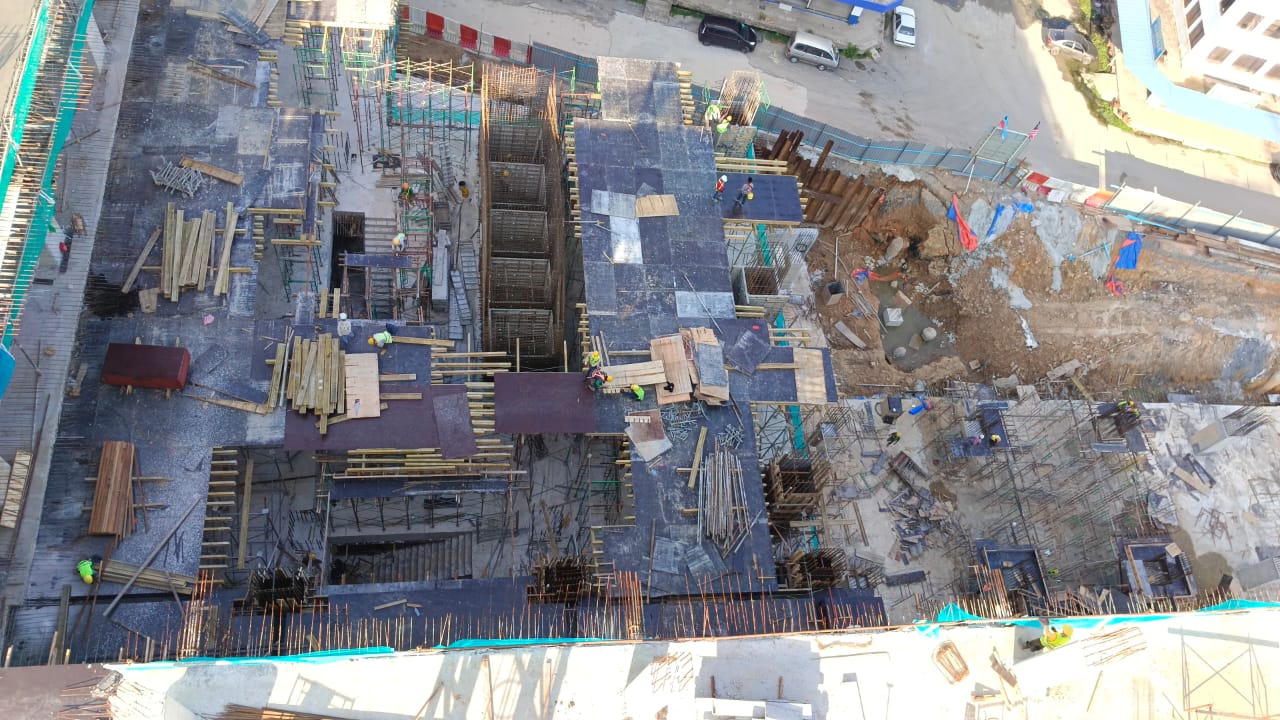

5rh floor. Zone 4. Slab cast.

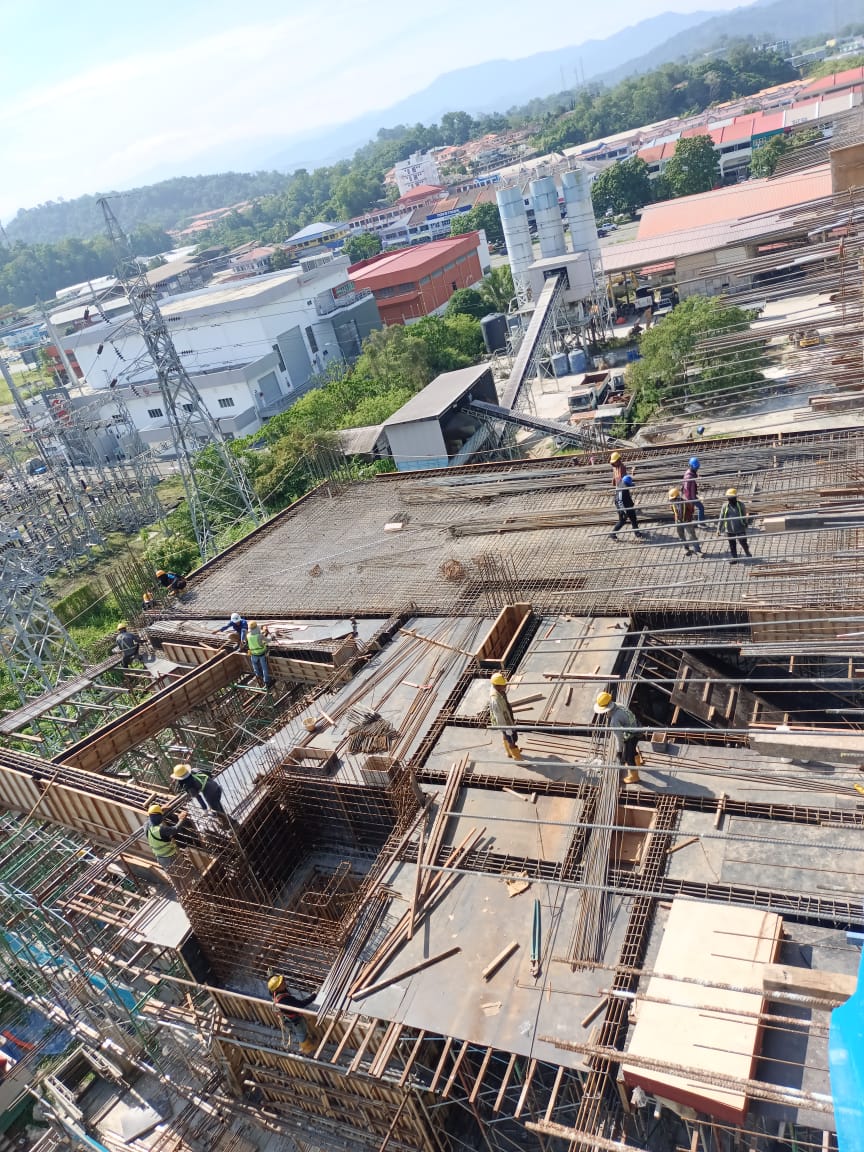

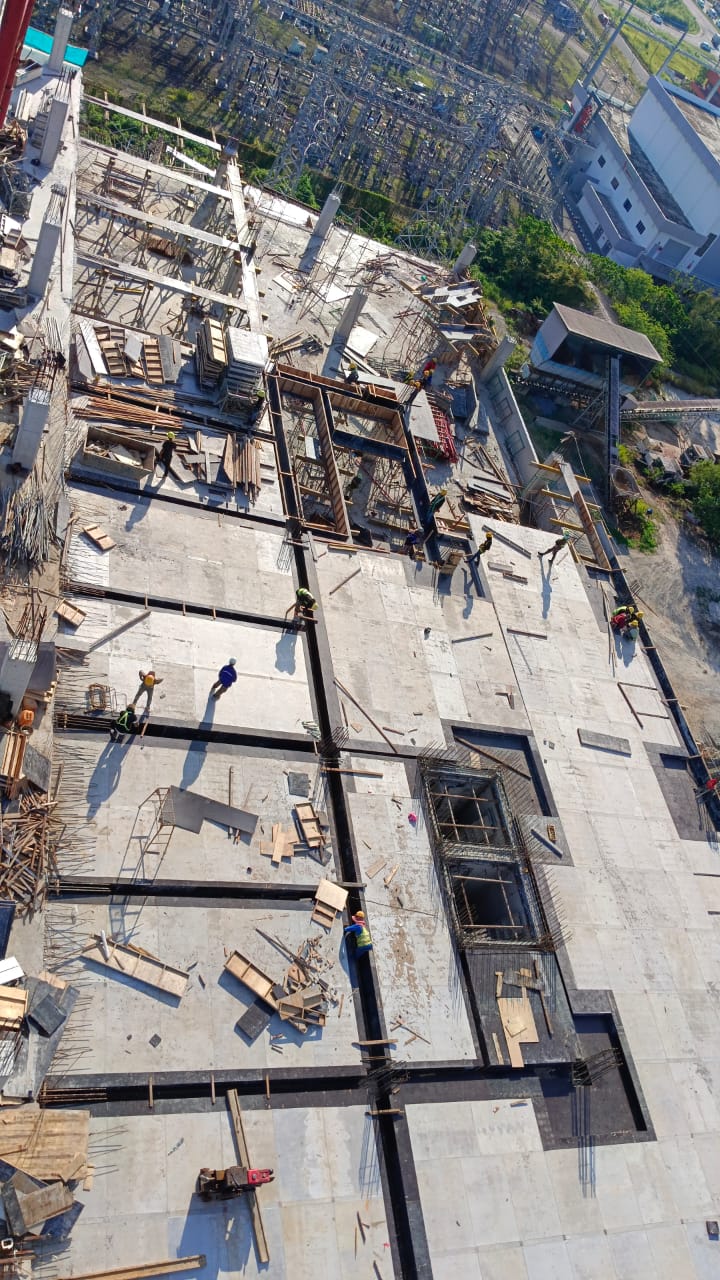

Azman HKL: 5th floor. 5a. Slab formwork & rebar in progress.
Azman HKL: 5th floor. 5b. Slab formwork in progress.
Azman HKL: 3rd floor. Zone 6. Slab rebar, formwork and M&E in progress.
Azman HKL: 3rd floor. TA1. Slab formwork, column/ lift wall rebar in progress.
Azman HKL: Basement. Slab foundation and earthwork in progress.
Azman HKL: Basement. Zone 8d. Slab foundation in progress.
Azman HKL: 1st floor. TB1. Slab formwork in progress.
Azman HKL: 5th floor. TB1. Slab formwork in progress
Azman HKL: Basement. Column slab formwork in progress.
Azman HKL: Basement 8a/b staircase formwork in progress.
Azman HKL: Sesb room. Wall brick and plastering work in progress.
Azman HKL: Basement, water tank room, slab screeding in progress.
Raymond Chong. Y. F (HKL P. Manager): we are casting 8D basement slab tomorrow, any earthing there?
+60 17-866 0355: tiada earthing bos
+60 17-866 0355: GL 12 baru ada earthing bos
Raymond Chong. Y. F (HKL P. Manager): 👍
Azman HKL: Casting Plan:
1) Zone 8D Basement slab - 10/08/23
2) ZoneTB2 1st Floor - 11/8/23
3) Zone 6. 3rd Floor - 11/8/23
4) Zone 5 6th Floor - 12/08/23
5) Zone TB/1 5th Floor - 14/08/23
6) Pile Cap G/12 - 11/08/23
7) Pile cap F/12 - 14/08/23
Please take note. 👆
