Lo. W. H (HKL-Site Engineer): @~YoonYK @Azman HKL recess position
Azman HKL: Site progress.
7/8/23.

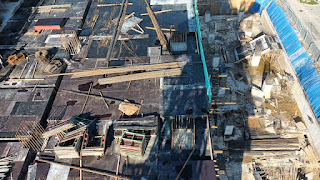

5th floor. Zone 4. Slab rebar & M&E works in progress.
Azman HKL: 6th floor. 5a. Slab formwork and scaffolding in progress. 5th floor lift wall cast.
Azman HKL: 6th floor. 5b. Slab scaffolding & formwork in progress.
Azman HKL: 3rd floor. Zone 6. Slab formwork and beam rebar in progress.
Azman HKL: 5th floor. Zone TB1. Slab formwork in progress.
Azman HKL: 3rd floor. Zone TA1. Slab formwork and 2nd floor lift wall in progress.
Azman HKL: Basement 8a. Staircase formwork in progress.
Azman HKL: 1st floor. TB2. Slab formwork in progress.
Azman HKL: Basement. Earthwork & slab foundation in progress.
Azman HKL: 5th floor. Zone 4. Slab rebar & M&E in progress.
Azman HKL: @Leung KH๐ @~Walker Yapi kamu punya item sudah siap kan? 5th floor, zone 4.
Azman HKL: @~Walker Yapi tolong submit RFI ya kalau sudah siap ni slab. ๐๐๐
+60 14-379 2990: Noted..
