Kadapi J. PROMES: G morning. Aku masih cuti aa. Blum recover lagiπ₯
Dart Econmech: Smoga cpt sihat bos
Azman HKL: @Dart Econmech @Leung KHπ please check your services at this area if any.. slab cast plan by today. ππ
Azman HKL: 4th floor. 5b. M&E done inspection.
NSC GROUP

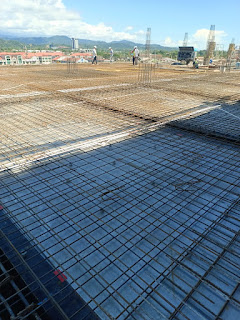

Azman HKL: Good morning. Site Progress picture. 10/7/23. Basement. 8a. Retaining wall rebar and formwork in progress.
Azman HKL: 4th floor. 5b. Slab rebar and M&E in progress.
Azman HKL: 4th floor. TB1. Slab formwork in progress.
Azman HKL: 4th floor, 4a. Lift formwork and 5th floor slab support in progress.
Azman HKL: 4th floor. Zone 4. Slab formwork in progress.
Azman HKL: 1st floor, TA1, lift rebar and formwork, 2nd floor slab formwork support in progress.
Azman HKL: Any pipe sleeve at the retaining wall please install by today before the wall formwork starts. @Leung KHπ πππ
Raymond Chong. Y. F (HKL P. Manager): 5/a
Raymond Chong. Y. F (HKL P. Manager): this slab target casting 15/07/23
Raymond Chong. Y. F (HKL P. Manager): casting today
Azman HKL: All NSC to take note:
1) Zone 5/b - 4th floor casting today
2) Zone 4 - 4th floor target casting 15/07/23
3) Zone TB/1 - 4th floor target 13/07/23
4) Zone 8A Basement RC Wall - target casting 14/07/23
5) Zone TA/1 - 2nd floor target casting 20/07/23
Raymond Chong. Y. F (HKL P. Manager): 6) Zone 8B Basement slab target 20/07/23
Azman HKL: @Leung KHπ check if any dropper pipe here. π
Leung KHπ: Yes boss ππ»
Leung KHπ: Done boss tqππ»
+60 12-843 3877: Wiring
Level:besment
Azman HKL: @~Walker Yapi angkat itu bata dulu. Nanti sambung balik paip.
+60 14-379 2990: ππ»..
+60 14-379 2990: Tiada masalah man.. ππ»
