Azman HKL: Site progress picture.
16/06/2023.

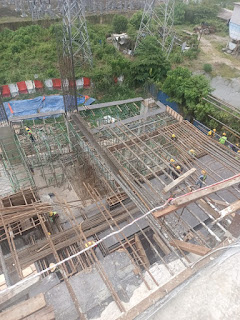

3rd floor. Zone4. Slab rebar and M&E services in progress.
Azman HKL: 3rd floor water tank plinth in progress.
Azman HKL: 1st floor. Slab formwork and beam rebar in progress. Lift wall formwork in progress.

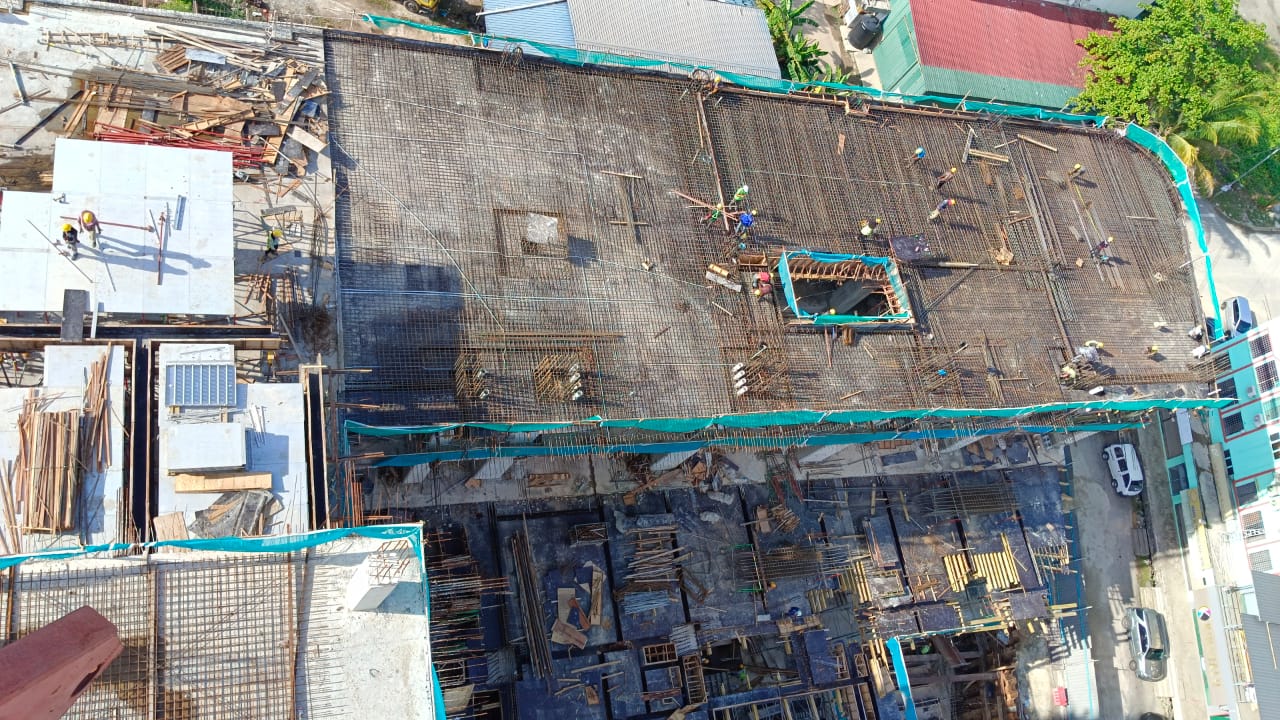

Azman HKL: 4th floor. Slab formwork in progress.

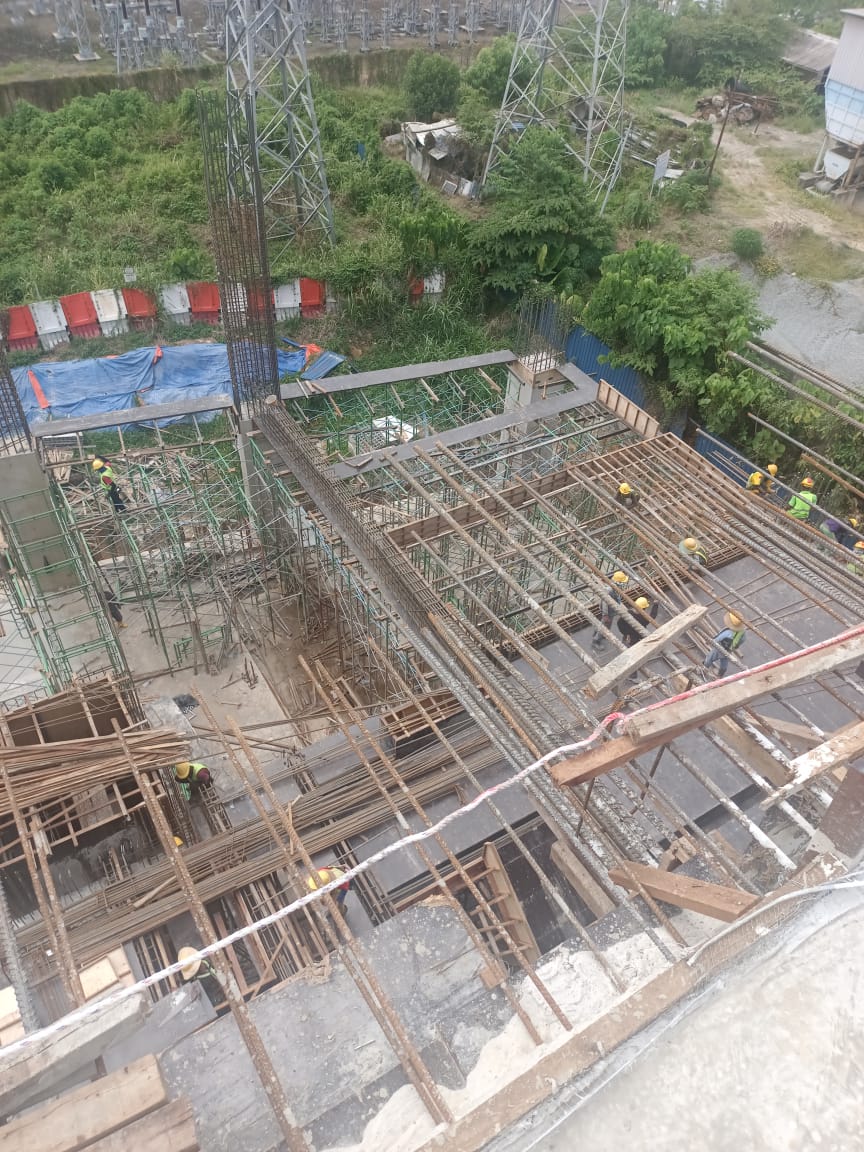

Azman HKL: 3rd floor. Zone TB1. Slab rebar in progress.
Azman HKL: Basement slab foundation. Rebar in progress.
Azman HKL: 1st floor. Zone 6. Slab beam formwork in progress.
Azman HKL: Grd flr..AHU room plaster base
Azman HKL: Basement zone 3. Fire water tank plinth in progress.
Azman HKL: Casting plan
TB/1, 3rd floor target 21/06/23. Please take note.
Azman HKL: Pre inspection M&E services at the 3rd floor. Zone 4.
Azman HKL: Basement Pump sump marking
Azman HKL: Ejector pump sump marking.
