Azman HKL: Remind all NSC, next time, please check your inspection form request before submitting. Signature, date, and detail approved shopdrawing. Make it proper. Make your own list of submissions for reference number. 🙏
NSC GROUP
Azman HKL: Site progress picture.

29/05/2023.
6th floor.

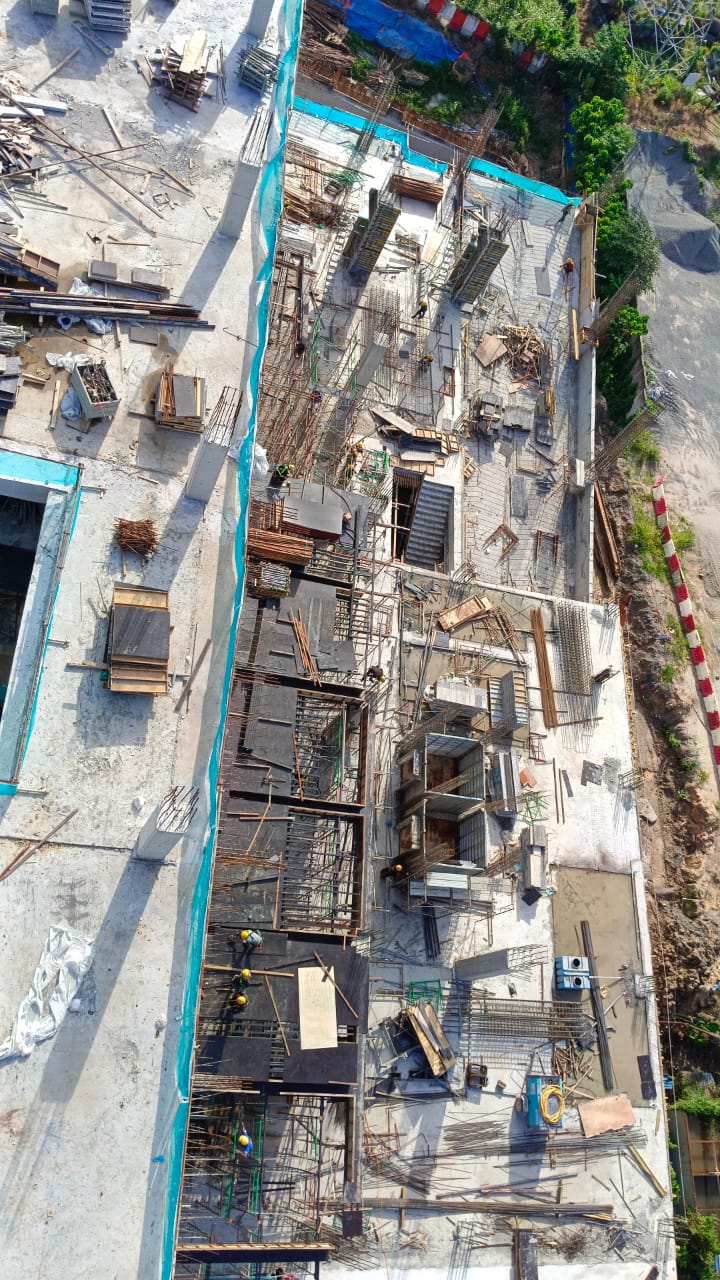

Azman HKL: 2nd floor. Zone 4. Scaffolding support. Rebar work in progress.
Azman HKL: 2nd floor. Zone 5. Column rebar in progress. 3rd floor. Slab formwork in progress.
Azman HKL: 2nd floor. Slab rebar in progress.
Azman HKL: Basement 7B. Scaffolding for ground floor support in progress. 7C. Slab foundation rebar in progress.
Azman HKL: Ground zone 5. Scaffolding and slab rebar in progress.
Azman HKL: Basement. The sanitary pipe runs at a high level in progress.
