SITE GROUP
+60 14-379 2990: @Azman HKL just proceed yaa.. ECM tiada item area sini
Leung KHπ: KH Pipe Sleeve done
Kadapi J. PROMES: Only can proceed for official inspection after the rebar done.

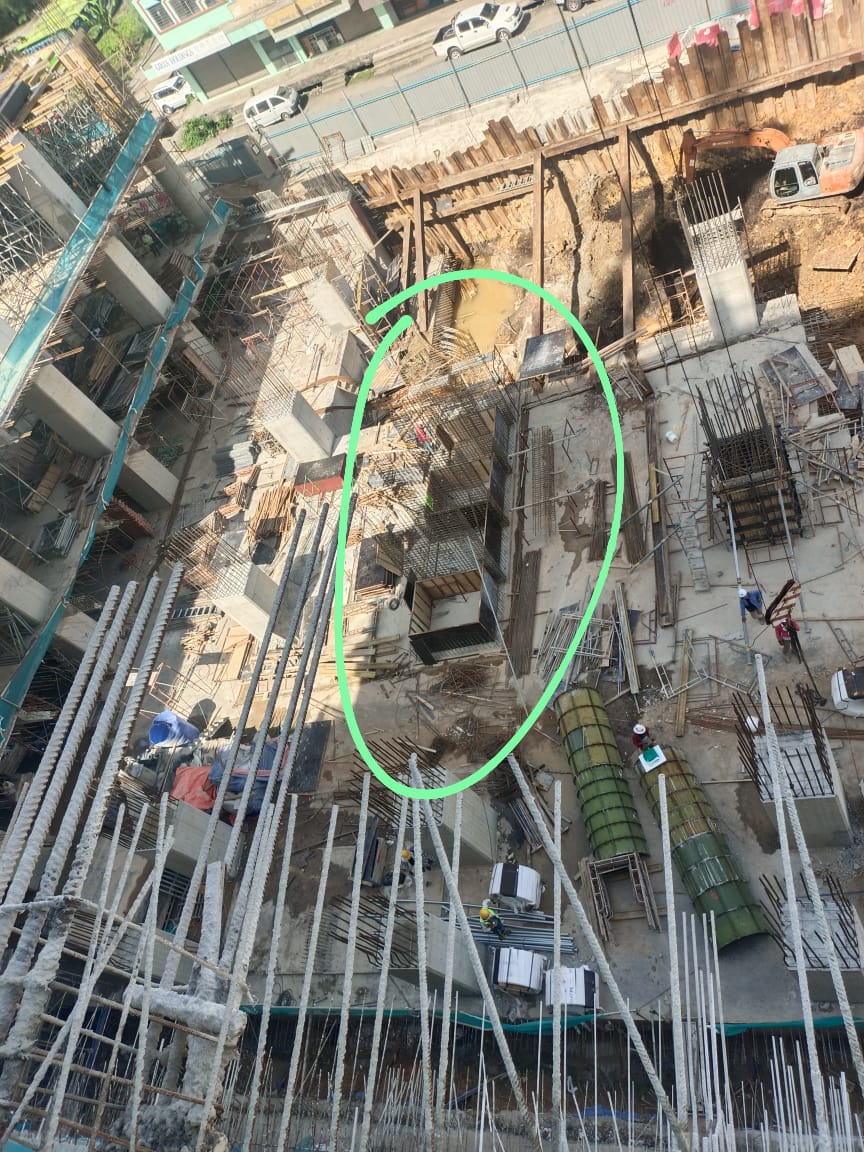

Azman HKL: @Kadapi J. PROMES request for inspection. Tomorrow 9.30am. Ground floor slab. D-F/10-11. π
NSC GROUP
Azman HKL: @~Walker Yapi @~DartWeirdo π²πΎ ground floor sacffolding slab in progress. Please double check and coordinate to make sure your equipment can be placed in the room as we discuss. πππ€²π»
Azman HKL: Good morning.
Progress picture report. 29/04/2023.

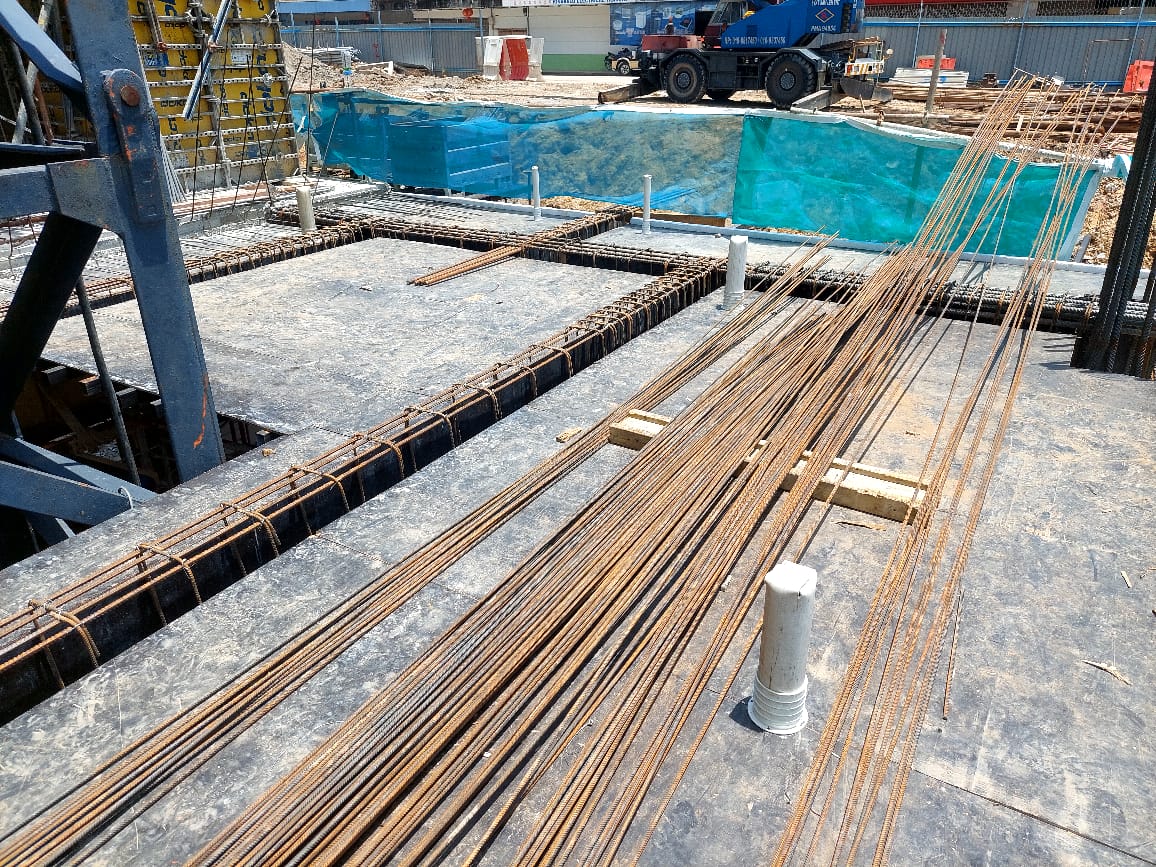

2nd floor slab formwork and beam rebar in progress.
Azman HKL: 2nd floor. Zone 4. Slab formwork.
Azman HKL: Basement zone 2. Beam and slab for ground floor support scaffolding in progress.
Azman HKL: Ramp 3. Column rebar & lighting conduit in progress.
Azman HKL: Basement zon 5a. Retaining wall rebar, column rebar, lift pit wall in progress.
Azman HKL: 1st floor, slab formwork and column rebar in progress.
Azman HKL: Basement brick wall in progress
Azman HKL: Staircase 7
Azman HKL: Transformer room.
+60 14-331 3232: Siapa punya barang d ground floor..tolong kasi pinda..sy mau setting bata..tq
Azman HKL: @~Walker Yapi ππππ
+60 14-379 2990: Ok.. Boleh Mana area yg free boleh sy simpan ni barang? @Azman HKL
Azman HKL: @~YoonYK you want to come check after all that lift formwork done? Office n hotel lift pit.
+60 19-821 8251: Sure, will check on tuesday. π
Azman HKL: Bomba lift pit at the supermarket area.
+60 14-331 3232: Sini ko boleh simpan
+60 14-331 3232: Ground floor start setting brick layer suda
Raymond Chong. Y. F (HKL P. Manager): @~YoonYK every how many floors will u be checking the lift core wall verticality?
Raymond Chong. Y. F (HKL P. Manager): 3 or 4?
+60 19-821 8251: Currently we unable to check the verticality, only the lift shaft dimension as verticality check we need to conduct from the top floor.
Azman HKL: Casting plan besok?
Azman HKL: Casting plan bsok. Tolong check on site. @~Walker Yapi @~. @Leung KHπ .
Azman HKL: @~ShawnChia cuba tgk boleh siap pasang paip bsok ka?
Raymond Chong. Y. F (HKL P. Manager): Ok
Azman HKL: Bottom rebar in progress..
Leung KHπ: Done
Azman HKL: Tolong post sana coordination bah. Ada consultant. π
Azman HKL: @~ShawnChia subcon will make bottom bar ready at 3pm. Please arrange.. π
Azman HKL: @~Leppong @~. tolong take note.π.. please.....
+60 17-866 0355: Ok man
Azman HKL: Please submit RFI. π
+60 12-843 3877: Installation pvc conduit for ELE/LV in prog@gfl
+60 12-843 3877: Instalation pvc conduit @gfl done
