SITE GROUP
Azman HKL: Morning. @E@~YoonYK. Can come to check this lift pit opening by today. TQ.
Azman HKL: BL1. Office lift..
+60 19-821 8251: Noted will do.
Azman HKL: Morning. Site progress pic.
14/4/23.
6th floor.

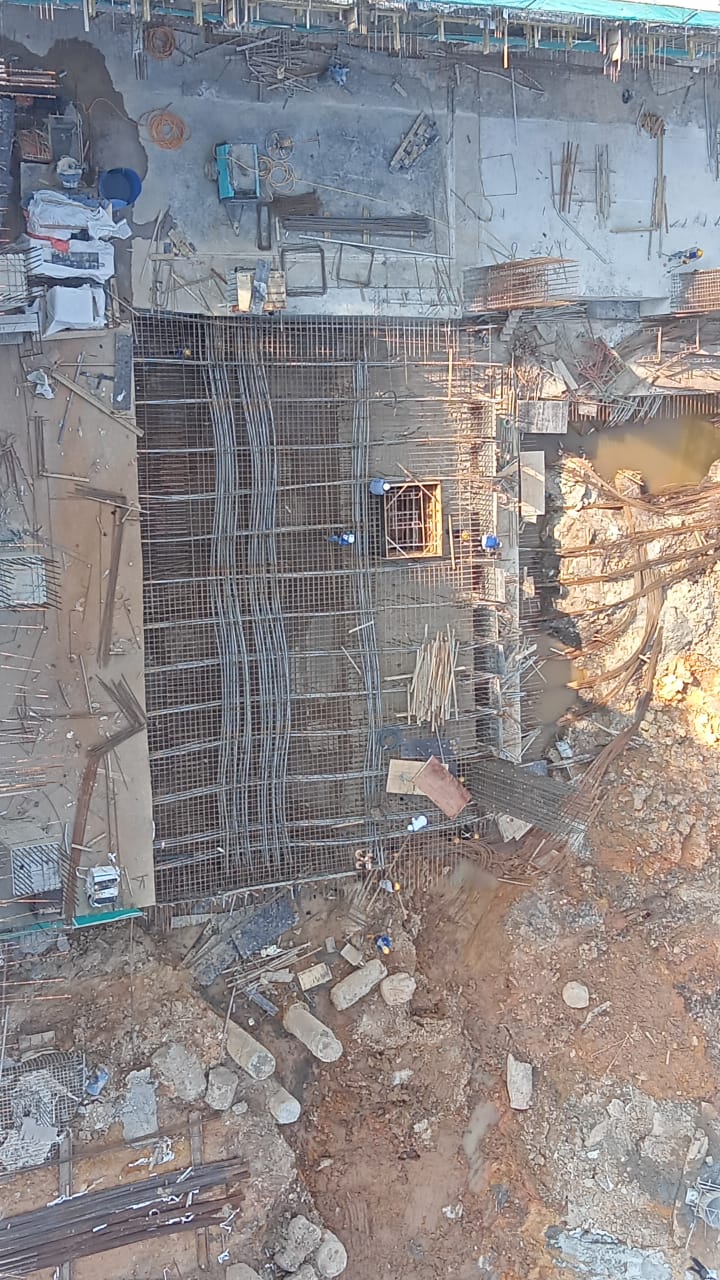

Azman HKL: Basement zone 2&3. Basement foundation rebar and lift pit formwork in progress.
Azman HKL: 1st floor. Zone 4. Column rebar in progress.
Azman HKL: 2nd floor. Ramp3 rebar in progress. Conduit at ramp in progress. Slab formwork in progress.
Azman HKL: Basement. Zone 5a. Slab rebar and plinth rebar in progress. Sump pit and lift pit in progress.
Azman HKL: Ground floor. Zone 11. Slab beam rebar in progress.
+60 12-833 6147: 👍🏼
Azman HKL: Site PIC. Please check your pipe sleeve or put some extra protection. Cover the pipe to block incoming soil. Earth backfilling in progress.
Azman HKL: Tutup semua sudah
Azman HKL: Basement zone5a. M&E inspection done.
NSC GROUP
Azman HKL: Ramp 3. Casting plan on wednesday.
Azman HKL: Basement. Zone 1. Brickwall in progress.
Azman HKL: Casting plan by today.
Raymond Chong. Y. F (HKL P. Manager): Ground floor Zone 11 at TC2 casting next Monday
Raymond Chong. Y. F (HKL P. Manager): @Edwin Chen 013 👆
