SITE GROUP
Azman HKL: Good morning.
Casting Plan:
1. Basement. Zone 1D/B RC walls on next Wednesday 15/02/23
2. 6th Floor Zone 1 on next Thursday 16/02/23
All M&E NSC please be informed and prepared.

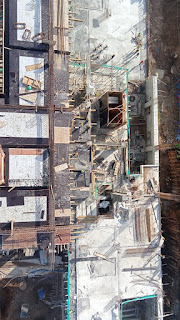

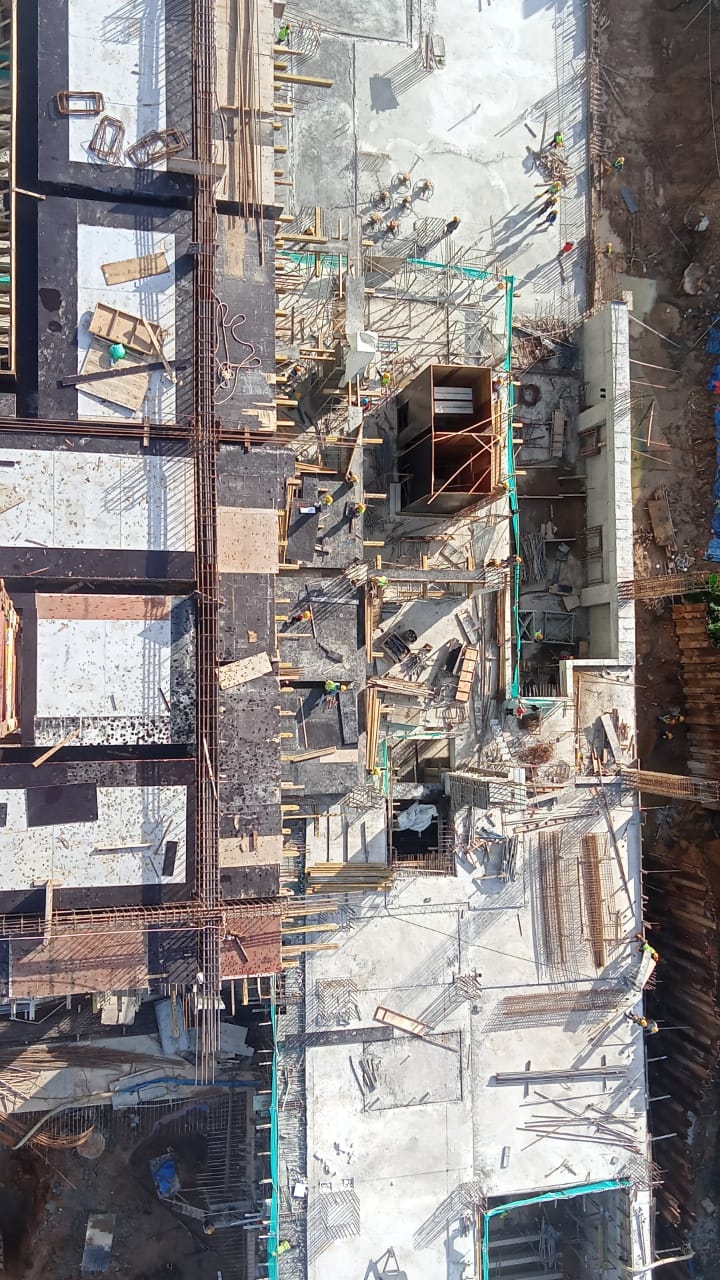

Azman HKL: Site progress. 11/02/2023

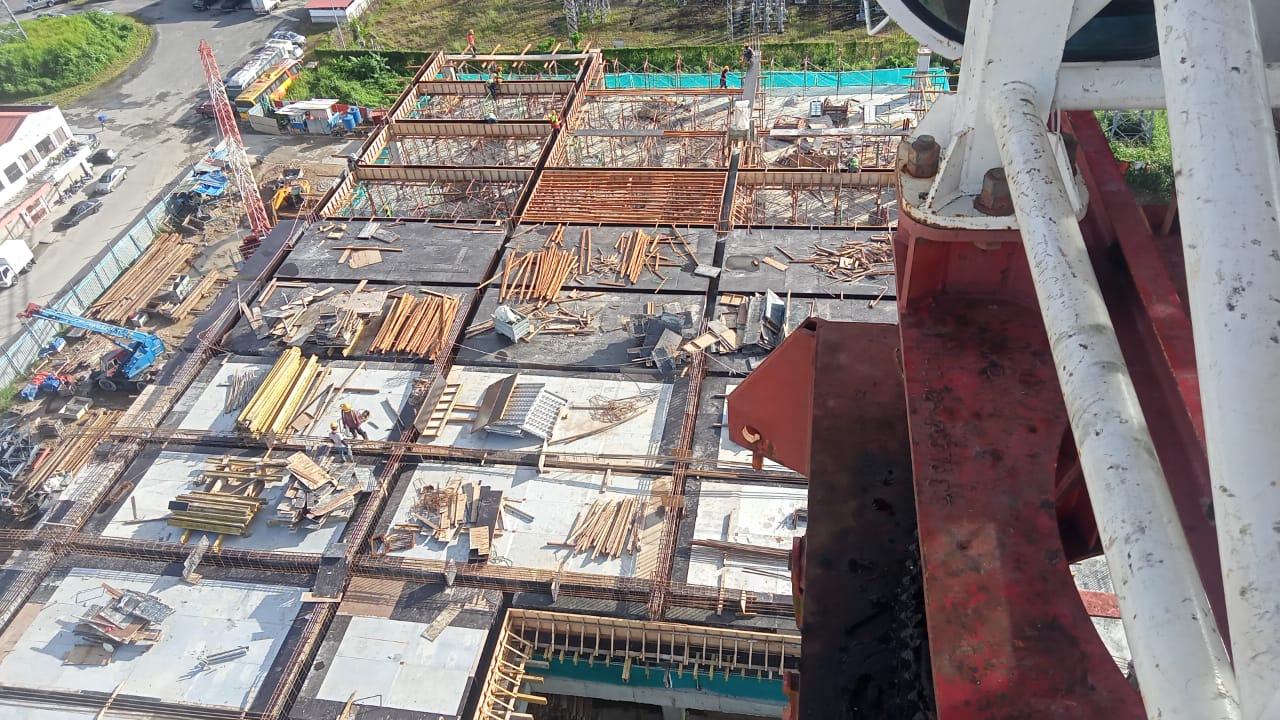

6th floor. Slab and beam rebar in progress.
Azman HKL: 6tg floor. Slab & beam formwork in progress
Azman HKL: Basement. Zone 2&3. Earthwork in progress.
Azman HKL: 1st floor. Zone 1C. Formwork and beam rebar in progress. Ground floor. Lift pit formwork in progress & column rebar in progress.
Azman HKL: Ground floor. Zone 1&2. Column rebar in progress
Azman HKL: Basement. Zone 1D. Wall rebar in progress. Column rebar in progress
Azman HKL: @YoonYK monday can come to site to check this lift pit Dimension & escalator opening.
Azman HKL: I measured on site. 9520x7280. Later I asked subcon to adjust a bit to follow Escalator shopdrawing. @YoonYK monday you can come to double check.👌
+60 19-821 8251: Noted will do.
No comments:
Post a Comment
