GL : H/11
GL : G/9
1st floor lighting point inprogress..
Basement water tank. Column in progress.. NSCs please check your item on column. TQ.

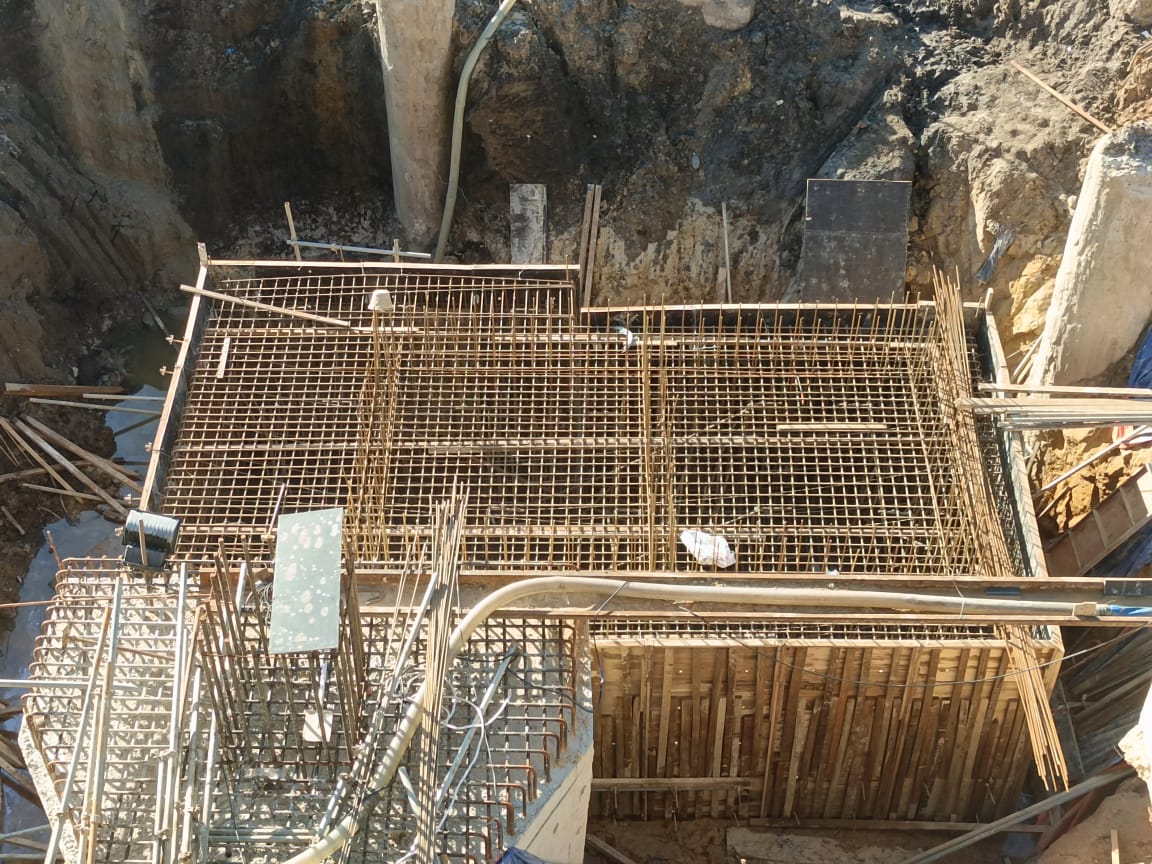

Lift pit Pile cap in progress..
GL: F-I/11, beam rebar & formwork inprogress.
NSCs, GL: F-I/7-9, can proceed install your item. Target casting by tomorrow 26/10/2022. Cant wait any longer. Any obstruction on site please report here.
Supervisor please actively post on site condition. Take picture during installation and after completing. Share here in group.
GL: F-I/9-11. Beam rebar in progress..
Site Progress. 25/10/2022.
1st floor. GL: F-I/7-11.
2nd layer in progress.
SITE group
Second layer rebar ......
No time for MnE ?
DCC & KH on site start installing M&E item.
