Tuesday, February 28, 2023

01 MAR 23 HKL

SITE GROUP


 +60 17-866 0355: LV 1






NSC GROUP
 +60 17-866 0355: LV 1  conduit dapat pasang
+60 17-866 0355: Belum boleh pasang conduit
 +60 17-866 0355: LV 1
Azman HKL: 😫
Azman HKL: Sy bincang sama PIC. @Leppong tolong inform apa2 yang outstanding lagi nanti. πŸ™πŸ€²πŸ»



01 MAR 23




































Monday, February 27, 2023

28 FEB 23 HKL

SITE GROUP

Kadapi J. HKL: Azman / Eddy, Jgn lupa ground floor (TJ) point d gridline K-L/9-12
+60 16-837 8881: πŸ‘πŸ»


NSC GROUP

Azman HKL: 1th m&e boleh masuk lepas 10am
Azman HKL: NSC please check slab.. 1st floor.
Azman HKL: Latest casting plan.

Friday(3/3/23) - Predestrian Ramp & 1st floor slab.

Saturday(4/3/23) - ground floor slab.

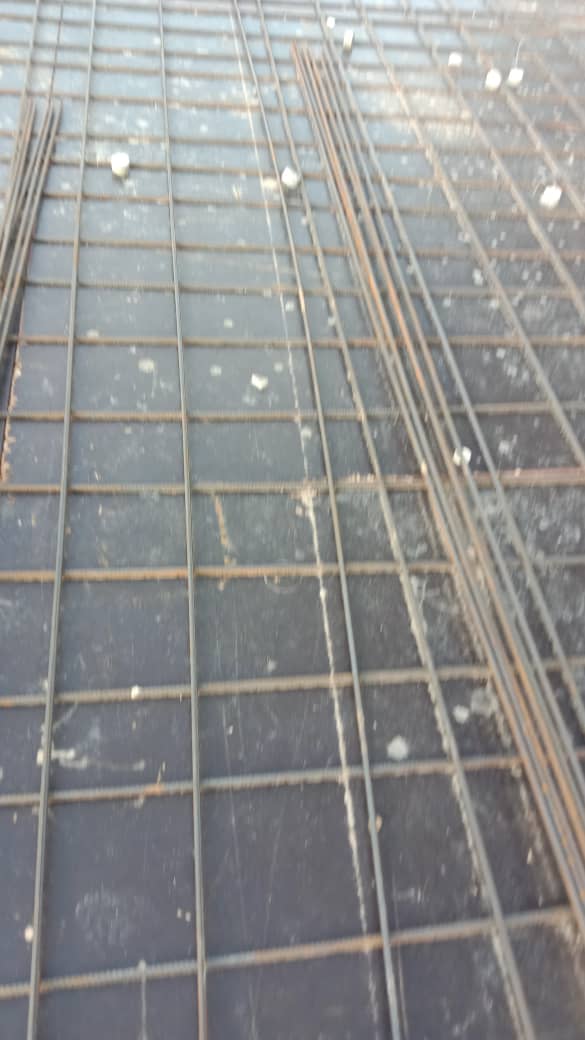

+60 10-941 8970: 1st floor slab bottom bar progress I-K/5-7 progress
 +60 10-941 8970: @Azman HKL bfore top bar was install at this area plss ask them to install conduit, almost 99%bottom bar Done at 1st floor zone 1Da thank you
Azman HKL: Noted bossku. NSC stanby at ground floor waiting for the slab bottom bar completed. @shawnstchia @Leung KHπŸ€ @Walker Yapp @YoonYK
 +60 16-837 8881: πŸ‘ŒπŸ»

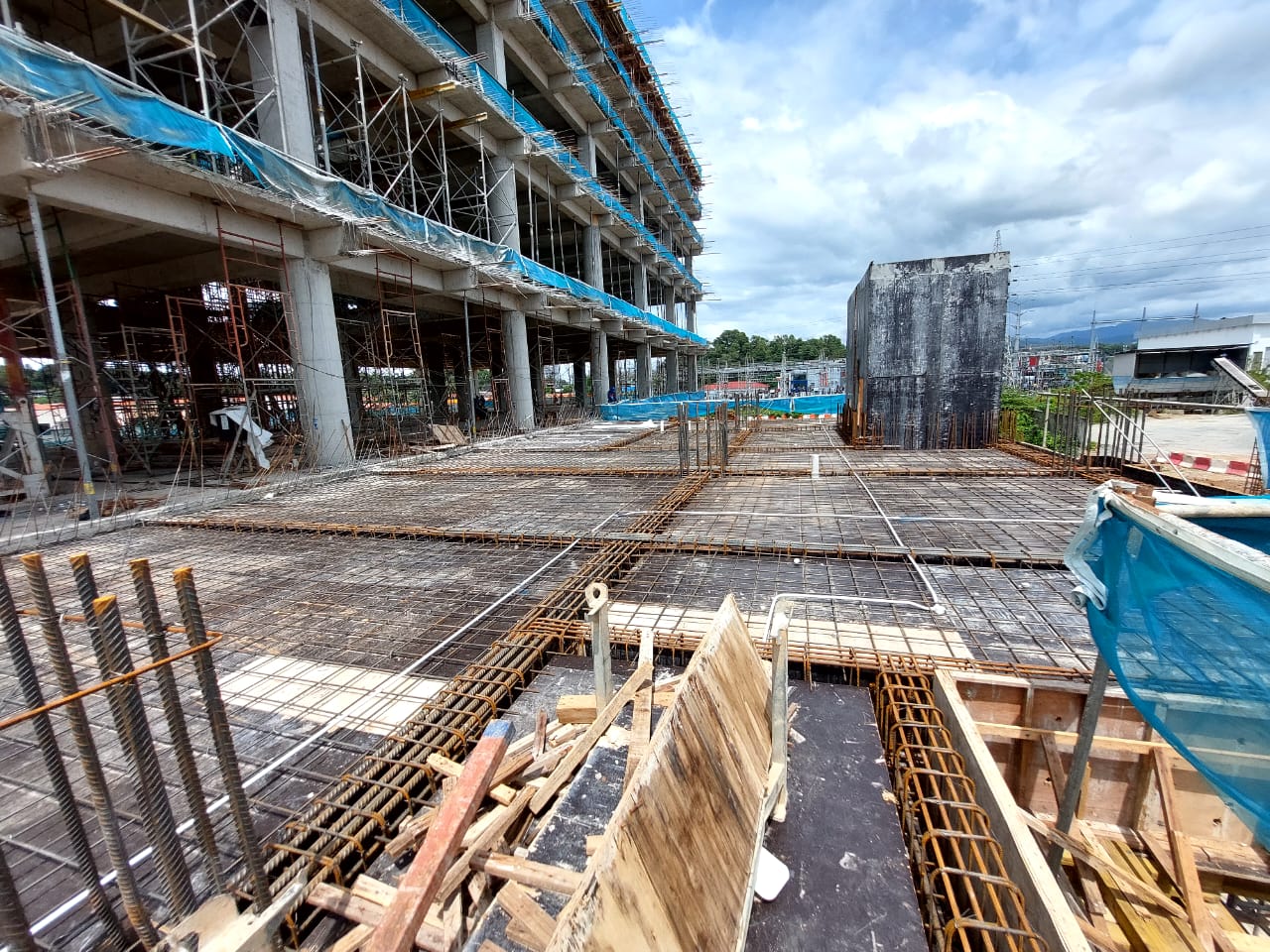

 Azman HKL: Site progress. 28/2/2023
6th floor. Column rebar inprogress.
.

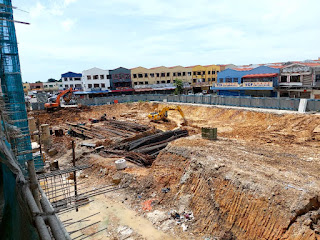

Azman HKL: Basement. Zone 2&3. Earthwork and cutting bore pile in progress.
 Azman HKL: Basement zone 1&2. Column rebar closure in progress.
Azman HKL: Zone 1. 1st floor. Slab rebar in progress. Bottom rebar almost done.
Azman HKL: Zone 1D. Ground floor. Slab rebar in progress
 Azman HKL: 1st floor. Bottom rebar in progress.
Azman HKL: Zone 1D. Ground floor rebar in progress.
Azman HKL: Ground floor. Predestrian ramp in progress.
Azman HKL: Staircase 8. In progress.
 +60 12-843 3877: Ribar first layer still in prograss
Azman HKL: @Nasri πŸ™πŸ™πŸ‘†πŸ€²πŸ»bottom layer..masih lagi 99%.. bsok M&E masuk.
